NOTICE OF MEETING
Notice is hereby
given, in accordance with the provisions of the Local Government Act 1993 that
a Meeting of Operations Committee
will be held in the Council Chambers,
EMERGENCY EVACUATION FOR COUNCIL MEETINGS HELD IN
THE COUNCIL CHAMBERS
In case of an emergency, for example a fire, please
evacuate the building via the marked exit doors (Mayor points to the doors).
The order to evacuate may be signified by an alarm siren or by a Council
officer or myself. Please proceed to the
green “emergency assembly area” signs either near the cycleway on
AGENDA PAGE
Apologies
Confirmation of Minutes
1. Operations
Committee 4/02/2008
Mayoral Minute
Disclosures
and Declarations of Interest
Withdrawal
of Items and Late Items of Business
Presentation Item
No. 2/08
1. Tennis
Australia
Public
Access Session
Director Operations
Report No. 3/08
1. 2008
NSW Local Roads Congress
2. Council
Seal - Gowrie Street Mall Redevelopment -
Manager
Community Services Report No. 3/08
1. Community
Development Report February 2008
2. Youth
Programs
3. Colleen
Gale Children's Centre Working Group Meeting
4. Colleen
Gale Children's Centre
Manager Library
Report No. 1/08
1. Library
Quarterly Report
2. Prime
Minister's Summit
3. Archives
Collection
4. Digitisation
of Newspapers
1. Tennis
2. Minutes
for Singleton Combined Horse Sports Ground Steering Committee - 13 February
2008
3.
4. Playground
Capital Works
5. Minutes
- Senior
6. Minutes
- Sedgefield Cemetery Improvements Working Group - 12 February 2008
7. Singleton
Gym & Swim Advisory Committee Minutes - 13 February 2008
8. Gym
& Swim Five Year Capital Works Program
9. Council
& Community Buildings - Five Year Capital Works/Heavy Maintenance Program
10. Recreation & Landscaping (Parks) - Five Year Capital Works
Program/Heavy Maintenance

Manager Water and

Waste Report No. 3/08

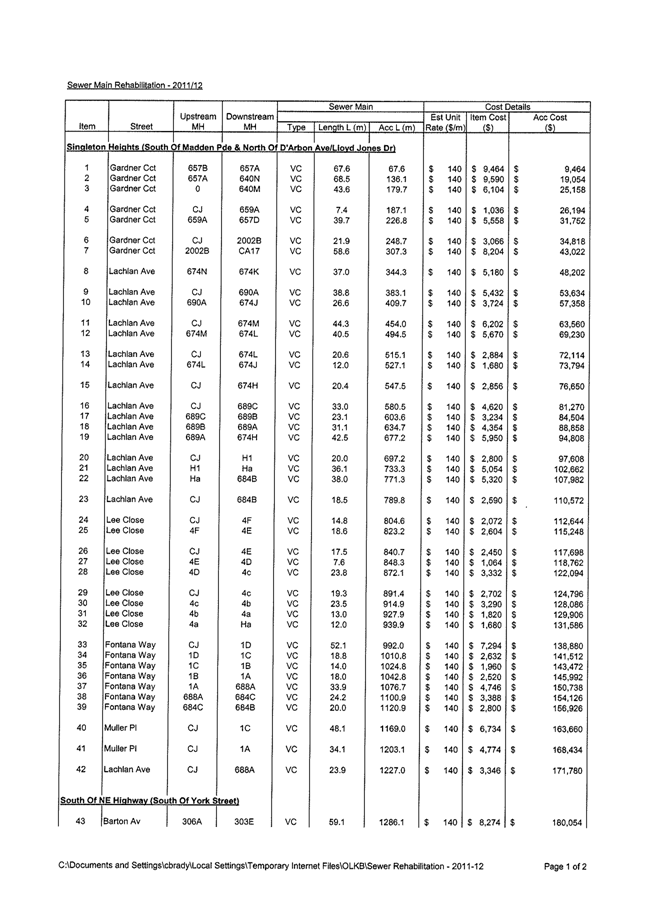

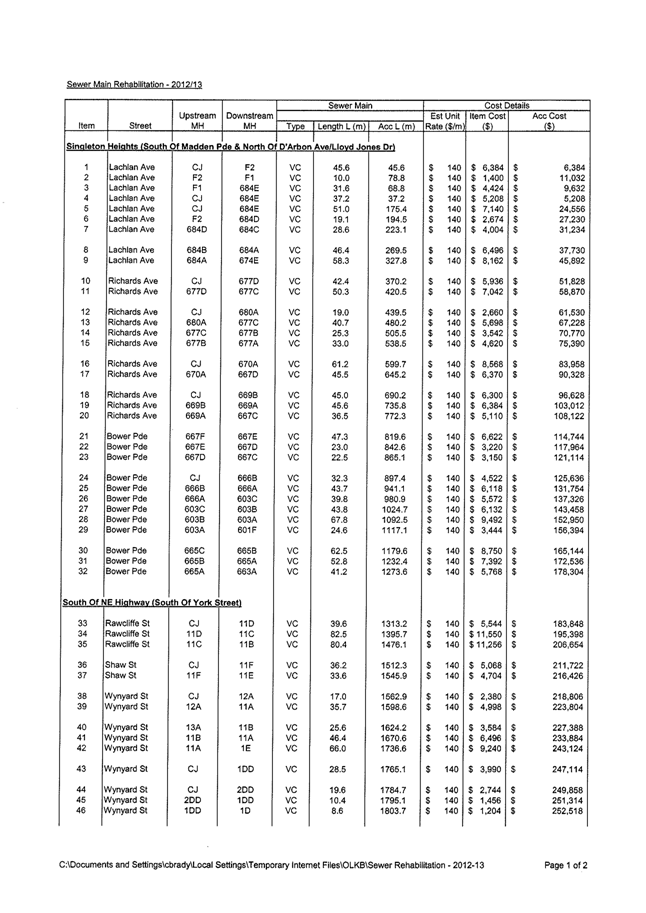

1. Sewer
Five Year Capital Works Program

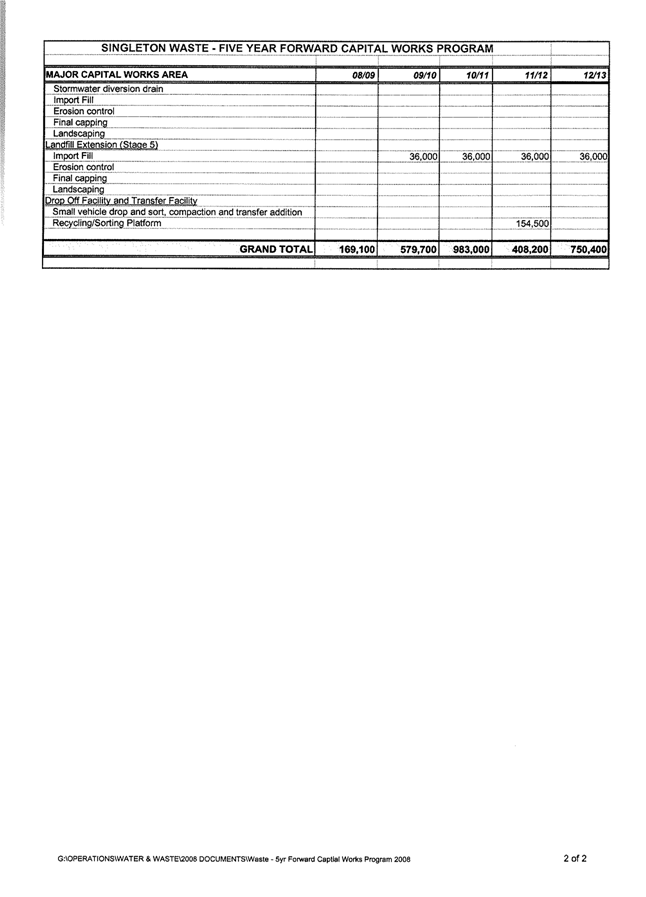

2. Waste
Five Year Capital Works Program
3. Water
and Sewer Reports - 01/01/2008 - 31/01/2008
4. Non-Residential

Sewer and Liquid Trade Waste Pricing
5. Water
Five Year Capital Works Program
Manager
Design and Contracts No. 2/08
1.
2. Design
& Contracts Program Area - Jobs in Progress
Manager Works Report
No. 2/08
1. Works
Program Area Maintenance and Construction
2. Bitumen
Resealing Program
3. Paved
Footpath Construction Program
4. Kerb
and Gutter Construction Program
5. Minutes
of Local Development Committee Meeting 19 February 2008
6. Minutes
of Local Traffic Committee Meeting - 19 February 2008
7. 2008/2009
Local Roads Improvement Program
8. Plant
Tenders
9.
Questions of Which
Notice Has Been Given Report No. 4/08
1. Questions
of Which Notice Has Been Given
Questions
Without Notice in Writing
Committee of the Whole
GENERAL
MANAGER
Singleton
Council’s Vision Statement is:
“Singleton. A progressive community of excellence and
sustainability”
Singleton
Council’s Mission Statement is:
“To provide quality services to the community in an
efficient and friendly manner encouraging responsible development”
Singleton
Council’s Core Values are:
|
Value |
Definition |
· |
Service |
Putting the needs of customers first and achieving
excellence in customer service; |
· |
Consistency |
Having a professional approach to work with the
highest ethical standards and a businesslike manner across the organisation; |
· |
Focus |
Maintaining a clear focus on the vision and agreed
goals; |
· |
Respect |
Earning and retaining the respect of the community; |
· |
Pride |
General pride in works and services; |
· |
Communication |
Excellence in communications; |
· |
Achievement |
Developing a well trained, motivated and focussed
staff and elected Council; |
· |
Equity |
Being a fair and equitable employer and provider of
services; |
· |
Reliance |
Ensuring that the community, elected Council and
staff can rely upon each other; |
· |
Commitment |
Displaying commitment and cohesion between
community, elected members and staff; |
· |
Efficiency |
Services provided by the organisation are to be
carried out with the efficient allocation of resources; |
COUNCIL POLICY
Council adopted a Code of Conduct
which provides details of statutory
requirements and gives guidance in respect of the way in which pecuniary and
conflict of interest issues should be approached.
Generally, the policies refer to the
following issues:
1. Councillors
are under an obligation at law to disclose any interest they may have in any
matter before the Council and to refrain from being involved in any
consideration or to vote on any such matter.
2. Councillors
must disclose any interest in any matter noted in the business paper prior to
or at the opening of the meeting.
3. The
nature of the interest shall be included in the notification.
4. Councillors
shall immediately and during the meeting disclose any interest in respect of
any matter arising during the meeting which is not referred to in the business
paper.
5. All
declarations of interest shall be recorded by the General Manager.
6. All
disclosures of interest shall as far as is practicable be given in writing.
7. Any
member having an interest shall leave the meeting and remain absent while the
subject of the interest is being considered by Council.
8. The
meeting shall not discuss any matter in which a councillor has an interest
while the councillor is present at the meeting.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Presentation
Item No. 2/08 |
|
|
1. |
Tennis Author: Alan Fletcher |
FILE: 01/0373 |
Mr David Eland - General Manager Tennis NSW and Hamish Neal - Community Tennis Officer Northumberland Region Tennis NSW will be giving a presentation on the future of tennis in Regional NSW. |
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Director
Operations Report No. 3/08 |
|
|
1. |
2008 NSW
Local Roads Congress Author: Gary
Woodman |
FILE: 04/0022 |
Executive
Summary: Council is a member of the NSW Roads and Transport
Directorate. The Directorate has arranged the NSW Local Roads
Congress which is to be held in Registration costs will be approximately $600.00 per
attendee which is inclusive of morning tea, lunch and dinner costs. Accommodation costs amount to $150.00 per
room per night. Relevant Works Program Area and Design and Contracts
Program Area staff will be attending subject to budget and time constraints. Funds are available for attendance of up to two
Councillors using Council’s budget for Delegates Expenses and
Conferences. This Congress is in a similar view to the National
Local Roads and Transport Congress but on a State basis with the support of
the Local Government Association of NSW, the Shires Association of NSW and
the · Progress since the release of the Local
Government Inquiry Report; · Asset Management Issues; · DoTARS – an update for Local Government; · · NRMA Motoring Services View; · Roadside environmental management; and · Roads & Transport Directorate Annual
Overview. Singleton
Council’s major asset is its roads and attendance of this Congress is most
relevant. |
There are no attachments for this report

Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Director
Operations Report No. 3/08 |
|
|
2. |
Council Seal
- Gowrie Street Mall Redevelopment - Author: Gary
Woodman |
FILE: RD01110 |
Executive
Summary APP
Corporation Pty Ltd on behalf of Macquarie Countrywide has written to Council
providing four copies of a Deed of Easement required by Energy The Deed of Easement is required to be
signed under Council’s Seal. |
RECOMMENDED that the Mayor and
General Manager be authorised to execute under Council Seal the Gowrie Street
Mall Redevelopment – Burns Lane Substation Relocation – Deed of Easement |
There are no attachments for this report.
Manager Community Services
Report No. 3/08 |
|
Minutes Disability Advisory
Committee |
Community Development Report
February 2008 |
|
|
1. |
Community
Development Report February 2008 Author: Wendell
Peacock |
FILE: 01/0163-2 |
Detail: The purpose of this report is to inform Council
of the key activities of the Community Development Officer (CDO) and
Community Development Officer – Special Projects for the month of February
2008. |
Disability Advisory Committee
The Disability
Advisory Committee met on 14 February 2008. The Committee had made submissions
to DAs for both the proposed
The AGM is planned for 1 April, and meetings were set for the rest of the year. It was decided at the meeting to present the Minutes to Council before they had been approved at the following meeting, as otherwise there would be too long a time lag (over two months) before any recommendations could be acted upon.
Interagency
The Interagency met on 13 February 2008 and, as the police Duty Officer was in attendance, much of the discussion centred around the police presence in Singleton. The policy is to have police officers in attendance for 24 hrs per day, but the station may not be manned if they’ve been called to an incident.
Community Safety Committee
The CDOs met with the Police Youth Liaison Officer to adapt the Draft Crime Prevention Plan according to the Draft Guidelines from the Attorney General’s Department. The Committee meeting on 27 February will plan the Safety Audit and look at issues relevant to the Plan.
Uniting Church Respite Accommodation Proposal
The CDO (and
Community Grants Officer) attended a planning workshop for the
Affordable Housing
The CDO attended a symposium on affordable housing in
Community Development
Both CDOs
attended a training day in ‘Working from a Strengths Perspective’ at the Family
Action Centre of the
Liquor
Accord
The first meeting of 2008 was the Annual General Meeting where Terry Webster, Tim Ryan and Grant Morgan were elected into the executive roles. Much of the discussion was focussed on the trial shuttle service, which ran throughout December. Approximately 200 people used the service, and reports from the security company indicate that patrons were well behaved on the bus, with no incidents occurring. The Accord has decided to cease the provision of this service due to the financial cost, which increased because of the increased security costs. Although there was a decrease in the number of alcohol related crimes throughout the trial period, the financial outlay is not sustainable by members of the Accord. Further opportunities for external funding will be sought.
Good
Sports
The program has been introduced to the Junior and Senior Rugby League and Junior Soccer Clubs, all of which have enrolled and undertaken the first steps towards accreditation. The majority of sporting clubs in the Singleton Area have received information regarding the program, and meeting dates are being determined for these clubs to have the program presented to the committees and their members. The Special Projects officer attended the conference for all Good Sports Project Officers.
Disaster
Recovery – Community Gathering Dunolly- Glenriding – Scotts Flat
The dinner was
held 2 February 2008 at the Singleton Youth Venue, with over 80 people
attending. Representatives from the
Rural Fire Service, SES, Red Cross and Department of Community Services were
also in attendance, and these services provided an overview of what people can
expect in a disaster and how to better prepare for future adversity. The evening also provided the residents with
an opportunity to clarify any is
AT-1View |
Minutes
Disability Advisory Committee |
7 Pages |
AT-2View |
Attachment
1 to DAC Minutes |
1 Page |
AT-3View |
Attachment
2 to DAC Minutes |
1 Page |
AT-4View |
Attachment
3 to DAC Minutes |
1 Page |
Disability Advisory Committee
SINGLETON NSW
2330
Enquiries: Wendell Peacock
6578 7215
Minutes
of the Committee Meeting held on Thursday, 14th February
The Meeting opened at 13.05 pm.
Present: Norm MacPherson (Chairperson), Ray Catlin, Robert Winter, Mayor, Fred Harvison , Lyn MacBain, Mark Reedman ( Dept. of Community Services, Youth Centre), Julia Crebert, Mary Myers (EDuCARE), Kathy Jones (EDuCARE), Margaret Sinclair, Dorothy Kingdom , Suzanne McWilliams (Minute Secretary).
1. Welcome: Chairman, Norm MacPherson welcomed everyone to the meeting.
2. Apologies: Mary Robinson, Wendell Peacock, Kylee Jurkans, Gill Eason, George Souris, Joel Fitzgibbon,
3. Confirmation of Minutes:
The Minutes of the meeting of the Thursday 15th November, 2007 were confirmed.
(Winter/MacPherson)
4. Business Arising from Minutes
Ø

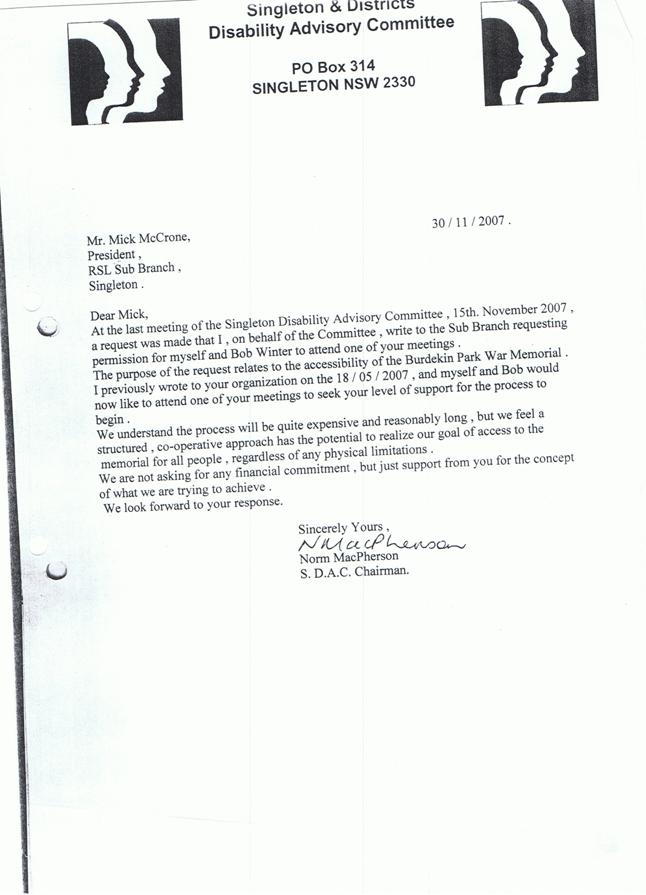

Correspondence (Attachment 1) sent to Singleton RSL Sub-Branch was tabled by Chairman, Norm MacPherson. As this was the 2nd letter sent re the War Memorial Norm addressed his concern re the lack of reply to the meeting. Lyn MacBain indicated that she will speak personally to Mr Mick McCrone re the matter and report back to the next meeting.
Ø Gowrie Complex
Correspondence ( Attachment 2) was tabled from Norm MacPherson, Ray Catlin, Robert Winter & Suzanne McWilliams to Singleton Council re DA …574/2007…. addressing issues that affected persons with disabilities and mothers with prams etc . Chairman Norm reported that as a result of this he attended a meeting with Tim Francis, Senior Development Manager from Macquarie Countrywide Trust on site. Mr Francis was very helpful and indicated that he would take the few changes needed into consideration in the development of the complex.
Ø Hydrotherapy Pool Working Party Report
Chairman, Norm MacPherson on behalf of the Working Party stated that as not all documentation was available at this time that the Report would be held over to the next meeting.
Suzanne McWilliams spokesperson for the Working Party also indicated that a letter (Attachment 3) had been sent to Norm MacPherson inviting a representative to attend a G&SAC meeting on 13th February at 5.30pm. Suzanne indicated that Norm had passed this letter on to her as the Working Party Representative to the G&SSC but that she was unable to attend because of a previous commitment. So as such she was unable to report on the outcome of the meeting but would endeavour to include the minutes from this meeting in the report for the next meeting.
Ø Shop Window Signs. Mark Reedman indicated that these are still happening.
Ø Priority 2
Walk
Priority 2 Walk was conducted this morning with 3 Councillors (Lyn MacBain, Sue Moore, John Martin) along with Graham Avard from Singleton Council. Norm MacPherson indicated that Graham Avard had with him a GIS system that was capable of marking problem areas so that they could be transposed onto a map to be made available to relevant Council Departments. Norm MacPherson asked that it be noted in the Minutes that Graham Avard was very positive in his approach to the issues recognised and was also very helpful. Norm informed the meeting that he has taken his own notes as well and will forward these to Wendell Peacock.
Lyn MacBain indicated that the practicality of the walk was particularly pertinent to the issues faced everyday by those residents who have disabilities and need to get around town.
General
Business
Ø Community Development Officer’s Report
Norm MacPherson tabled the Community Development Officers Report (Attachment 4) as Wendell Peacock was unable to attend.
Discussion was held on this report. Norm indicated that the Walks needed to be completed within the next three weeks so that the Access Audit was complete and ready for costing. (Norm to follow up on this and advise on dates and times).
Norm MacPherson
also tabled correspondence ( Attachment 5) re the Aprons in
Ø Future Meeting Times, Dates and Venue.
Meetings according to the Constitution need to be held at least bi-monthly and Norm MacPherson suggested to the meeting that as the Access Audit was now completed it was not necessary to meet as often. The Meeting was in agreeance with this and the dates of 1st April, 3rd June,5th August, 7th October,2nd December be noted as the dates for 2008. Time of the meetings being 1pm to 3pm. Venue Youth Centre unless otherwise advised. (MacPherson/MacBain)
Carried.
Ø AGM
Discussion re the AGM followed as April is the month in which this is normally held. The 1st April meeting will commence at 12noon with a Light Luncheon and then the AGM followed by the Bi-monthly meeting. Mary Myers (EDuCARE) indicated that they can supply slices. Norm MacPherson indicated that he will speak with Wendell Peacock re the Luncheon and also ask that the AGM be advertised in the Local Papers.
Ø Minutes
A discussion was
held re the timing of the Minutes being presented to Council. It was decided
that the Minutes would be circulated within 4-5 days of the Meeting for reading
by those in attendance. The Minutes would then be sent to Wendell Peacock and
Jennifer Underwood for inclusion in their next
Report to the Operations Committee so that any recommendations made from
that meeting could be addressed within a reasonable time frame. The Minutes
would then be ratified at the next meeting and any corrections could be made
then. Lyn MacBain indicated that this is what the Heritage Committee do quite
successfully. Suzanne McWilliams asked Mayor, Fred Harvison did he see any
problem with this to which he replied that he could not see any issue with it. (MacPherson/MacBain)
Carried.
(The Minute
Secretary asked members and interested
persons who do not have email to place
their address on the attendance sheet so that Wendell Peacock can organise the
minutes to be sent via mail.)
Ø Albion Hotel
Chairman Norm stated that prior to Christmas that he and his family visited the Albion Hotel (which was being renovated at the time). He asked the Licensee to consider placing a ramp for access in the new renovations. He was happy to state that a complying ramp was installed within 48 hours of him speaking to the Licensee. A discussion followed and Norm MacPherson will approach the Argus re a story on the matter. Another discussion followed re a Certificate of Appreciation for this quick action.
Mary Myers (EDuCARE) indicated that her Office could assist in the Printing of this and Lyn MacBain offered to work with the Graphics. Mary and Lyn to liase on this. Minute Secretary asked to pass on email addresses so that this could occur.
Ø Library Apron &
Pathway
Lyn MacBain
brought to the attention of the Committee a potentially hazardous Pathway that diverts from the
Ø Visitor Information
Centre
Suzanne
McWilliams reported that she, Ray Catlin, Robert Winter and Norm MacPherson had
viewed the VIC DA and had found a number of issues that needed to be addressed

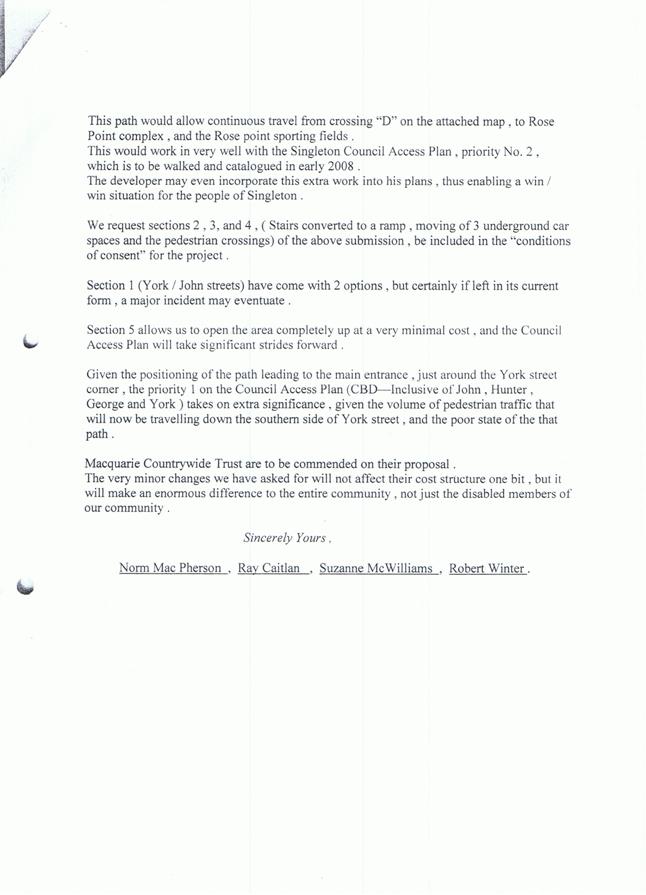

from a Disability point of view. A submission (Attachment 6) was sent to
Council for consideration. She stated that as a resident near
(Mayor, Fred
Harvison left the meeting at 13.50pm)
Ø Singleton Community Housing Forum Report
Discussion was
held on Housing issues within the Singleton area and in particular the Report
that resulted from the Singleton Community
Housing Forum. Norm MacPherson asked if there was a structured approach to
this as there are many looking towards
solving this problem but not much seems to be happening. Norm asked would it be
possible to obtain a copy of the report from Jennifer Underwood. Mark Reedman
(being the only Council Officer in attendance indicated that he would get a
copy and email it to the Minute Secretary for inclusion in the minutes)
(Attachment 7)* Not included with this
copy, as Councillors have seen the report.
Mary Myers( EDuCARE) suggested that as we are a Disability Advisory Committee to Council that we concentrate on our area of the housing issue which is Disability Supported Accommodation. It was noted at this time that at the last meeting Wendell Peacock reported that she had not heard back from FaCSIA re the submission by SSAAG. As there was nothing in Wendell’s report re this it was assumed that nothing had progressed out of the Submission.
Robert Winter
supported Norm MacPherson in that a centred, structured approach to the Housing
issue was needed. Discussion on this followed and Lyn MacBain was asked to
follow up on the progression of the recommendations made from the report. Lyn indicated that she would endeavour to do that.
Mark Reedman suggested that the Planning Department needed to be involved along with Community Services to discuss the future housing needs of Singleton as far as Supported Housing is concerned. Discussion on this followed.
It was resolved
that the Committee read the said report and come back to the April meeting for
further discussion and strategies to move forward with a more structured plan. (MacBain/Winter)
(14.47pm Lyn
MacBain left the meeting)
(14.49pm Margaret
Sinclair left the meeting)
Ø Silent Minority/Majority
Norm MacPherson raised the issue of access to the Advisory Committee by the silent minority/majority that are ‘going it alone’ in homes across Singleton and surrounds. Norm asked how we could raise awareness of the Advisory Committee to these people so that they can be given a voice.
Mary Myers (EDuCARE) stated that they are working on a data base of carers in the area and could assist in this.
A discussion was then held on how to raise awareness of the Advisory Committee’s activities so as all aspects of Disability could be approached and addressed.
The meeting was asked to think on this for the next meeting so that a plan could be formulated for further education .
Meeting
Closed 15.01
Next meeting
1/4/2008 12 noon.
Attachment 4
Report to Singleton &
Districts Disability Advisory Committee
Community Development Officer
11 February 2008
Disability Access Action Plan
The Disability Access
Action Plan was presented to the 3 December Operations Committee meeting and
approved to be lodged for public comment. The document was made available at
Council Administration reception and the Library, and copies forwarded to known
interested service providers and members of the community. It was reported in
the Argus, and the CDO conducted two radio interviews relating to it. Five
brief written responses were received, two of which were from members of the
Disability Advisory Committee. All responses noted the deficiencies in access
in Singleton (for prams as well as wheelchairs), commended Council for
addressing the issue and suggested that sufficient funding for implementation
of modifications be allocated as a priority, so that access throughout
Singleton could be improved in as short a time as possible. None of the
responses require any changes or additions to the Plan. Copies of the
submissions are tabled.
Met with Manager
Community Services, Jennifer Underwood;
Manager Parks & Facilities, Al Fletcher; and Works Co-ordinator,
Brendan Behringer, to discuss procedure for costing priorities on Council
buildings. One quote to do a full scoping and costing of the works required on
Council facilities has been received from a conventional building firm, and it
was decided to identify firms or individuals with expertise in access requirements and modifications to submit
scoping quotes for both buildings and facilities, and footpaths. It will be
therefore be necessary to get the access priorities done on the other three
Access Zones as soon as possible.
Graham Avard has offered
his assistance with the GIS system for the street access audits. Zone 2 was
commenced on 14th February (this morning), and Graham will be
explaining the process to the meeting.
Aprons in
· Parks and Facilities are constructing the aprons
in Burdekin park as part of some footpath maintenance works they are completing
within the park.
· The aprons are positioned were they are because
they line up with the existing footpaths within the park. To shift them further
around the corner would mean constructing new footpaths as well to link to
them.
· The angle of the aprons is also constricted by the
shape of the road pavement which they lead on and off from. It is not always
possible to have them dead flat and taking them back further wont always solve
the problem as we still have to tie in with the road pavement.
N.B Footpaths cost $130
per square metre!
Wendell Peacock
Community Development
Officer
Attachment 5
From: elizabeth macpherson [mailto:nasamacpherson@aapt.net.au]
Sent: Sunday, 3 February 2008 11:03 AM
To: Peacock, Wendell
Subject: Aprons
Wendell ,
1. I notice the aprons
being erected on the
2. Could you seek
clarification from works as to why , when the aprons are erected , as with the
ones on the corner of York and Bowman , and the ones on the corner of Castlereagh
and
I do not understand why
they all cannot be erected flat so the chairs do not have to tilt as they go up
or down them . It may mean the apron goes further up the path . But having them
flat is a far safer option I believe .
Could you clarify this for
me please .
Many thanks , Norm.
Attachment 6
Steve McGrath
General Manager
Singleton Council
Queen Street
Singleton NSW 2330 21st
January,2008
Re:
DA 5/2008
Visitors
Information Centre
Dear Sir
After
viewing the VIC Proposal we would like to comment on the proposed development
and bring to the attention of Council
some pertinent points.
· Access
to the building is a problem (especially
to the Café Deck) from the Western side.
Ingress and Egress for prams, strollers, wheelchairs and elderly
(particularly in an emergency) from the play areas is a major issue. A ramp is
need from the deck to ground level at a 1:14 slope .
· Moving
people especially elderly and disabled across the Bike Track from Waterhouse
Avenue Coach bay for access to the VIC could prove to be dangerous for both
visitors and the children who use the Bike Track.
· We
also would like you to note that it is difficult to calculate the width of
doorways in the plan. They should all be built to provide disabled access and
this should include access to toilets, offices, storerooms, kitchen etc.
· The
Access toilet it is stated in the
Proposal will be unavailable after hours and that the existing toilets will be
for after hour use. There is no access toilet in these toilets and as such they
would need to be upgraded to provide an accessible toilet.
As
Singleton Council in it’s Core Values statement states that it is a fair and
equitable employer and provider of service, the following need to be addressed
on behalf of any future employees.
· There
is no access toilet for staff in the southern end of the building.
· There
is no emergency egress for staff in the Southern end of the building. There
needs to be a ramp (1:14) from the administration area to allow any employee,
but particularly, disabled employees to leave the staff area of the building in
an emergency.
The estimated cost for
the VIC we believe from the local paper is $1.66 million. Singleton Council has
an ethical duty to it’s rate payers to ensure that no further funds need to be
allocated for renovations or retrofitting that has been made mandatory by a DDA
complaint; for as you are aware…
The objectives of the Disability Discrimination Act 1992 (DDA) are "to
eliminate, as far as possible, discrimination against persons on the ground of
disability in the areas of: work, accommodation, education, access to premises,
clubs and sport; and the provision of goods, facilities, services and land; and
existing laws; and the administration of Commonwealth laws and programs; and to
ensure, as far as practicable, that persons with disabilities have the same
rights to equality before the law as the rest of the community; and to promote
recognition and acceptance within the community of the principle that persons
with disabilities have the same fundamental rights as the rest of the
community."
The Human Rights and
Equal Opportunities Commission issued a Paper last year called ‘The Good, the
Bad and the Ugly’ which was a guide for good practice in building. Ease of
access is important for all users of any facility and we are sure that
Singleton Council will use this document to create a Benchmark facility that
can be accessed by all.
We urge you to look more
closely at this facility and not to act in haste.
-------------------------------------- ----------------------------------------
Norm MacPherson Robert
Winter
--------------------------------- ----------------------------------------
Ray Catlin Suzanne
McWilliams
Manager Community Services
Report No. 3/08 |
|
Attachment 1 to DAC Minutes |
Community Development Report
February 2008 |
|
|
Manager Community Services
Report No. 3/08 |
|
Attachment 2 to DAC Minutes |
Community Development Report
February 2008 |
|
|
Manager Community Services
Report No. 3/08 |
|
Attachment 3 to DAC Minutes |
Community Development Report
February 2008 |
|
|
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Community Services Report No. 3/08 |
|
|
2. |
Youth
Programs Author: Mark
Reedman |
FILE: 01/0393 |
Detail: The purpose of this report is to inform
Council of the participation and the programs at the Singleton Youth Venue
and around Singleton. |
Youth Venue Based Activities
January 2008 January 2007
Male 42 10
Female 18 0
11-14 33 8
15-17 26 1
Over 17 0
1
Sub-total 60 10
Off-site Activities
January 2008 January 2007
Nil New Year 7 Event 270
Sub-Total 0 270
Total 60
280
Issues/Activities:
Attendance
Numbers were low as this was a three week
period, workshops were not held and the summer holidays are traditionally
quiet.
It’s worth noting that, as I write in
February, attendance has increased to record levels since school went back.
Year 7 Event (Better
Futures Program)
This event for new Year 7’s at
Living With Your
Teenager (Better Futures Program)
Eight parents have registered for this two
day parenting program in April.
Skate Competition
Committee
Five young people have joined this committee
to first meet in February.
Yuiri’s Night 08
April 12 marks the anniversary of the first
man in space and the Youth Venue is holding one of 77 parties in 26 countries
to mark the occasion. Singleton is, so far, the only party in
|
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Community Services Report No. 3/08 |
|
|
3. |
Colleen Gale
Children's Centre Working Group Meeting Author: Jennifer Underwood |
FILE: 01/0447-3 |
Executive
Summary: The minutes of the Colleen Gale Children’s Centre Working Group Meeting for February 20 2008 are attached. The Colleen Gale Children’s Centre requires urgent maintenance and marketing to compete in the competitive market within which it exists. The Department of Community Services is currently being approached for additional financial assistance to ensure the Long Day Care Centre remains as a valuable community based asset and service, however maintenance and marketing for the Centre has been neglected due to inability to raise funds from income from the Centre. Landscaping of the playground and front
entrance has been completed, funded by Council and the parent Fundraising
Committee. Additional maintenance is required to comply with DoCS regulations
and remain as a safe high quality community service. |
1. the information in this report be noted. 2. fees increase by 3.5% in the 2008/2009 draft budget based on CPI inflationary increases and investment be placed in the implementation of the maintenance and marketing plan including a $40,000 heavy maintenance vote and $5,000 marketing vote with a budgeted occupancy of 85% for Long Day Care and current budgeted targets for Out of School Hours Care and Mobile Pre-school. 3. the Terms of Reference for the Colleen Gale
Children’s Centre Working Group and the Colleen Gale Children’s Centre
Advisory Committee be reviewed at the next Working Group meeting for the
purpose of investigating the amalgamation of the two Committees. |
AT-1View |
Colleen Gale Children's Centre Working Group Meeting 20 February 2008 |
3 Pages |
Manager Community Services Report No. 3/08 |
|
Colleen Gale Children's Centre Working Group Meeting
20 February 2008 |
Colleen Gale Children's Centre Working Group Meeting |
|
|
COLLEEN GALE CHILDREN’S CENTRE
WORKING GROUP
MINUTES OF MEETING HELD
WEDNESDAY 20 FEBRUARY 2008
COMMENCING AT 6:33 PM
Present: Gary
Woodman Director
Operations
Julie
Quigley Manager
Human Resources
Jennifer
Underwood Manager Community
Services
Lauren
Hain Acting
Director CGCC
Anthony
Egan Manager
Finance
Carol
Hepworth Diploma CGCC
Kim
Deaves Administration
Assistant
Cr
Jon Doughty
1. WELCOME
& APOLOGIES
Resolved that the
following apologies be accepted:
Cr Val Scott
Ann Bomann-Maansson
(Woodman/Underwood)
2. MINUTES
OF PREVIOUS MEETING HELD 26 SPETEMBER, 2007
Resolved that the
minutes of the previous meeting be adopted as a true and accurate record with
the amendment of the deletion of Anthony Egan and Julie Quigley as being
present.
(Woodman/Underwood)
2.1 Business Arising from previous minutes
Nil
3. STRATEGIES
TO PROGRESS THE PROJECT
3.1 Marketing Plan
· Quotes
have been obtained for a banner advertising the Long day Care Centre. This is
to be purchased using the current budget.
· Quotes
also in process of being obtained for additional soft fall for the playground
and flyers and posters advertising the three CGCC services.
· The
parent fundraising Committee are looking towards raising some funds for large
outdoor moveable equipment.
· The
next fundraising event will be on the 8 March at Rutherford Bunnings Hardware
for a sausage sizzle.
· Ideas
were tabled by the staff about on line enrollment forms and more advertising
through the website, customer service and the library.
· The
Manager Community Services reported that most of the costs related to
implementing the marketing plan were just for the production of flyers,
promotional photography and for staff time.
3.2 Maintenance Audit
The Maintenance audit
priorities were kitchen floor covering replacement, exterior door replacement,
Grills/screens replacement, Nursery change room bench fixture, electrical
upgrade and phone system, external painting, plumbing at a total estimated cost
of $40,000.
RESOLVED TO RECOMMEND a 3.5% increase in fees based on CPI
inflationary increases and an investment in the maintenance and marketing plan
implementation of $40,000 heavy maintenance vote and $5,000 for marketing on a
budgeted occupancy of 85% for Long Day Care and current budgeted targets for
Out of School Hours Care and
(Woodman/Doughty)
Gary
Woodman retired from the meeting at 8pm.
4. GENERAL
BUSINESS
a) Fee payment Policy to be tabled at next meeting
to review payment of fees policy to ensure parents remain ahead in their
payment of fees.
b) Draft budget to be tabled at next meeting or an
extraordinary meeting for feedback from the Committee.
c) The first CGCC Newsletter is to be produced
with notification to parents that Anne Bomann-Maansson is on sick leave.
d) Purpose of both the CGCC Working Group and the
CGCC Advisory Committee questioned. Parent commitment and staff commitment to
both Committees is duplication.
RESOLVED TO RECOMMEND that the Terms of Reference for the Colleen
Gale Children’s Centre Working Group and the Colleen Gale Children’s Centre
Advisory Committee be reviewed at the next Working Group meeting for the
purpose of almalgamating the two Committees.
(Doughty/Deaves)
5. Next
Meeting
Wednesday 19 March 2008 at 6.30pm in the Committee Room
There being no further business
the meeting concluded at 8.25pm
Attachment 1 |
Manager Community Services
Report No. 3/08 |
Colleen Gale Children's Centre
Working Group Meeting 20 February 2008 |
Colleen Gale Children's Centre
Working Group Meeting |
|
|
Colleen Gale
Children’s Centre Working Group
Action Sheet-
February 2008
|
ACTION |
RESPONSIBLE |
DEADLINE |
COMPLETION/ COMMENTS |
1. |
Advertising banner
to be ordered |
ADCGCC |
Friday 29 February
2008 |
|
2. |
Quotes obtained and
designs completed for production of flyers and posters |
ADCGCC |
Wednesday 19 March
2008 |
|
3. |
Re-advertise
Authorised Supervisor position for |
Director CGCC MCS |
Wednesday 15 January
2008 |
Completed- commencing in March 2008 |
4. |
Draft budget
2008/2009 |
Manager Community
Services Manager Finance |
Wednesday 27 February
2008 |
|
5. |
Draft Marketing Plan |
Manager Community
Services Director CGCC Community Grants
Project Officer |
Wednesday 17 October |
Completed- recommendations to Council
November Operations Committee |
6. |
Parent questionnaire
on change of operating hours for shift workers |
Manager Community
Services Director CGCC Staff CGCC |
Wednesday 19 March
2008 |
Draft to be tabled
at next meeting |
7. |
Internal painting of
Centre |
ADCGCC |
Wed 19 March 2008 |
To be completed as soon as possible after
Validator visit |
8. |
Terms of Reference
review of CGCC Working Group and CGCC Advisory Committee |
CGCC Working Group |
Wed 19 March 2008 |
To be reviewed at next meeting |
9. |
Payment of fee
policies review |
CGCC Working Group |
Wed 19 March 2008 |
To be reviewed at next meeting |
10. |
Investigate future
needs of Council Records storage at OOSH |
Manager Community
Services |
Wednesday 17 October |
Investigations are
continuing |
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Community Services Report No. 3/08 |
|
|
4. |
Colleen Gale
Children's Centre Author: Jennifer Underwood |
FILE: 01/0447-3 |
Detail: The
purpose of this Report is to inform Council of the occupancy and activities
at the Colleen Gale Children’s Centre for the month of January 2008. |
Occupancy
January 2008
Actual Budgeted
Nursery 77% 80%
2-3 Room 45.9% 80%
Pre-school 76.5% 80%
Vacation care 69% 66%
Centre news - January
Anne Bomann-Maansson has been away on sick
leave and Lauren Hain will be Acting Director until her return. Our playground
redevelopment has commenced with work starting on 14 January 2008.
Children have really enjoyed watching the new developments. It should be
finished in the next few weeks depending on the weather.
Preschool room – The preschool room has been
very busy for the month of January. Many children that are starting school this
year returned for one last month before school starts. Children have been busy
making juggling balls, practising to juggle and decorating the room.
2-3 room – We have had low numbers for the month of
January but are hoping they will pick up when people get back from holidays and
school goes back. The children have been busy doing lots of art and craft to
decorate our room. They have also really enjoyed playing in home corner with
the baby dolls, putting them to sleep and pretending to feed them.
Nursery – Cassie has settled in to the team leader
role for Nattalie’s maternity leave position. All the children have settled in
well after the holiday break. We have started off the year with a lot of craft
activities such as painting, play dough and drawing. The children have also
enjoyed the new room set up and all the different toys.
Mobile truck - The mobile truck will start up
again on Tuesday 29 January. The venues this year will be:-
Tuesday –
Broke
Wednesday –
Thursday –
Mt Olive
Friday –
Broke
OOSH – Vacation care has been popular in the
holidays. The last day for vacation care will be Tuesday 29 January
and then before and after school care will return on the Wednesday.
The children have kept busy in the holidays
with regular trips to the local pool. Wendell Peacock from council guest
starred with an African drumming demonstration. Children did a lot of African
craft in relation to this. Some of the boys have created an ant farm and have
spent lots of time watching and feeding the ants. Another popular activity has
been creating with pottery and salt dough.
Jennifer Underwood Gary
Woodman Manager Community Services Director
Operations |
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Library Report No. 1/08 |
|
|
1. |
Library
Quarterly Report Author: Robyn Tonks |
FILE: 01/0573 |
Detail: The
quarterly report is attached for Council’s information. |
|
AT-1View |
Library Quarterly Report |
14 Pages |
Manager Library Report No. 1/08 |
|
Library Quarterly Report |
Library Quarterly Report |
|
|
SINGLETON PUBLIC LIBRARY
QUARTERLY REPORT
July - December
2007
Note: The
population figure used in this report is 23,005. It is the latest Australian
Bureau of Statistics estimated resident population (at 30 June 2006).
1. LIBRARY
USE
The
following statistics reflect the extent to which the library is used by the
community.
1.1 Registration as a
Percentage of Population
Total registration at the end of Dec 2006 = 8,923
Total registration at the end of Dec 2007 = 8,451
Members have
decreased by 5.29%.
36.74% of the
population are active library members.
1,032
active members are non-residents. This is a 19.58% increase on the previous
year’s non-resident total of 924 and means that the actual percentage of
Singleton’s population that are active members is 32.25%.
1.2 Internet
Memberships
An increase of 1.77%.
1.3 Library Visits
Total visits Jly-Dec 2006 = 70,754
Total visits Jly-Dec 2007 = 55,002
A
decrease of 22.26%.
Note: The electronic people counter stopped functioning during this period and estimates only can be provided.
Average visits per week Jly-Dec 2006 = 2,721
Average visits per week Jly-Dec 2007 = 2,115
Average visits per day Jly-Dec 2006 = 454
Average visits per day Jly-Dec 2007 = 359
Note: Saturdays are counted as a full day so that the visits per hour open are a more accurate indicator.
Average visits per hour open Jly-Dec 2006 = 47
Average visits per hour open Jly-Dec 2007 = 37
1.4 Number
Attending Storytimes
Separate
records are kept for children and their carers because these sessions are a
part of our strategy for improving and supporting family literacy. They target
both the children and their carers.
(a) Bedtime Storytime
One session is held per quarter.
Jly to Dec 2006 = 75 children + 47 carers
Jly to
Dec 2007 = 49 children + 28 carers
Overall
attendance has decreased by 36.89%.
These evening programs encourage family literacy.
(b) Preschool Storytime
Sessions are generally weekly but are not
held the week of bedtime storytime or during school holidays.
Jly to
Dec 2006 = 405 children + 253 carers (17 sessions)
Jly to
Dec 2007 = 442 children + 305 carers (18 sessions)
Overall
attendance has increased by 13.53%. However, there has been an additional
session this year.
(c) Lapsit
Program
One program of four weekly sessions is held
per quarter.
Jly to Dec 2006 = 72 babies + 78
parents
Jly to Dec 2007 = 54 babies + 55
parents
An overall decrease of 27.33%
1.5 Number of Children
Attending Book Beat
This new program only started last year. It is held quarterly.
Jly to Dec 2006 = 9 children (1
session)
Jly to
Dec 2007 = 20 children (2 sessions)
1.6 Number of Children
Attending
Adults also attended these sessions and assisted. They are included below in the comparative figure for adults attending special events or group visits.
Jly-Dec 2006 = 246 (7 activities)
Jly-Dec 2007 = 237 (7 activities)
A
decrease of 3.66%
1.7 Number of Children Attending Pokemon Club
This program was only introduced this year.
Jly-Dec 2007 = 116
1.8
Number of Children Attending Other Special Events or in Group Visits
Jly-Dec 2006 = 1,875
Jly-Dec 2007 = 2,390
An increase of 27.47%
1.9 Number of Youth Attending Special Events or
in Group Visits
Jly-Dec
2006 = 229
Jly-Dec
2007 = 254
An increase of 10.92%.
1.10
Number of Adults Attending Special Events or in Group Visits
This does not include those attending Storytimes. It should be noted that we also have a lot of individual visitors who come to view the artwork and displays that cannot be recorded.
Jly-Dec 2006 = 662
Jly-Dec 2007 = 878
A
32.63% increase.
Regular Events Targeting Adults |
|||
Event |
No. Attending Jly-Dec 2006 |
No. Attending Jly-Dec 2007 |
Variation |
Seniors on the Net |
74 |
41 |
- 44.59% |
Scrabble Set |
97 |
128 |
+ 31.96% |
Skillsnet |
66 |
14 |
- 78.79% |
Skillsnet and Seniors on the Net programs are under review.
1.11 Meeting & Training Room Hire July to
December.
This does not include usage for library purposes.
|
Training Room |
Team Meeting Room |
Large Meeting Room |
Foyer |
Totals |
|||||
|
2006 |
2007 |
2006 |
2007 |
2006 |
2007 |
2006 |
2007 |
2006 |
2007 |
Bookings |
21 |
25 |
58 |
59 |
30 |
35 |
4 |
- |
113 |
119 |
No. Attending |
183 |
264 |
497 |
559 |
593 |
576 |
150 |
- |
1,423 |
1,399 |
Hours Used |
140 |
143.5 |
328 |
216 |
142 |
131.5 |
4 |
- |
614 |
491 |
Bookings have increased by
5.31%
Numbers attending have
decreased by 1.69%
Hours used have been
decreased by 20.03%
1.12 After Hours Return Chute
Items returned Jly to Dec 2006 = 2,674
Items returned Jly to Dec 2007 = 3,059
A 14.40% increase.
1.13 Miscellaneous
Statistics are not available for areas such
as the Study Room, Local Studies Room and Corporate
2. MATERIALS USE
The following statistics reflect the extent of use of the library’s resources and services.
2.1 Total Loans
Jly-Dec 2006 = 89,716
Jly-Dec 2007 = 84,402
A
decrease of 5.92%.
2.2 Loans per Hour Open
Jly-Dec 2006 = 60
Jly-Dec 2007 = 57
2.3 Average Daily Loans
Note: Saturdays are counted as full days although we are only open for 3 hours.
Jly-Dec 2006 = 575
Jly-Dec 2007 = 552
2.4 Self-Check Usage
Self-Check
Usage |
||
Number of Users |
2006 |
2007 |
5,898 |
5,257 |
|
Number of Loans |
21,141 |
20,856 |
Percentage of Total Loans |
23.56% |
24.71% |
Our aim is to eventually have all loans go through self-check units so that staff are freed to be more proactive in assisting library users. Staff will still be available to assist. This will not occur until the videos are phased out because they cannot go through the self-check. It will require an additional self-check unit as usage increases.
2.5 Housebound Loans
Jly-Dec 2006 = 197 (individual) + 994 (institutions) = 1,191
Jly-Dec 2007 = 240 (individual) + 698 (institutions) = 938
Overall
housebound loans have decreased by 21.24%
Note: Loans are used by numerous borrowers at the institutions.
2.6 Computer Usage
Number of users Jly-Dec 2006 = 10,400
Number of users Jly-Dec 2007 = 11,782
An increase of 13.29%
Note: This includes the Internet and CD Rom usage but not the OPAC (online catalogue) usage or the Kurzweil.
Hours of usage Jly-Dec 2006 = 10,129
Hours of usage Jly-Dec 2007 = 11,644.5
2.7 Personal Computer Usage
There are
10 data outlets in the Study Room allowing users to connect their own laptop
computers with free Internet access.
Number of
users Jly-Dec 2006 = 229
Number of users Jly-Dec 2007 = 104
A decrease of 54.59%.
Hours of use Jly-Dec 2006 = 322
Hours of use Jly-Dec 2007 = 128.5
Since November customers with wireless enabled laptops could use them anywhere in the library to connect for free Internet access.
Number of users Nov-Dec 2007 = 14
Hours of use Nov-Dec 2007 = 16
2.8 Internet
Visitors
The following are included in the above total for computer users. They are listed here to demonstrate the number of non-members who make use of library facilities.
Place
of Residence |
No.
of Visitors Jly-Dec’06 |
No.
of Visitors Jly-Dec’07 |
Local |
129 |
319 |
NSW (other than Singleton) |
277 |
449 |
ACT |
4 |
5 |
|
54 |
36 |
|
9 |
3 |
|
2 |
11 |
|
8 |
30 |
|
1 |
12 |
|
6 |
1 |
Overseas |
214 |
154 |
Total |
704 |
894 |
2.9 Number of Playstation
Users
Note: We had 2 playstations but after two thefts early this year it was decided not to replace one.
Total users Jly-Dec 2006 = 1,018
Total users Jly-Dec 2007 = 504
A
decrease of 50.49%.
Total hours used Jly-Dec 2006 = 953
Total hours used Jly-Dec 2007 = 461.5
2.10 Number of Kurzweil Users
Total users Jly-Dec 2006 = 2
Total users Jly-Dec 2007 = 18
Total hours used Jly-Dec 2006 = 2
Total hours used Jly-Dec 2007 = 27.5
2.11 Number of Microfilm
Reader/Printer Users
Total users Jly-Dec 2006 = 58
Total users Jly-Dec 2007 = 38
A
34.48% decrease
Total hours used Jly-Dec 2006 = 76
Total hours used Jly-Dec 2007 = 41
2.12 Number of Photocopies
Taken July to December
Copier/Type of
copy |
2007 |
2006 |
Public Copier B&W |
32,656 |
36,962 |
Public Copier Colour |
6,750 |
11,636 |
Sub-total Public Copier |
39,406 |
48,598 |
Staffroom B&W Photocopies |
39,046 |
41,737 |
Total copies taken |
78,452 |
90,335 |
The
continued reduction in staff copies indicates the practices implemented to
improve sustainability have been effective.
3. REFERENCE/INFORMATION
SERVICE MEASURES
3.1 Number of Reference
Inquiries
In-house Reference Inquiries Jly-Dec 2006 = 4,329
Corporate Reference Inquiries Jly-Dec 2006 = 147
Local History Reference Inquiries
Jly-Dec 2006 = 57
Total Reference Inquiries Jly-Dec 2006 = 4,533
In-house Reference Inquiries Jly-Dec 2007 =1,157
Corporate Reference Inquiries Jly-Dec 2007 = 149
Local History Reference Inquiries
Jly-Dec 2007 = 60
Total Reference Inquiries Jly-Dec 2007 = 1,366
Total
reference inquiries have decreased by 69.87%
3.2 Reference Completion
Rate
This statistic refers to the number of reference inquiries answered on the same day as a percentage of total reference inquires.
Jly-Dec 2006 = 4,144 x 100 = 91.42%
4,533
Jly-Dec 2007 = 1,166 x 100 = 85.36%
1,366
3.3 Number of Interlibrary Loans Lent to Other Libraries From
Singleton Library
DATE |
NUMBER
REQUESTED |
NUMBER
SATISFIED |
SATISFACTION
RATE |
Jly-Dec 2006 |
23 |
20 |
86.96% |
Jly-Dec 2007 |
47 |
45 |
95.74% |
3.4 Number of Interlibrary Loans Lent to
DATE |
NUMBER
REQUESTED |
NUMBER
SATISFIED |
Jly-Dec 2006 |
174 |
260 |
Jly-Dec 2007 |
109 |
122 |
Note: There are more
satisfied than requested as they were requested in previous months.
3.5 Number of Requests
Taken
Jly-Dec 2006 = 197
Jly-Dec 2007 = 111
This
is a decrease of 43.65%
3.6 Number of Staff Online Searches for
Information
Online Resource |
Jly-Dec 2006 |
Jly-Dec 2007 |
||
No. Searches |
No. Successful |
No. Searches |
No. Successful |
|
ANZ Database |
24 |
24 |
9 |
6 |
Book Find |
N/A |
N/A |
0 |
0 |
Britannica |
11 |
9 |
1 |
1 |
Choice |
20 |
20 |
5 |
4 |
Consumer
|
6 |
6 |
1 |
0 |
Internet |
1,424 |
973 |
92 |
75 |
Internet
History Resource |
65 |
23 |
3 |
2 |
Libraries
|
1,007 |
630 |
3 |
2 |
Literary
Reference |
N/A |
N/A |
0 |
0 |
Master
File |
N/A |
N/A |
0 |
0 |
Novelist |
N/A |
N/A |
0 |
0 |
Science
Reference |
N/A |
N/A |
0 |
0 |
Small
Engine |
N/A |
N/A |
0 |
0 |
Source |
23 |
20 |
2 |
2 |
Standards
|
19 |
19 |
3 |
0 |
Webster
World |
4 |
3 |
3 |
3 |
World
Book |
7 |
7 |
1 |
1 |
Total |
2,610 |
1,734 (66.44%) |
123 |
96 (78.05%) |
3.7 Number of Holds
(Reservations)
Jly-Dec 2006 = 641
Jly-Dec 2007 = 935
This
is an increase of 45.87%
3.8 OPAC
(Singleton’s Online Catalogue)
OPAC
Usage Jly-Dec |
||
|
2006 |
2007 |
Number of searches |
16,142 |
8,084 |
Number of reserves |
38 |
12 |
Number of borrower s accessing personal details |
2,335 |
895 |
3.9 Number of Searches for Interlibrary Loan in
Libraries
Jly-Dec 2006 = 638
Jly-Dec 2007 = 232
A
decrease of 63.64%
3.10 Online Database Usage July to December
Statistics
are not available for all databases.
|
Novelist |
Science Reference Centre |
MasterFile Premier |
Small Engine Repair |
Book Find |
Your Tutor |
Choice |
|||||||||||
2006 |
2007 |
2006 |
2007 |
2006 |
2007 |
2006 |
2007 |
2006 |
2007 |
2006 |
2007 |
2006 |
2007 |
|||||
Log-ins |
N/A |
8 |
N/A |
13 |
N/A |
3 |
N/A |
4 |
N/A |
0 |
|
|
35 |
0 |
||||
Searches |
N/A |
26 |
N/A |
22 |
N/A |
3 |
N/A |
8 |
N/A |
0 |
|
|
|
|
||||
In-house
Sessions |
|
|
|
|
|
|
|
|
|
|
N/A |
56 |
|
|
||||
In-house Full
text |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
||||
In-house
Searches
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
||||
Remote Sessions |
|
|
|
|
|
|
|
|
|
|
N/A |
16 |
|
|
||||
Remote Full
Text |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
||||
Remote Searches |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
||||
Full
Text |
N/A |
14 |
N/A |
6 |
N/A |
3 |
N/A |
2 |
|
|
|
|
|
|
||||
Abstracts |
N/A |
3 |
N/A |
6 |
N/A |
4 |
N/A |
2 |
|
|
|
|
|
|
||||
Documents |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
||||
In-house
hits |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
||||
Views |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
||||
Total
Hits |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
||||
Attachment 1 |
Manager Library Report No. 1/08 |
Library Quarterly Report |
Library Quarterly Report |
|
|
|
Literary Reference Centre |
Consumer |
Webster’s World |
Webster’s eLearning |
ANZ |
IHR |
World Book Online |
Britannica |
The Source |
Standards Online |
||||||||||||||||
2006 |
2007 |
2006 |
2007 |
2006 |
2007 |
2006 |
2007 |
2006 |
2007 |
2006 |
2007 |
2006 |
2007 |
2006 |
2007 |
2006 |
2007 |
2006 |
2007 |
|||||||
Log-ins |
N/A |
6 |
N/A |
22 |
|
|
|
|
97 |
46 |
20 |
0 |
|
|
|
|
997 |
0 |
|
|
||||||
Searches |
N/A |
8 |
N/A |
38 |
|
|
|
|
188 |
239 |
|
|
|
|
|
|
|
|
34 |
11 |
||||||
In-house
Sessions |
|
|
|
|
12 |
223 |
0 |
44 |
|
|
|
|
143 |
52 |
|
|
|
|
|
|
||||||
In-house Full
text |
|
|
|
|
|
|
|
|
87 |
216 |
|
|
|
|
|
|
|
|
|
|
||||||
In-house
Searches
|
|
|
|
|
|
|
|
|
|
|
|
|
133 |
115 |
|
|
|
|
|
|
||||||
Remote Sessions |
|
|
|
|
21 |
9 |
24 |
8 |
|
|
|
|
|
|
|
|
|
|
|
|
||||||
Remote Full
Text |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
||||||
Remote Searches |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
||||||
Full
Text |
N/A |
4 |
N/A |
21 |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
||||||
Abstracts |
N/A |
2 |
N/A |
20 |
|
|
|
|
77 |
142 |
|
|
|
|
|
|
|
|
|
|
||||||
Documents |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
5 |
29 |
|
|
25 |
25 |
||||||
In-house
hits |
|
|
|
|
|
|
|
|
|
|
|
|
14600 |
7040 |
|
|
|
|
|
|
||||||
Views |
|
|
|
|
|
|
|
|
|
|
|
|
454 |
185 |
|
|
|
|
|
|
||||||
Total
Hits |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
3609 |
8735 |
|
|
|
|
||||||
Attachment 1 |
Manager Library Report No. 1/08 |
Library Quarterly Report |
Library Quarterly Report |
|
|
3.10 Sample Information
Inquiries
These indicate the range of inquiries
received at the
· Bull
riding techniques
· Unfreezing
of Northwest passage
· Aboriginal
population statistics prior to and during early civilization
· Career
in volcanology
· Are mammograms safe?
· Exercise and nutrition for the aged and frail
· Social impact of WWII on women
· Prison system and correctional facilities
· A concordance
· Fibonacci sequences in poetry, puzzles, games, etc
· How the self develops over time
· Old fashioned children’s games, skipping, hopscotch, etc
These indicate the range of Corporate
· Current Population figures for – Maitland LGA
· Statistics regarding disability and accommodation
· Information on writing position descriptions
· Standard information
· Census information
· Locate a photograph of Neil McNamara
· Domestic violence crime statistics for Singleton LGA over the last 18
months
· Comparison of the above with neighbouring LGAs
· Domestic violence – integrated court models
· Locate a council resolution
· Headstone inscriptions
· Specific family inquiries
· Antique Toys
· Parish map information
· Wambo and Warkworth
· Grave site numbers
· Who administers
· House history
4. LIBRARY MATERIALS
4.1 Total Stock
Total stock Dec 2006 = 57,326
Total stock Dec 2007 = 63,830
An
increase of 11.35%
Total acquired Jly-Dec 2006 = 2,261
Total acquired Jly-Dec 2007 = 2,677
Note: Donations and new copies of magazines are included in the total acquired.
Total discarded Jly-Dec 2006 = 264
Total discarded Jly-Dec 2007 = 7,185
Total Donations Jly-Dec 2006 = 473
Total Donations Jly-Dec 2007 = 690
4.2
Dec 2006 = 2.57
Dec 2007 = 2.77
5. HOURS WORKED
DATE |
PERMANENT
STAFF |
CASUAL
STAFF |
VOLUNTEER
STAFF |
TOTAL |
Jly-Dec 2006 |
7,711 |
823 |
247 |
8,781 |
Jly-Dec 2007 |
7,049.5 |
1,192 |
396.8 |
8,638.3 |
In addition to the above a significant number of voluntary hours are worked by permanent staff, ranging from 4 to 20 plus hours per week.
6. TECHNICAL SERVICES
This section helps complete the picture of achievements and also to establish benchmarks to assist in continuous improvement and research into best practice.
For example, it will provide data for assessing outsourcing options.
6.1 Acquisitions
|
Jly-Dec 2007 |
Jly-Dec 2006 |
Number
of orders placed |
91 |
101 |
Number
of items ordered |
1,702 |
1,645 |
Number
of items received |
2,677 |
2,261 |
New
magazine copies received |
418 |
639 |
6.2 Cataloguing
|
Jly-Dec 2007 |
Jly-Dec 2006 |
Number
of donations entered |
690 |
473 |
Number
of new cataloguing records created |
2,863 |
1,506 |
Number
of catalogue records updated |
8,099 |
9,571 |
Number
of original cataloguing |
91 |
62 |
Number
of holdings added to Libraries Australia |
270 |
179 |
Number
of holdings deleted from Libraries Australia |
42 |
- |
Number
of holdings updated on Libraries Australia |
1 |
2 |
Number
of searches on Libraries |
751 |
463 |
7. MARKETING
7.1
Exhibitions
· Visitor Information Centre -
· Antique toys
· Summer
· Doing Dad's proud
7.2
Displays
· Dementia
· New Adult and Junior materials
· Dorris Lessing (Nobel Prize in Literature
winners)
· Further education, career and job seeking
resources @ your library
·
· Xmas themed books
7.3 Media Promotions
· There were 10 articles in the Singleton
Argus this quarter.
· There were 2 articles in the Hunter Valley
News
· There
was an article in the Daily Telegraph
7.4 Outreach Promotions
Every school in the Singleton local government area was visited by library staff to promote the Summer Reading Program and the library’s services.
8. CUSTOMER COMMENTS FOR
SECOND QUARTER
The following comments were received in writing. It should be noted that all comments are seriously considered and acted on if appropriate. Responses are provided whenever details are submitted.
· As a recovering stroke patient I find Hear-A-Books are an excellent part
of my recovery therapy
· The following feedback on the Anna Dell’oso Creative Writing sessions
was received from Steve McKinnon at St Catherine’s. “As a teacher, I found the
presentation and nature of the exercises to be very good and highly stimulating
for the students. There were no negative comments from the students, other than
that they would have liked to stay longer. The students were very positive
about the program presented by Ms Dell’oso.”
· Signs needed for displays, e.g. toys could be missed (Special Projects
Librarian contacted customer re this)
· “I am an Arts
student at
· 3 complaints were received about
the behaviour and language of teenagers on the computers. (The Acting Manager
Library discussed the issue with each of the patrons, persons
identified have been spoken to and warnings given, staff have been advised to
keep an eye/ear out for such behaviour.)
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Library Report No. 1/08 |
|
|
2. |
Prime
Minister's Author: Robyn Tonks |
FILE: 01/0573 |
Detail: The
Australian Library and Information Association (ALIA) has advised that they
are developing a submission for the summit. |
ALIA will be working with Public Libraries Australia (PLA), National
State Librarians Association, Council of Australian University Libraries,
Friends Of Libraries Association, TAFE and other interested
organisations. PLA have agreed to a joint submission for the Australia
2020 summit focusing on the key area of Economic infrastructure, the digital
economy and the future of our cities with an emphasis on:
· how Australians benefit from libraries, their
services and collections and issues including contributing to the digital
economy through access to collections, quality electronic resources and
services.
· the need to boost public investment in this
infrastructure.
· the shift of support for access to
government services to national, state and public libraries.
· the importance of funding digitisation of the
nations library collections.
· how rural economies benefit from their
libraries.
· the contribution of libraries to the health of
Australians, and
· the contribution of libraries to indigenous
They will refer to the
recommendations from the report Libraries in the online environment and
note that funding is needed to provide a national infrastructure for the
nation.
|
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Library Report No. 1/08 |
|
|
3. |
Archives
Collection Author: Robyn Tonks |
FILE: 01/0573 |
Detail: The
Special Projects Librarian, Sharon Muir, has provided the following report on
the current state of the Archive Collection at the Library. |
The
collection consists of approximately 900 items. This includes:
Council
Archives – 500
· Council Minute Books - Singleton Municipal Council 1866 – 1975
-
- Singleton Shire Council and
Singleton Council 1976 – 2002
(more current still retained at Council)
· Rate Books
· Valuation listings
· Assessment listings
· Ledgers
· Building permits
A
majority of the Council Archives (with the exemption of the minute books) have
been wrapped in acid free paper with acid free tape. Whilst this helps to delay
the deterioration process it also inhibits access.
All
Council Archives are listed in Trim with generic access points on the Library
System (Amlib) for the Council Minutes.
Family history Archives – 50
· Parish Maps
· Police record books
· Government Gazettes
· A collection of Certificates,
indentures, legal papers, letters and notes relating to Singleton and prominent
Singleton people.
Photographs
– 280
Most of
these are modern council photographs from the 1980s onwards. They depict
Council land development, Council functions, Councillors and staff.
Historical
photographs include 4 photo albums relating to the Young family, formerly of
Baroona, a series of postcard style photographs depicting Singleton 1941 and
various miscellaneous photographs.
Maps
– 30
The maps
are from Planning and are generally in a poor condition.
Ephemera
– 40
These
include reports to ratepayers, Shire Guides and InfoMails.
Plans
for Future Development
· Funds have been allocated in the 2007/08 budget for the microfilming of
Council’s minute books and this has commenced.
· Map folders, document cleaning powder and pads, chemically inert
sleeves in various sizes and acid free tape have been purchased.
· A strategic plan has been developed for the application of a heritage
grant for Family History Archives. In the meantime the material is being
encased to prevent further deterioration. This is being done by the Special
Projects Librarian as time permits but as she only works 18 hours per week it
is a slow process.
· The Special Projects Librarian is developing an application for a
heritage grant for the Historical Photographs project and hopes to work with
the Historical Society on a joint project.
· The Special Projects Librarian is continuing to monitor the “Australian
Newspapers Online Project” and hopes to be able to use it as a framework for
scanning and indexing the Argus in house. This is only possible because Council
allocated in the 2007/2008 budget funding for a microfilm reader with capacity
to do this.
There is
an enormous amount of work to undertake with the Archives Collection and
|
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Library Report No. 1/08 |
|
|
4. |
Digitisation
of Newspapers Author: Robyn Tonks |
FILE: 01/0573 |
Detail: The
Special Projects Librarian, Sharon Muir, is monitoring the Australian Newspaper Digitisation as
part of the library’s collection and preservation
strategies for Local Studies, Family History and Archives as documented in
the Management Plan. When viable, we are hoping to be able to follow
their framework. |
A progress report on the project has been received from the State Library and is attached for Council’s information (Attachment 1).
It is worth noting that the Maitland Mercury, one of the pilot newspapers, will be particularly useful for us as The Mercury was our local paper prior to the Singleton Times.
Robyn Tonks Gary
Woodman Manager Library Director
Operations |
AT-1View |
Australian Newspaper Digitisation Progress Report |
1 Page |
Manager Library Report No. 1/08 |
|
Australian Newspaper
Digitisation Progress Report |
Digitisation of Newspapers |
|
|
State Library of
Australian newspaper digitisation: progress report
A meeting on the National Plan for Australian
Newspapers (ANPLAN, previously NPLAN) was held at the National Library on June
25, attended by the ANPLAN convenors from each state. ANPLAN, is the collaborative
plan of
A session of the meeting was devoted to the
Australian newspaper digitisation project. The aim of the project is
to build an infrastructure to provide fully searchable online access to a range
of Australian newspapers. The project
will initially improve access to iconic Australian newspapers, valuable
research resources on Australian history, social, political and economic issues
and culture.
The project will start by digitising a selection of Australian newspapers
published prior to 1954 with a contribution from each state. The results of
this pilot will be available from the beginning of next year for searching
online.
The state and territory
libraries will fund the provision of quality microfilm versions of newspapers
as the source material for the digitisation process. The microfilm will be
scanned to create digital page images. The images will then be converted into
searchable text files through the use of Optical Character Recognition (OCR)
technology. The National Library will develop the online search and delivery
solution in-house, based on software known as Lucene.
By mid 2008 there should be a significant number of pages in production and
available for searching.comprising Sydney
Gazette (1803-1842), Maitland Mercury
(1843-1893), and others.
By the end of the first phase of the project, 3.5 million pages of
content will be fully searchable via the internet; processes and costings will
be established, and standards will be confirmed for similar projects.
The State Library of New South Wales has nearly completed refilming The Sydney Gazette & NSW Advertiser.
This project involves carefully collating a single copy, selecting the best
pages from all of the Library’s copies.
The implications for public libraries in NSW are enormous. Initially
libraries will be able to provide clients with fully searchable internet access
to The Sydney Gazette & NSW Advertiser,
Jerelynn Brown
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
|
|
|
1. |

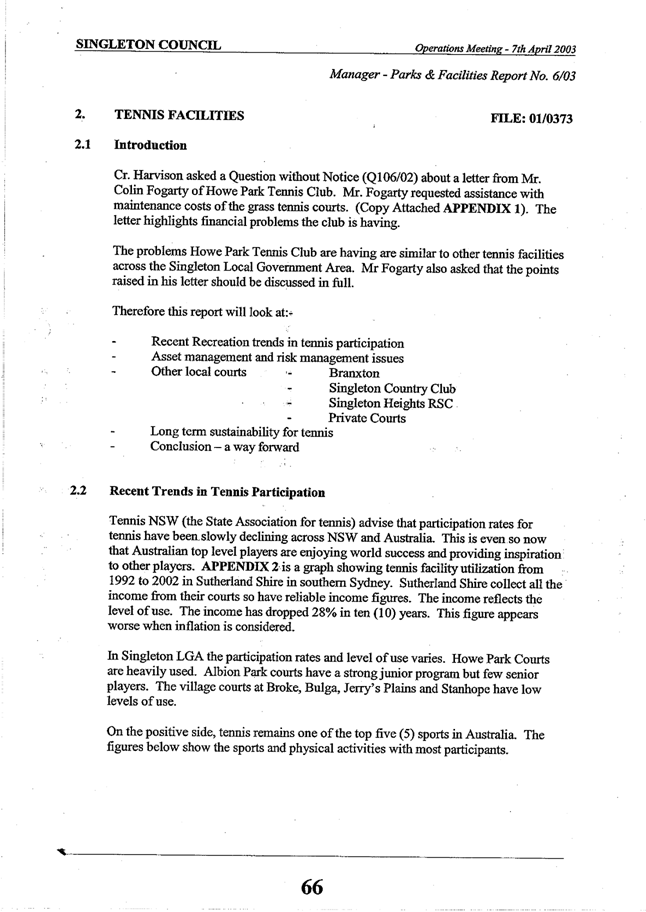

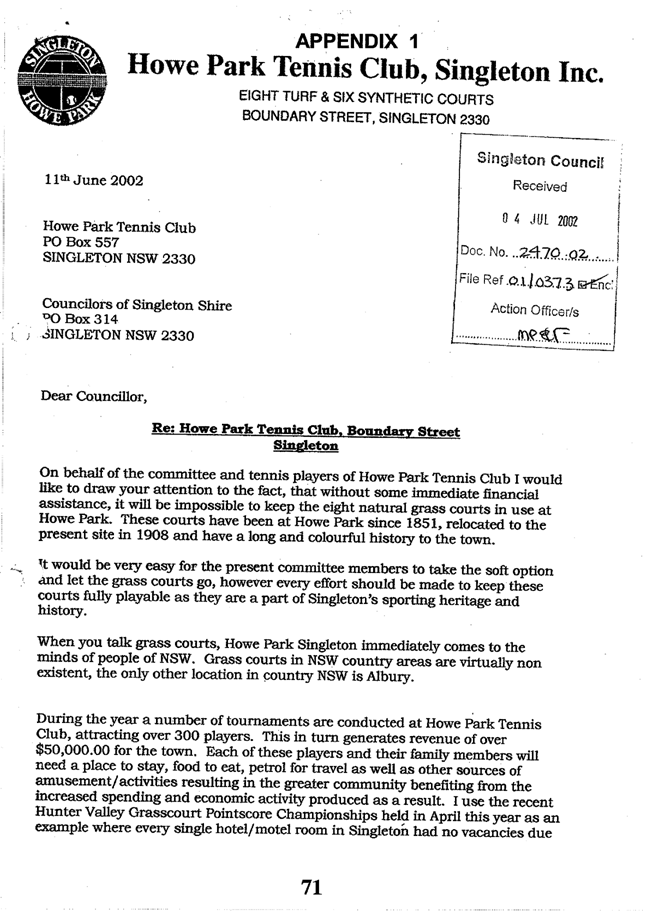

Tennis Author: Alan Fletcher |
FILE: 01/0373 |

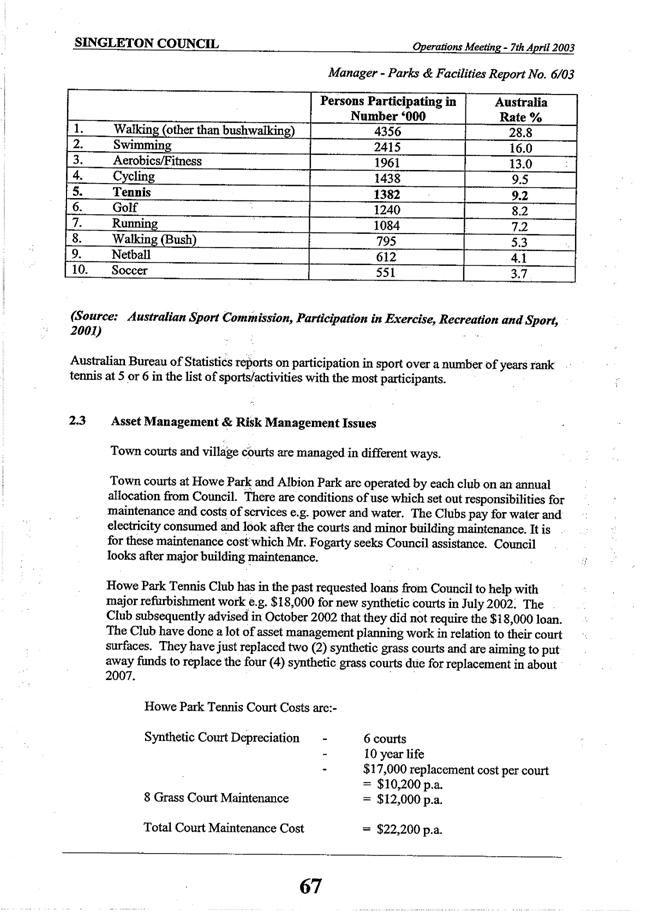

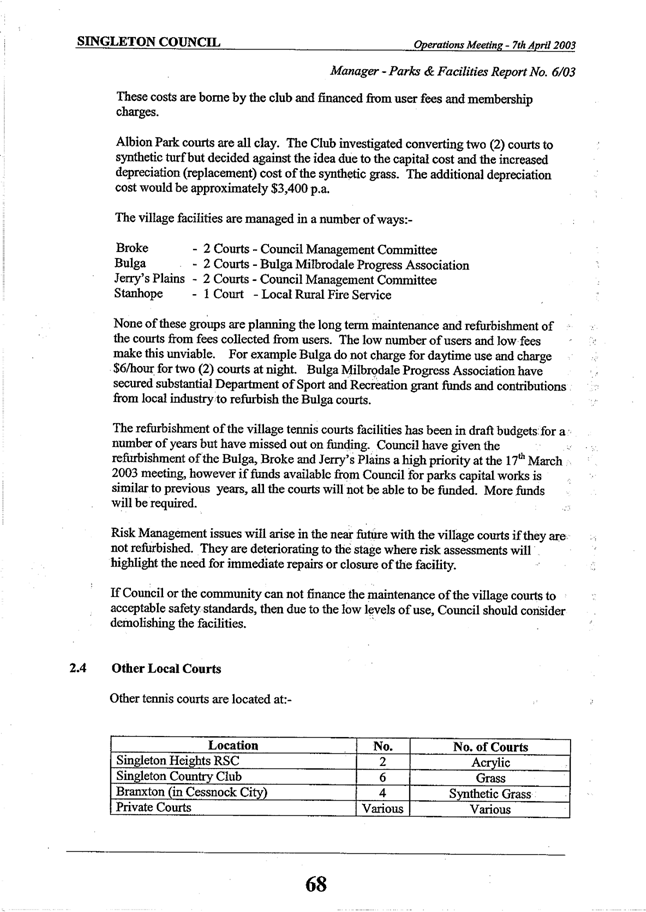

Executive Summary: The purpose of this report is to: 1. Introduce a presentation from Mr David Eland, General Manager of Tennis NSW. 2. Provide an update to Councillors on tennis issues in Singleton and 3. Advise
Councillors that Albion Park Tennis Club has ceased operation and that the
Playgroups that were located at |
Background:
On 7 April 2003 a report was presented to the
Operations Committee on Tennis facilities in Singleton Local Government
Area. Copy attached (Appendix 1). The Committee resolved:-
· That the user groups of all
Singleton Council tennis facilities be requested to meet and review their
tennis fee structures so as to have common fees across all facilities. That the Singleton Sports Council be asked to
facilitate the discussions.
· That Council retain the tennis
courts at
· That Singleton Sports Council be
asked to investigate and report to Council on:
- A
dollar for dollar grant scheme to assist user groups with major maintenance and
improvements of
facilities.
- A formalised loan system for community
groups to facilitate major maintenance or
improvements
for facilities.
The outcome from the resolution was:-
· Discussions were held at Sports Council Meetings about fees. However the Tennis organisations were
reluctant to raise fees.
· The courts at Broke, Bulga, Jerrys Plains and Stanhope were repaired
and/or resurfaced by Singleton Council.
The Bulga Community were able to secure partial grant funding for the
work at Bulga, the remainder of Bulga work and the work at other sites was paid
for by Council.
· The Dollar for Dollar grant scheme has been implemented to help users
finance asset upgrades or replacements.
Howe Park Tennis has taken advantage of the scheme.
Loans from Council have also been
utilized by Howe Park Tennis in the past to improve facilities.
On 8 November 2007 I attended a
meeting of Albion Park Tennis. The Club
were arranging the winding up of the Club.
The major problem was the difficulty in securing a coach, as user
numbers at the courts had dropped to unsustainable levels. The club voted to wind up the organisation.
The Playgroup at
Management
Plan:
The fees charged for the Playgroup use of the
Council Policy:
Legislation:
N/A.
Sustainability:
Social:
The 2003 report (Attachment 1)
has information on long term sustainability of tennis. Information from Tennis NSW is that
successful tennis complexes all have the following:
- 8 or more courts to provide economies of
scale, i.e. 8 courts can support a tennis professional and pro shop which also
helps with administering the courts, providing access and collecting fees. The large number of courts also facilitates running
tournaments;
- A reasonable user population, say
greater than 15,000 people preferably greater than 25,000 without competing
tennis complexes;
- A prominent position e.g. adjacent to a
busy road;
- Good quality, well maintained courts and
facilities.
For
these reasons it would be wise for
Tennis Centre. The proposed move of the golf course from
Environmental:
N/A
Financial:
Under current arrangements the
Howe Park Tennis Club have an annual allocation for the site from Singleton
Council. This is the case for most sport user groups in Singleton. Singleton
Council does not charge a fee but under the conditions of use the users are
expected to look after facilities, especially facilities the users provide.
Howe Park Tennis Club pay the maintenance costs of the facilities. Council
helps with grants through the Singleton Sports Council and has also helped with
capital works funding and organising other grants.
Council pays for the maintenance
of the village courts with some assistance from the users for minor items e.g.
cleaning, some weed control.
Consultation:
Council staff have met with the
The president of the Singleton Sports Council
will be organising a public meeting at
Risk Management:
Having Singleton Council’s facilities well
used and well maintained will minimise Council’s public liability risk. Unused
or infrequently used facilities tend to degrade quickly. Lack of use of the
village parks is an issue that was identified in the Village Parks Plan of
Management and is a continuing problem. The proposed adaptive reuse of
Options:
· That Council close the courts at the village parks if lack of use continues.
· That Council retain the tennis
courts at
Conclusions:
Tennis is a major sport in Singleton local
government area and is likely to remain so. Singleton Council needs to plan and
implement policies to help ensure the long term sustainability of tennis. The
resolution on the 7 April 2003 has seen a significant amount of maintenance
carried out at the village park courts and financial support through the
implementation of grants schemes for Howe Park Tennis Club in town.
Howe Park
Tennis is currently sustainable and will be more so with possible additional
improvements when the Golf Club leaves
RECOMMENDED that Council retain and support the tennis
courts at |
AT-1View |
Tennis Facilities Report on 7th April 2003 |
8 Pages |
|
|
Tennis Facilities Report on 7th
April 2003 |
Tennis |
|
|
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
|
|
|
2. |
Minutes for
Singleton Combined Horse Sports Ground Steering Committee - 13 February 2008 Author: Alan Fletcher |
FILE: 04/0178 |
Detail: The Minutes of the Singleton Combined
Horse Sports Ground Steering Committee Meeting held on 13 February 2008 are
detailed as Attachment 1. |
|
AT-1View |
Minutes
Singleton Combined Horse Sports Ground Steering Committee Minutes February
2008 |
1 Page |
|
|
Minutes Singleton Combined
Horse Sports Ground Steering Committee Minutes February 2008 |
Minutes for Singleton Combined
Horse Sports Ground Steering Committee - 13 February 2008 |
|
|
MINUTES OF SINGLETON COMBINED
HORSE SPORTS GROUND STEERING COMMITTEE MEETING – 13 FEBRUARY 2008 - MEETING NO.
23 at 7.45 P.M.
PRESENT: Alan Fletcher, Sharron Mills, Adrian
Whiting, Jillian Couling, David Badior, Bruce Withers
1. APOLOGIES
Cr. Sue Moore, Cr. Lyn MacBain, Bruce Moxey, Peter
& Colleen Heffernan.
A
QUORUM WAS NOT PRESENT
AN INFORMAL
DISCUSSION WAS HELD
Rixs Creek Mine advised by telephone on 13
February 2008 that they were not interested in selling or leasing their site on
Various other sites were discussed.
2. NEXT MEETING
7.30 pm Wednesday 23
April 2008.
G:\OPERATIONS\PARKS_&_FACILITIES\COMMITTEES\Combined
Horse Sports\Minutes 07\MINUTES - Meeting No 21 21.11.07.doc
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
|
|
|
3. |
Author: Stuart Neal |
FILE: 01/0222-3 |
Detail: Over the
recent summer months the Bunya Trees in Council’s Parks and Facilities Program Area has erected temporary exclusion safety zone fencing around all Bunya Trees in Burdekin Park so when Bunya Nuts drop the park users will not get accidently hit. Council has on a bi-yearly basis removed immature Bunya nuts using a large elevated tower. The removal of the Bunya nuts thereby reduces the risk of nuts falling. With recent wet weather the planned de-nutting of the Bunya trees has not yet been carried out, due to the moist soil conditions of the park. Severe damage to the park would have been caused by the very heavy tower machinery necessary to help remove the Bunya nuts. The exclusion zone mesh will stay in place until Council can remove the Bunya nuts from the trees, which with favourable conditions will be as soon as possible. Council has not yet received Dr Nelson’s Flying Fox Report commissioned by the NSW Department of Environment and Climate Change. The report is currently with the Department of Environment and Climate Change Director General’s Office. |
|
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
|
|
|
4. |
Playground
Capital Works Author: Kim Horn |
FILE: 01/0511 |
Executive Summary: Parks and Facilities have developed a priority list using the methodology set out in the Playground Management Strategy to program playground replacements over the next 20 years. Parks and Facilities have developed a 5 year capital works program from the priority list. |
Background:
Park Name |
Suburb |
Reserve No. |
Year Installed |
Condition |
|
Type of Facility |
Level of Use |
Replacement Priority |
|
SINGLETON |
22 |
2007 |
G |
2 |
S |
L |
5 |
ALLAN
BULL RESERVE |
SINGLETON |
10 |
1992 |
F |
3 |
R |
H |
9 |
ALROY
OVAL |
|
9 |
2004 |
F |
3 |
S |
M |
7 |
HEUSTON
LOOKOUT |
GOWRIE |
26 |
2000 |
G |
2 |
S |
L |
5 |
|
SINGLETON |
21 |
1997 |
F |
3 |
S |
M |
7 |
BROKE
REC GROUND |
BROKE
|
103 |
1996 |
F |
3 |
L* |
M |
6 |
BULGA
REC GROUND |
BULGA |
110 |
1996 |
F |
3 |
S |
L |
6 |
|
SINGLETON |
14 |
1985+1990 |
F |
3 |
R |
H |
9 |
HUNTER
PRELUDE |
SINGLETON |
|
2004 |
P |
4 |
L* |
L |
6 |
CIVIC
PARK |
SINGLETON |
11 |
2001 |
G |
2 |
S |
M |
6 |
|
SINGLETON |
12 |
2001 |
G |
2 |
R |
M |
7 |
EARRIBEE
RESERVE |
HUNTERVIEW |
46 |
2006 |
E |
1 |
L* |
L |
3 |
HARRY
GEORGE RESERVE |
SINGLETON |
18 |
2004 |
G |
2 |
L* |
L |
4 |
|
|
4 |
1997 |
G |
2 |
L* |
L |
4 |
JERRYS
PLAINS REC GROUND |
JERRYS
PLAINS |
130 |
1999 |
F |
3 |
S |
L |
6 |
JIM
JOHNSTONE RESERVE |
WARKWORTH |
120 |
2001 |
G |
2 |
S |
L |
5 |
MCTAGART
RESERVE |
BROKE
|
101 |
1996 |
F |
3 |
R |
L |
7 |
|
|
49 |
2005 |
E |
1 |
S* |
M |
5 |
ROBINS
PARK |
SINGLETON |
19 |
2000 |
G |
2 |
L* |
L |
4 |
ROBINSON
RESERVE |
|
36 |
1994 |
P |
4 |
L* |
L |
6 |
|
SINGLETON |
12 |
1986 |
removed |
|
R |
H |
|
|
SINGLETON
|
20 |
1996 |
G |
2 |
R |
H |
8 |
|
|
2 |
1995 |
F |
3 |
L* |
L |
5 |
NOTES - * Denotes not previously given level of use in playground strategy 6 May 2002
Replacement Priority - the higher the score the higher the priority
The table above lists the playground sites and priorities for replacement based on condition, type of facility and level of use.
There is a
cluster of playgrounds of a similar age (see graph below). After the
replacement of Rosepoint and
There are non compliance with the
Australian Standards issues at Jerrys Plains Recreation Ground playground that
are being addressed. The playground has been elevated up the list of
priorities.
Management Plan:
The 5 year capital works program is required by the Management Plan.
Council Policy:
Playground Management Strategy (adopted 6 May 2002, Policy No 135/02)
Legislation:
The
charter of the Local Government Act 1993 includes: -
· To promote and to provide and plan for the needs of children.
· Council is the custodian and trustee of public assets and to effectively maintain the assets.
Sustainability:
Social:
Provision of playgrounds for
children in our community is part of Councils social responsibilities. It is
important to ensure Councils facilities are safe, fun and attractive to use for
children and their carers.
Environmental:
Not Applicable
Financial:
The replacement program sets out
in the provisions of funds that are necessary to enable the replacement of the
playgrounds. The $55,000 for the replacement of the 2008/09 playground
replacement at
Consultation:
The Playground Management Strategy was
advertised for public comment prior to being adopted by Council on 6 May 2002.
The strategy sets out the process of determining the priority list.
Risk Management:
Council has a system in place for maintaining and repairing playgrounds which reduces the possibility of hazards, thus enhancing the safety of all users. Hazards are identified by proactive inspections (primary method) or reactively (secondary method). Evaluation of the hazard is carried out and then the appropriate action (control measure) is taken as in line with the Playground Management Strategy.
Providing and managing playgrounds to Australian Standards also helps minimise risk to Council. Playground standards that are applicable are:-
· AS/NZS 4422 Playground surfacing – specifications, requirements and test methods.
· AS/NZS 4486 Playgrounds and playground equipment – development, installation,
inspection, maintenance and operation.
· AS 4685 Playground equipment – general safety requirements and test methods.
Conclusions:
Council has a duty of care to satisfactorily construct and maintain all playgrounds under its care, control and management to enhance the safety of all users. Playgrounds are an important element in the social interactions in our parks and are enjoyed by a large number of users across the age spectrum. Council has a responsibility to ensure that all playgrounds comply with Australian Standards. The proposed Capital Works Program will help meet these responsibilities.
There are no attachments for this report
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
|
|
|
5. |
Minutes -
Senior Author: Alan Fletcher |
FILE: 02/0271-2 |
Detail: The Minutes of the twenty-sixth meeting
of the Singleton Senior Rugby League Ground Steering Committee held on 19
February, 2008 are attached. (Attachment 1). |
|
AT-1View |
Minutes
- Senior |
3 Pages |
|
|
Minutes - Senior Rugby League -
19 February 2008 |
Minutes - Senior |
|
|
SENIOR
7.00 PM – Wednesday 19 February 2008 at Singleton Council Committee Room
PRESENT:
Val Scott (Chairperson), John
Martin, Alan Fletcher, Gary Woodman, Bryan Kirkland, Mark Newman, John Brumby.
John
Martin was elected as Chairman.
1. APOLOGIES
Steve McGrath & Neil Buckton.
2. CONFIRMATION OF MINUTES OF MEETING NO. 26 HELD 15 January 2008
Minutes adopted as true and correct.
3. PROPOSED OPENING/FIRST GAME – 8 MARCH 2008
Building Inspector –
Andrew Harvey visited site today.
- No major problems, pointed out some minor items which are being
fixed.
- Fire protection measures being installed by Wormald.
- Andrew and Mark Newman meeting one day next week.
Landscaping to be
completed Saturday 23 February 2008.
Carparks and Roads
- J Moore 25 or 26 February J
February).
- 25 or 26 February – Street Sweeper
- 29 or 30 February or 3 March Boral to seal carpark and road .
DA Condition 27 - No
standing sign to ask Michael Launders to organise.
DA Conditions
1) OK
2) OK
3) OK
4) OK
5) External lighting around building OK.
6) OK
7) OK
8) OK
9) OK
10) Waste removal – 3m3 bin
coming. Mark Newman to advise Alan how
many sulo bins and stands required.
11) OK
12) OK
13) OK
14) OK
15) OK
16) OK
17) OK
18) OK
19) Work as Executed Plan underway.
20) OK
21) OK
22) OK
23) Road Construction – second seal due 30
February.
24) OK
25) OK
26) OK
27) Fencing underway. No Standing signs. Alan to speak to Michael Launders.
28) Disabled access ramp and parking
underway.
29) Fencing – ‘Open Mesh’ underway.
30) OK
31) OK
32) OK
33) OK
34) Work not inspected – nil.
35) OK
36) OK
37) OK
38) OK
39) OK
40) OK
41) OK
42) OK
43) OK
44) OK
45) Termite Certificate coming.
46) OK
47) OK
48) OK
49) OK
50) OK
51) Fire safety measures happening.
52) OK
53) Kiosk happening.
54) OK
55) OK
56) OK
57) Restriction to user being arranged.
58) OK
59) OK
DA Modification 23
November 2007 + Construction Certificate – Conditions – OK Mark Newman
arranging. Final approvals expected late
February or early March.
Opening
- Not many people have RSVP.
- Katrina Solman advised light
refreshments will be provided.
- MC.
Steve McGrath will be talking to Alan Fletcher and Katrina Solman to
finalise program.
Alan Fletcher asked was
there any issues that would prevent practical completion or, obtaining an
Occupation Certificate or the opening occurring. Nobody knew of any issues.
6. GENERAL BUSINESS
John Martin - Asked if trees to be planted were to have stakes. Alan advised yes.
Gary Woodman - Asked if Coal & Allied people had
been invited. Brad advised yes.
MEETING
CLOSED AT 5.45 P.M
8. ACTION
PLAN
REF |
ACTION |
RESPONSIBILITY |
COMPLETION DATE |
26.4.1 |
Building work to be completed. |
ALL |
29.2.08 |
26.4.2 |
Landscaping |
A Fletcher & J Martin |
22.2.08 |
26.5 |
Organise Opening – General - Determine Mayor’s, Minister’s and Local Members
availability |
B Solman G Woodman |
5.3.08 DONE. |
|
Draft Guest list Print and Post invites |
B Solman A Fletcher |
DONE. DONE. |
26.6 |
Check off DA Conditions |
ALL |
DONE. |
27.3.1 |
2nd Coat of Seal on Carparks |
A Fletcher |
3.3.08 |
27.3.2 |
Achieve Practical Completion and obtain Occupation Certificate |
M Newman B Solman A Fletcher |
4.3.08 |
27.3.3 |
Finalise program for Opening Ceremony |
K Solman A Fletcher |
25.2.08 |
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
|
|
|
6. |
Minutes -
Sedgefield Cemetery Improvements Working Group - 12 February 2008 Author: Alan Fletcher |
FILE: 01/0384 |
Detail: The Minutes of
the Sedgefield Cemetery Improvements Working Group Meeting held on 12 February,
2008 are detailed as Attachment 1. The Working
Group have recommended to Council to consider new fees and charges for the
2008/09 Draft Management Plan and Budget. |
RECOMMENDED that Council note the Minutes of the Sedgefield Cemetery
Improvements Working Group Meeting held on 12 February, 2008 and adopt the
fees and charges as recommended by the Sedgefield Cemetery Improvements
Working Group for consideration in the Draft 2008/09 Management Plan and
Budget. |
AT-1View |
Minutes
- |
2 Pages |
|
|
Minutes - |
Minutes - Sedgefield Cemetery
Improvements Working Group - 12 February 2008 |
|
|
Present: Cr. Mary Robinson (Appointed Chairperson), Tracey Hollaway, Alan Fletcher (
1. APOLOGIES
Cr F Harvison, Phil Fletcher.
2. CONFIRMATION
OF MINUTES – 14 AUGUST 2007
CONFIRMED as true and correct.
Tracey Holloway/Mary Robinson
2.1 Matters Arising from Minutes - NIL
3. CROWN
LAND CEMETERIES
Jerrys Plains - No change on current status and actions.
Warkworth - Discussions with St Phillips and
investigations being undertaken on location.
Reedy
Creek - Survey work soon to commence to define
boundries.
(
Hoping a further report will be provided to the March or
April, 2008 Operations Committee Meeting follows a further report to the
Sedgefield Cemetery Improvements Working Group.
4. FEES AND
CHARGES FOR 2008/09
The Draft
Fees and Charges increase amounts to approximately 3%.
RESOLVED
that it be RECOMMENDED to Council
that the following fees and charges for Public Cemeteries be considered for
inclusion in the draft 2008/09 Fees and Charges within the Management Plan.
Tracey Holloway/Mary Robinson
Description of Fees & Charges |
Fee Type |
Quick Key |
Item No. |
GST Y/N |
2007/ 2008 $ |
2007/ 2008 $ |
2008/ 2009 $ |
GST Amount 10% |
2008/ 2009 $ |
Public Cemeteries Interment - Adult - Child (half size plot) Lawn Section - With Steel Cross - Other Columbarium Fee for administration for removal of ashes Note: The Columbarium Niche
ownership to revert to Council – Reserve Trust Manager Permission to erect head or footstones, slab over grave, double slab
included in above charges. |
D D D D D D |
17 17 17 17 17 17 |
16.37 |
N Y Y Y Y Y |
175.00 754.55 572.73 1,113.64 1,009.09 572.73 |
175.00 830.00 630.00 1,225.00 1,110.00 630.00 |
180.00 777.27 590.91 1,145.45 1,040.91 590.91 |
- 77.73 59.09 114.55 104.09 59.09 |
180.00 855.00 650.00 1,260.00 1,145.00 650.00 |
5. GENERAL
BUSINESS
5.1 Brown Marble headstones (Steel Cross) in
Section
Follow up needs to happen in regard to
brown marble headstones that on appearing and whether they are to the
appropriate standard and in accordance
with the Cemetery Operating Procedures.
5.2 Dead
Trees
Lower part of cemetery replacements to
be arranged.
6. NEXT MEETING
To be
arranged when preparation of
complete.
BEING
NO FURTHER BUSINESS THE MEETING ENDED AT 4.37 PM.
G:\OPERATIONS\PARKS_&_FACILITIES\PARKS
INFO\Cemeteries\Minutes 12 02 08 Sedgefield Cemetery.doc
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
|
|
|
7. |

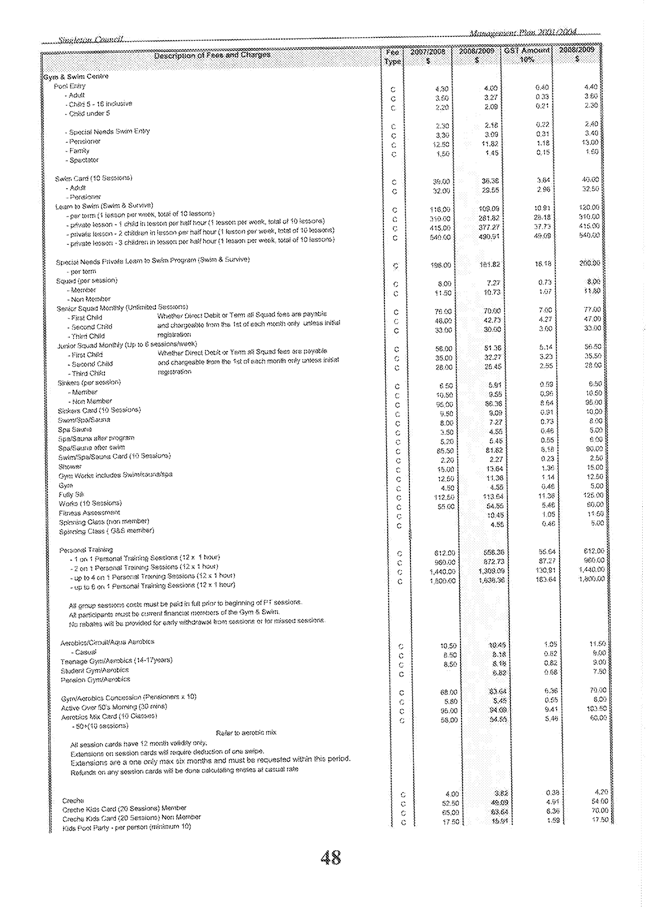

Singleton Gym
& Swim Advisory Committee Minutes - 13 February 2008 Author: Alan Fletcher |
FILE: 08/0034 |

Detail: The Minutes of the Singleton Gym and Swim Advisory Committee Meeting held on 13 February 2008 are detailed as Attachment 1. Fees and Charges are attached as Attachment 2. |
RECOMMENDED that Council note the Minutes of the Gym and Swim Advisory Committee

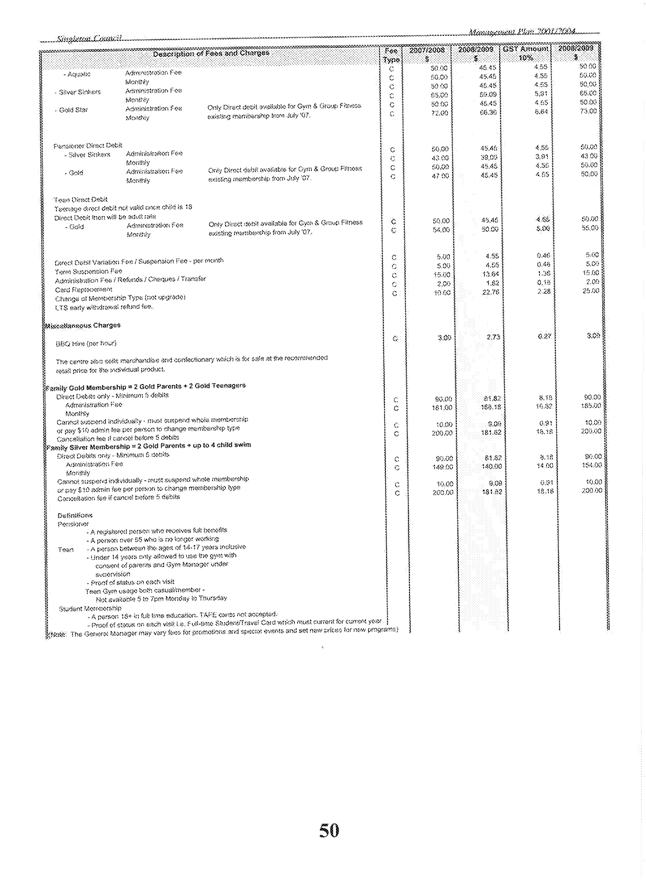

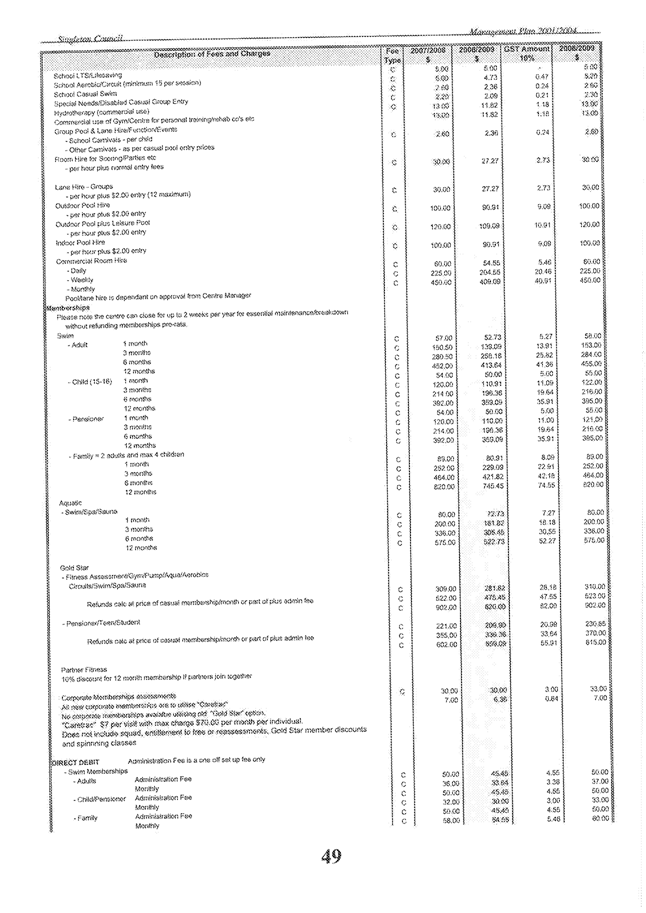

Meeting held on 13 February, 2008 and adopt the following recommendations
from the Committee:- 1. Financial Performance & Attendance Tony Moody advised the spike in
expenditure was due to a loan payment and payment of backwash recycling
project. Total additional costs in the
month was approximately $140,000. RESOLVED
that it be RECOMMENDED that
the Financial Performance and Attendance for the year to date up to 31st
January 2008 be noted; 2. Foyer
Refurbishment Update Currently timeline for
refurbishment of foyer has been established:- Monday 18th
February Bass
Flooring to commence laying of new carpet on indoor pool terrace area and
office. This should be completed by the 20th February. Monday 3rd March Andrew Hobbs Carpentry from Muswellbrook
will begin the removal of the old counter and the installation of the
new. Other works that will proceed
this installation include completion of replacement of carpets in foyer area,
various minor carpentry, painting jobs, electrical refitting for turnstiles
and computers and kitchen plumbing. It
is hoped that works will be completed by the 21st March. During the work the entry to and from the
centre will be via the crèche.
Customers will be kept informed of the proposed renovations. RESOLVED
that it be RECOMMENDED that the
Report on Foyer Refurbishment Update be NOTED. 3. Backwash
Recycling Plant Update Installation of the Backwash
Reverse Osmosis (RO) unit is completed and has been semi-operational since
the new year. Due to a few teething
problems the unit has not been fully functional but 6th February
2008 has been provided as a date for final tuning of system. System
suppliers “ipools” have not been happy with the delivery rate of a
submersible pump and are having the unit replaced to provide maximum output
for the system. Also a few minor leaks have had to be dealt with and a number
of parts replaced due to lack of promised quality. It
is expected that of the time of this meeting the project and all
commissioning and training be completed. RESOLVED that it be RECOMMENDED that the Report on
Backwash Recycling Plant Update be NOTED. 4. Fees and Charges for
2008/09 Average fee increase is 2.35%. The:- 2007/2008 Proposed
2008/2009 Adult Pool Entry Fee was $4.30 $4.40 Child Pool Entry Fee was $3.50 $3.60 Goldstar Monthly Direct Debit was $72/month $73/month RESOLVED that it be RECOMMENDED that the Draft Fees and Charges for the Singleton Gym
and Swim be included in the Council Management Plan for 2008/09. See
Attachment A. 5. Review
of New Years Day Attendance and Income The day was attended by 198 people. Additional
Income $ 528.83 Additional
Costs – wages $1,58468 Additional
Costs – Advertising $ 400.00 _______ Net
Additional Costs $1,455.85 RESOLVED
that it be RECOMMENDED that the
Singleton Gym and Swim open New Years Day in 2009. 6. Swim
Squad It is to be noted the
exceptional performance of the SASC at the recent State Age Titles at Sydney
Olympic Park Aquatic Centre (SOPAC) and highlighted in the Singleton Argus
Friday 1st February. The
10-12 year old representatives finished 11th in the state in the
overall team standings and provided 4 medal swims, 8 finalists ribbons, 2
State records and 2 All Comers records. The
13 – 18 year old group also finished with 6 finalists ribbons. Centre
coach, John Robinson, and the squad
children are to be congratulated on their success and continued dedication
and patronisation of the centre squad program and their enthusiasm for their
sport and behaviour at the centre. RESOLVED that it be RECOMMENDED that a letter be sent to
the Swim Coach, Mr. Robinson and the Centre Staff on the success of the Swim
Squad. 7. Maintenance Issues Broken window and door panes and
replacement and repair of mirrors at the centre due to OH&S risks have
set the centre back some $9500 in January.
Unfortunately we already have had a number of panes broken since
repairs were completed. Gym
and Swim staff will be talking to patrons and members to educate them in the
correct use of the sauna. The cost to replace and fit a new heater will be
$1,600. Plant
room Hypo tank has been replaced once again as previous tank was inadequate
as it had developed a substantial leak.
To fit and replace old tank cost $3500. Once again another unforeseen cost to the
centre but an unavoidable and priority repair. The replacement tank is to Certified
Designed Australian standard for storage of hazardous chemicals and as such
has a twenty (20) year life expectancy. RESOLVED that it be RECOMMENDED that the Report on Maintenance
Issues be NOTED. 8. Capital Works · Refurbishment and redesign of centre amenities; est. cost $160,000
for 2008/09. · Spinning Room est. cost; cira $45,000 – 2008/09. · Replacement Foyer roof and ceiling est; cost $120,000 circa –
2011-2012 · Solar Heating to Indoor Pool est; cost $60,000 circa – 2009 -2010 · Air Conditioning upgrade in Gym and Foyer Gym est; cost $40,000 · Car Park extension est. cost unavailable · Hydro pool est. cost $300,000 plus. RESOLVED that it be RECOMMENDED that the Report on
Capital Works be NOTED. 9. Hydrotherapy Pool The Committee talked about Hydrotherapy Pool Fund Raising Committee
Meeting in December 2007. Disability Access Committee Reps were unable to attend. There was general discussion on how to resolve the matter. RESOLVED that it be RECOMMENDED that the Gym and Swim
Advisory Committee meet with the Disability Access Committee to discuss all
relevant issues relating to the hydrotherapy /warm water pool project and
funding. |
AT-1View |
Minutes
Singleton Gym & Swim - 13 February 2008 |
4 Pages |
AT-2View |
Fees
& Charges |
3 Pages |
|
|
Minutes Singleton Gym &
Swim - 13 February 2008 |
Singleton Gym & Swim
Advisory Committee Minutes - 13 February 2008 |
|
|
MINUTES OF THE GYM & SWIM ADVISORY COMMITTEE –
HELD IN THE COMMITTEE ROOM – SINGLETON COUNCIL ADMINISTRATION CENTRE ON
WEDNESDAY 13 FEBRUARY 2008 COMMENCING AT 5.30 P.M.
ATTENDANCE:
Alan Fletcher –
Manager Parks & Facilities, Cr. John Martin, Cr Bill Langdon, Graeme Ward,
David Vaughan, Greg Norris, Cr Lee Gallagher, Sarah Withell, Gary Woodman -
Director Operations, Tony Moody – Manager Gym & Swim.
1. APOLOGIES
Steve McGrath, Cr Jon Doughty &
Representative from Disability Access Committee.
RESOLVED that the
apologies be accepted.
(B Langdon/J Martin)
2. CONFIRMATION OF MINUTES – 14 NOVEMBER 2007
RESOLVED that the Minutes of the Meeting held on 14 November
2007 be adopted
as a true and correct record.
(B Langdon/G Ward)
3. MATTERS
ARISING
3.1 Bill Langdon asked a question about refurbishment of foyer.
4. WELCOME OF NEW MEMBER
Mr
David Vaughan was welcomed by the Committee.
5. MANAGER GYM & SWIM REPORT
5.1 Financial Performance & Attendance
Tony Moody advised the spike in expenditure was due to
a loan payment and payment of backwash recycling project. Total additional costs in the month was approximately
$140,000.
RESOLVED
that it be RECOMMENDED that the
Financial Performance and Attendance for the year to date up to 31st
January 2008 be noted;
B
Langdon/G Ward
5.2 Foyer
Refurbishment Update
Currently timeline for
refurbishment of foyer has been established:-
Monday 18th
February Bass
Flooring to commence laying of new carpet on indoor pool terrace area and
office. This should be completed by the 20th February.
Monday 3rd March Andrew Hobbs Carpentry from Muswellbrook will
begin the removal of the old counter and the installation of the new. Other works that will proceed this
installation include completion of replacement of carpets in foyer area,
various minor carpentry, painting jobs, electrical refitting for turnstiles and
computers and kitchen plumbing.
It
is hoped that works will be completed by the 21st March. During the work the entry to and from the
centre will be via the crèche. Customers
will be kept informed of the proposed renovations.
.
RESOLVED
that it be RECOMMENDED that the
Report on Foyer Refurbishment update be NOTED.
B Langdon/G Ward
5.3 Backwash
Recycling Plant Update
Installation of the Backwash
Reverse Osmosis (RO) unit is completed and has been semi-operational since the
new year. Due to a few teething problems
the unit has not been fully functional but 6th February 2008 has
been provided as a date for final tuning of system.
System suppliers “ipools” have not
been happy with the delivery rate of a submersible pump and are having the unit
replaced to provide maximum output for the system. Also a few minor leaks have
had to be dealt with and a number of parts replaced due to lack of promised
quality.
It is expected that of the time of
this meeting the project and all commissioning and training be completed.
RESOLVED that it be RECOMMENDED that the Report on Backwash Recycling Plant Update be
NOTED.
(G Woodman/B Langdon)
5.4 Fees and Charges for 2008/09
Average fee increase is 2.35%. The:-
2007/2008 Proposed
2008/2009
Adult Pool Entry Fee was $4.30 $4.40
Child Pool Entry Fee was $3.50 $3.60
Goldstar Monthly Direct Debit was $72/month $73/month
RESOLVED that it be RECOMMENDED that the Draft Fees and Charges for the Singleton Gym
and Swim be included in the Council Management Plan for 2008/09. See
Attachment A.
(B Langdon/L Gallagher)
5.5 Review of New Years Day Attendance and Income
The day was attended by 198 people.
Additional
Income $ 528.83
Additional
Costs – wages $1,58468
Additional
Costs – Advertising $ 400.00
_______
Net
Additional Costs $1,455.85
RESOLVED that
it be RECOMMENDED
that the Singleton Gym and Swim open New Years Day in 2009.
(G Norris/G Ward)
5.6 Swim Squad
It
is to be noted the exceptional performance of the SASC at the recent State Age
Titles at Sydney Olympic Park Aquatic Centre (SOPAC) and highlighted in the
Singleton Argus Friday 1st February.
The 10-12 year old representatives
finished 11th in the state in the overall team standings and
provided 4 medal swims, 8 finalists ribbons, 2 State records and 2 All Comers
records.
The
13 – 18 year old group also finished with 6 finalists ribbons.
Centre coach, John Robinson, and the squad children are to be
congratulated on their success and continued dedication and patronisation of
the centre squad program and their enthusiasm for their sport and behaviour at
the centre.
RESOLVED that it be RECOMMENDED that a letter be sent to the Swim Coach, Mr. Robinson
and the Centre Staff on the success of the Swim Squad.
(G Norris/B Langdon)
5.7 Maintenance Issues
Broken window and door panes and
replacement and repair of mirrors at the centre due to OH&S risks have set
the centre back some $9500 in January.
Unfortunately we already have had a number of panes broken since repairs
were completed.
Gym and Swim staff will be talking
to patrons and members to educate them in the correct use of the sauna. The
cost to replace and fit a new heater will be $1,600.
Plant room Hypo tank has been
replaced once again as previous tank was inadequate as it had developed a substantial
leak. To fit and replace old tank cost
$3500. Once again another unforeseen
cost to the centre but an unavoidable and priority repair. The replacement tank is to Certified Designed
Australian standard for storage of hazardous chemicals and as such has a twenty
(20) year life expectancy.
RESOLVED
that it be RECOMMENDED that the
Report on Maintenance Issues be
NOTED.
(G
Norris/B Langdon)
5.8 Capital
Works
· Refurbishment and redesign of centre amenities; est. cost $160,000 for
2008/09.
· Spinning Room est. cost; cira $45,000 – 2008/09.
· Replacement Foyer roof and ceiling est; cost $120,000 circa – 2011-2012
· Solar Heating to Indoor Pool est; cost $60,000 circa – 2009 -2010
· Air Conditioning upgrade in Gym and Foyer Gym est; cost $40,000
· Car Park extension est. cost unavailable
· Hydro pool est. cost $300,000 plus.
RESOLVED that it be RECOMMENDED that the Report on Capital Works be NOTED.
(G
Norris/B Langdon)
6. GENERAL
BUSINESS
Graeme Ward - Talked about Hydrotherapy Pool Fund Raising Committee Meeting in December 2007.
Disability Access Committee Reps were unable to attend. There was general discussion on how to resolve the matter.
RESOLVED that it be RECOMMENDED that the Gym and Swim Advisory Committee meet with the
Disability Access Committee to discuss all relevant issues relating to the
hydrotherapy /warm water pool project and funding.
(G Woodman/G Norris)
7. NEXT MEETING
5.30 p.m. Wednesday 7 May 2008 in the
Committee Room.
BEING NO FURTHER
BUSINESS THE MEETING ENDED AT 7.05 P.M.
G:\OPERATIONS\PARKS_&_FACILITIES\COMMITTEES\Gym
& Swim\Minutes\Minutes 2008\Minutes - G&S Advisory Com - 13 Feb 08.doc
|
|
Fees & Charges |
Singleton Gym & Swim
Advisory Committee Minutes - 13 February 2008 |
|
|
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
|
|
|
8. |
Gym &

Swim Five Year Capital Works Program Author: Alan Fletcher |
FILE: 01/0298 |
Executive
Summary: This report sets out the draft five year capital works program for the Singleton Gym & Swim. The report also sets out funding options for the 2008/09 year. The Gym & Swim Advisory Committee have considered the capital works program. The Advisory Committee recommendations form the basis of the recommendations of this report. See the minutes of the 13 February 2008 Gym & Swim Advisory Committee meeting in this business paper. |
Background:
The Capital Works items for the next five
years have been listed in the table below.
The items include some new items and also items which are maintenance,
but due to their cost and the fact the work will extend the life of the asset,
have been classed as capital. The likely
source of funding for each item is also listed.
Year |
Item |
Estimated cost |
Source of funds & comments |
2008/09 |
Refurbishment
of amenities |
$160,000 |
Parks
& Facilities special rate variation funding |
Spinning
room ( room set up for exercise bike programs) |
$45,000 |
Equipment
to be leased and paid as an operating cost |
|
2009/10 |
Solar
heating to indoor pool |
$60,000 |
Parks
& Facilities special rate variation funding |
Hydrotherapy
pool |
$310,000 |
Grants
and contributions. To be arranged by Hydrotherapy pool fund raising
committee. |
|
2010/11 |
Air
conditioning upgrade in gym and foyer |
$40,000 |
Parks
& Facilities special rate variation funding |
2011/12 |
Replacement
of foyer polycarbonate roof and ceilings. Includes modifications to eliminate
leaking 25m pool terrace roof problem. |
$120,000 |
Parks
& Facilities special rate variation funding |
2012/13 |
Car
park extension (30 spaces @ $3,000 per space) |
$90,000 |
Parks
& Facilities special rate variation funding |
Management Plan: The items included in the capital works plan are consistent with the goals of Council’s Management Plan, particularly goal number 0408 - Maximise customer numbers, 0409 - Increase membership and 0400 - Implement Asset Management Strategy.
Council Policy: The Singleton Gym & Swim Plan of Management (Policy 572/00) includes capital works. Although eight years old the plan lists current items e.g. the hydrotherapy pool. The majority of items in the list have been completed or are underway e.g. kiosk upgrade, swim clubhouse construction, gym extension.
Legislation: N/A
Sustainability:
Social:
The Gym & Swim is an important part of the social infrastructure of Singleton. Most of the capital works set out in this program are major maintenance in nature. It is important that Gym & Swim is satisfactorily maintained to ensure the facilities add sustained social value to the community.
Environmental:
N/A
Financial:
The five year capital works
program shown in the table above has the funding source for each item shown.
The funding for 2008/9 from the Parks & Facilities special rate variation
funding has been arranged for the change room refurbishment. The spinning
room (exercise bike ) equipment is to be
leased as is all the other gym equipment at the centre. This will be paid for
from the annual operating budget for the centre.
Subsequent years (years 2 to 5 of the five year program) have had likely
sources of funds identified.
Consultation:
The Gym & Swim Advisory Committee have been consulted on the draft capital works list. See the Committee minutes in this business paper. The Committee resolved to recommend to Council that the draft capital works five year program be adopted.
Risk Management:
The refurbishment work proposed in the plan will help minimise the public liability risk to Singleton Council by having well maintained and safe facilities.
Options:
The options available are to either:-
· Adopt the five year capital works program
recommended by the Advisory Committee or,
· Not adopt the program.
Conclusions:
Most of the items listed are major
maintenance items or changes to existing services . The proposed five year
capital works program will help sustain the Singleton Gym & Swim by
upgrading facilities to maintain a satisfactory level of service to our
community. The option to adopt the program is recommended.
RECOMMENDED that the Gym & Swim five year capital works program set out below be adopted:
|
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
|
|
|
9. |
Council &
Community Buildings - Five Year Capital Works/Heavy Maintenance Program Author: Alan Fletcher |
FILE: 01/0259-2 |
Executive
Summary: This report
sets out a Five Year Capital Works/Heavy Maintenance Plan for Council and
Community buildings in
the table below. Many of these items
are maintenance by nature but due to the significant cost and the fact that
the work will extend the life of the building they are listed as capital
items. Where the work is replacement of worn out items eg carpet replacement,
the items have been placed in the maintenance budget for the building. As no capital works funds are likely to be available from the general fund coin exercise for 2008/09 all the works are funded from :- · Grants · User contributions or · Parks & Facilities special rate
variation. |
Background:
The Capital Works items for the next five
years have been listed in the table below.
The items include some new items and also items which are maintenance,
but due to their cost and the fact the work will extend the life of the asset,
have been classed as capital. The likely
source of funding for each item is also listed.
Year |
Item |
Location |
Estimated
cost |
Council
Contribution |
Source of
funds & comments |
2008/09 |
Refurbishment of amenities |
Gym & Swim |
- |
- |
Included in Gym & Swim capital works. |
Visitor information Centre |
|
- |
- |
Included in Tourism capital works |
|
Rural Fire Stations toilets/kitchens |
Various |
- |
- |
As funding becomes available from RFS or brigades. Included in the
Emergency Serv capital works |
|
Amenities building |
|
$210,995 |
$40,000 |
Was adopted as capital works priority No1 for buildings 2007/8. $40,000
(council contribution) has been placed in restricted asset for the project.
Go ahead subject to successful grants and user funds for balance. |
|
Stormwater drainage works & harvesting |
Civic Centre |
$45,000 |
$12,000 |
Council contribution from Parks & Facilities special rate
variation. Remainder from Aust Community Water Grant. |
|
Replace auditorium air conditioner (A/C) cooling tower |
Civic Centre Auditorium |
$25,000 |
$25,000 |
Parks & Facilities special rate variation |
|
Replace A/C unit No3 |
Civic Centre Admin Bld. |
$30,000 |
$30,000 |
Parks & Facilities special rate variation |
|
Refurbish playgroup building |
|
- |
- |
Not required due to building being demolished or removed due to
proposed VIC construction on the same site. |
|
2009/10 |
Refurbish toilets |
|
$40,000 |
$40,000 |
Cost may be greater than $40,000 due to the likely need to modify
building to meet disability access Australian Standard AS1428. Currently
being investigated. Source of funds to be determined. |
Remodel back room / Spandeck extension (The extension leaks badly in
rain) |
Civic Childcare (H. Prelude / OOSH) |
$25,000 |
$25,000 |
Source of funds to be determined |
|
Replace 2 split system A/Cs. |
Civic Childcare |
$7,500 |
$7,500 |
Source of funds to be determined |
|
Refurbish kitchen/extension |
Civic Centre Auditorium |
$40,000 |
$40,000 |
To be funded from kitchen rental income. |
|
Kitchen appliances |
Civic Centre Auditorium |
$95,000 |
$95,000 |
Source of funds to be determined |
|
2010/11 |
|
Depot at |
$30,000 |
$30,000 |
Source of funds to be determined |
Construct parks maintenance shed |
|
$30,000 |
$30,000 |
Source of funds to be determined |
|
Replace air conditioner |
Senior Citz Centre |
$15,000 |
$15,000 |
Source of funds to be determined |
|
Extension to Netball Amenities/Kiosk |
|
$180,000 |
$180,000 |
Source of funds to be determined |
|
Replace outside lights for carpark |
Civic centre N.E. side |
$24,500 |
$24,500 |
Source of funds to be determined |
|
Sub floor rust repairs or:- |
Alroy playgroup/ community building |
$20,000 |
$20,000 |
Source of funds to be determined. Note that this building is a demountable
temporary building. A replacement permanent building needs to be planned, see
below. |
|
Replace temporary building with a permanent building |
Alroy playgroup/ community building. |
$310,000 |
$310,000 |
Source of funds to be determined. Existing building area is 155m2. Replacement bld same size cost
estimated at $310,000. This item should only proceed if substantial user
demand is confirmed. |
|
2011/12 |
Re sand and finish floor in main
hall |
Civic Centre Auditorium |
$21,000 |
$21,000 |
Source of funds to be determined |
Replace verandah tiles |
Alroy amenities |
$12,000 |
$12,000 |
Source of funds to be determined |
|
Lift refurbishment |
Mechanics Institute, |
$10,000 |
$10,000 |
Source of funds to be determined |
|
Carpark regrade and reseal |
SES |
$12,000 |
$12,000 |
Source of funds to be determined |
|
2012/13 |
Extend or replace amenities |
Civic Park |
$150,000 |
$150,000 |
Source of funds to be determined |
Refurb amenities kitchen |
|
$8,000 |
$8,000 |
Source of funds to be determined |
|
Replace stage floor |
Civic Centre Auditorium |
$30,000 |
$30,000 |
Source of funds to be determined |
|
Replace amenities roof |
Allan Bull Reserve |
$18,000 |
$18,000 |
Source of funds to be determined |
|
Replace light fittings |
|
20,000 |
20,000 |
Source of funds to be determined |
|
Plaster, brickwork repairs due to damp and movement |
Mechanics Institute, |
$25,000 |
$25,000 |
Source of funds to be determined |
Management Plan:
The items included in the capital works plan are consistent with the goals of Councils Management Plan, particularly goal number 0355 – Implement planning strategies to secure high quality community facilities within Council’s financial capacity, 0365 - Encourage self help for user groups.
Council Policy:
Because
of the various building site locations there are a number of plans of
management which cover the buildings. For example, Plan of management for
Legislation: Not applicable
Sustainability:
Social:
The supply of adequate and well maintained buildings is essential for the effective operation of sporting, cultural and operational facilities in the Singleton local government area. The proposed 5 year capital works plan will help meet this requirement.
Environmental:
Not applicable.
Financial:
The funding for 2008/09 from the
Parks & Facilities special rate variation funding has been arranged for the
following Civic Centre works:
· Stormwater drainage works & harvesting
· Replace auditorium air conditioner (A/C)
cooling tower
· Replace Admin Building A/C unit No3
All other items for 2008/09 have
not had funding identified.
Subsequent years (years 2 to 5 of
the five year program) have had likely sources of funds identified.
Consultation:
Buildings such as the netball amenities/kiosk
which have been included in the program have come about from discussions with
the users. With the netball building proposal the item was also included in the
Risk Management:
The refurbishment work proposed in the plan will help minimise the public liability risk to Singleton Council by having well maintained and safe facilities.
Options:
The
options available are to either:-
· Adopt the five year capital works program or,
· Not adopt the program.
Conclusions:
Most of the items listed are major maintenance items or replacement of existing facilities. The proposed five year capital works program will help sustain the Singleton Council’s buildings by upgrading facilities to maintain a satisfactory level of service to our community. The option to adopt the program is recommended.
RECOMMENDED that the Council and Community Buildings Five Year Capital Works/Heavy Maintenance Program shown in the table below be adopted;-
|
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
|
|
|
10. |
Recreation
& Landscaping (Parks) - Five Year Capital Works Program/Heavy Maintenance Author: Alan Fletcher; Stuart Neal |
FILE: 02/0146 |
Executive
Summary: This report
sets out a five year capital works/heavy maintenance plan for recreation and
landscaping in the
table below. Many of these items have
been maintenance by nature but due to the significant cost and the fact that
the work will extend the life of the building they are listed as capital
items. The majority of items for year 1 (2008/09) are funded from :- · Grants; · Sec 94 funds · User contributions or from the; · Parks & Facilities special rate variation. One item, Cook Park Field No3 irrigation would require Council general fund capital funding of $39,545 if is to proceed. Funding for items in years 2 to 5 of the
works program have not been identified. |
Background:
The Capital Works items for the next five
years have been listed in the table below.
The items include some new items but generally items which are
maintenance or replacement, but due to their cost and the fact the work will
extend the life of the asset, they are classed as capital. The likely source of funding for each 2008/09
item is also listed.
|
$33,000 |
2007/08 |
Priority No. 1 |
Management Plan:
The items included in the capital works plan are consistent with the goals of Councils Management Plan, particularly goal number 0355 – Implement planning strategies to secure high quality community facilities within council’s financial capacity,, 0365 - Encourage self help for user groups.
Council Policy:
Because
of the various sites the projects are located on there are a number of plans of
management which cover the projects. For example, Plan of Management for
Legislation: The charter of the Local
Government Act 1993 includes: -
· To promote and to provide and plan
for the needs of children.
· Council is the custodian and trustee of public assets and to effectively maintain the assets.
Sustainability:
Social:
Provision
of parks and facilities in our community is part of Councils social
responsibilities. Open space and recreation facilities are an important part of
the social fabric of Singleton. It is important to ensure Councils facilities
are safe, fun and attractive to use for children and their carers.
Environmental:
Not applicable.
Financial:
The five year capital works
program shown in the table above has the funding source for each item shown for
2008/09. The only item that does not have the funding source confirmed is the
$39,545 Council contribution required for the Cook Park No3 field irrigation
project. If the funding can not be provided from the general fund capital works
the project should be cancelled and the grant returned.
The funding for subsequent years 2 to 5 is to
be determined.
Consultation:
Many of the items in the capital works program have come about from requests from users or through consultation through the Singleton Sports Council. For example the proposed Cook Park Field 3 irrigation project.
Risk
Management:
The refurbishment work proposed in the plan will help minimise the public liability risk to Singleton Council by having well maintained and safe facilities.
Options:
The
options available are to either:-
- adopt
the five year capital works program or,
- not adopt the program.
Conclusions:
Most of
the items listed are major maintenance items or replacement of existing
facilities. The proposed five year capital works program will help sustain the
Singleton Council’s parks by upgrading facilities to maintain a satisfactory
level of service to our community. The option to adopt the program is
recommended
RECOMMENDED that the Recreation & Landscaping (Parks) five year capital works/heavy maintenance program shown in the table below be adopted;-
|
Alan Fletcher Gary
Woodman
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Water and Waste Report No. 3/08 |
|
|
1. |
Sewer Five
Year Capital Works Program Author: Brian Carter |
FILE: 01/0153 |
Executive
Summary: This detailed capital works program covers all sewer projects which have been identified through Council’s long term sewer financial modelling, and which will fall due for construction in the next five years. There are also several new projects, and some which upon detailed investigation, require some change of scope in order to provide the most cost effective solution for changing circumstances. Currently, the procurement costs through
external contractors, for major sewer capital works have increased
significantly due to the high demand in the market. In some cases, costs have increased up to
30% over two to three years. Provision
for likely increased costs for projects falling into these categories has
been made. |
Background:
Brief explanatory notes, previous history and
other matters relevant to Council’s decision on funding allocations over the

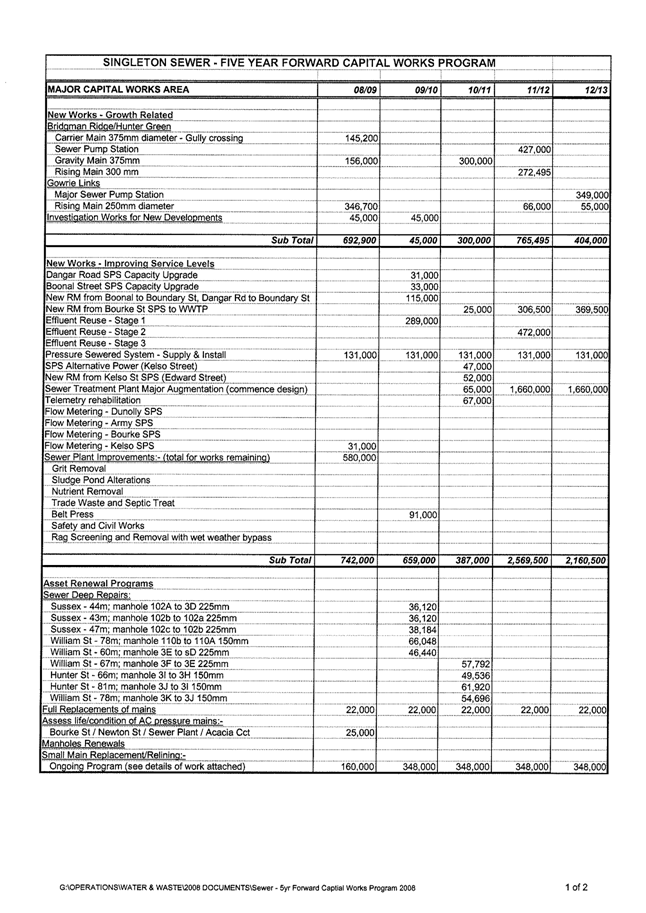

next five years are presented below.
They relate to specific projects identified in Attachment 1 and
Attachment 2 to this report.
New Works – Growth Related
This section of the schedule in Attachment
1 deals with work that has been identified in Council’s Sewer Developer
Charges Plan as necessary infrastructure, with the majority of costs being
recovered from Sewer Development Charges.
It is now possible to more accurately forecast the year of
construction. Should development works
proceed more rapidly than has been identified in this plan, there will need to
be consideration of the need for “forward funding” by developers. The method and general need for this has been
reported to Council in the past.
Bridgman
Ridge/Hunter Green
A 375 mm gravity main will have construction
commence in 2008. Its diameter has been
established as satisfactory for servicing the entire development area. The developer has indicative plans showing
the general alignment required for this main.
The first 130 metres of this main will be
fully designed and constructed by Council.
It will have to cross
The remaining sections of this
main will be much easier to construct, and when completed, will total 1,070
metres in length. These sections of
mains are best constructed progressively by the Developer, as they are required
for stages of land releases. Council
will pay for the construction of this work through developer contribution
funds. Allowance has been made for this
work to be completed predominantly in 2008/09 and 2010/11.
Total costs for this main were originally
estimated to be $329,000. They are now
expected to cost $601,200 in total. Cost
increases are due to the construction difficulty expected and detailed above,
the larger length of main required and also the need for a larger diameter in
sections of the main, to accommodate the larger number of lots now proposed in
the area.
The Major Sewer Pump Station for this site is
to be constructed close to the intersection of
The 300 mm pressure sewer main has been
upsized from the originally proposed 225 mm main, again to take all sewer loads
from what is now a larger catchment area.
In order to minimise retention times in this main in the early years,
when it will not be fully loaded, it is proposed that a 150 mm diameter main be
laid in the same trench, to take initial flows.
Whilst this may seem unusual, it is actually a commonly used method to
minimise the build up of corrosive and poisonous gases in Councils sewer
system. It not only provides safer
access for maintenance personnel when required, it also prolongs the life of
pipelines downstream, which would otherwise suffer premature corrosion
attack. The overall length of the main
will now be 1,020 metres, a somewhat shorter length than originally thought
required.
As a result of the changes described above,
the cost of this main will increase from the $237,000 originally estimated, to
$272,495. It is projected for
construction in 2011/12, the same year as the pump station.
Gowrie Links
Council’s initial works planning for this area
was for the construction of a major sewer pump station capable of servicing the
entire site, and the provision of a pressure sewer main crossing the Hunter
River and proceeding directly to Singleton’s Sewerage Treatment Plant.
As was reported to Council in March 2007, the
project costs and alignment of the sewer rising main were to be reviewed when
more information from the developer was available. Also the timing of the
Initial estimates of the cost of this
infrastructure were completed in May 2005, at a time when a total of 550
residential dwellings were expected to be released in Gowrie Links. The main was to be 3,000 metres in length,
225 mm in diameter and its total cost was expected to be $578,070.
In order to ensure that a timely and cost
effective solution is provided, a detailed feasibility and cost analysis was
undertaken, which looked at a range of options.
The lowest cost option available is detailed below.
It is now proposed to extend the rising main,
which will need to be 250 mm in diameter to accommodate what is now expected to
be 725 residential dwellings, to Council’s existing sewer pump station located
at Dunolly. The total length will be
2,025 metres, at an estimated cost (when fully built) of $467,700. This will also include the cost of a 150 mm
diameter main to take initial flows. The
major sewer pump station for the site will not now be required to be built
until 2011/12. Its revised estimated
cost is $427,000.
The developer has advised that they intend to
construct a second small sewer pump station on the Gowrie Links site, in order
to minimise start up costs. This work
will not be funded by developer contributions.
Depending upon workloads at the time this occurs, Water and Waste may
submit a bid to design and construct this small pump station for the developer.
New Works – Improving Service Levels
This section of the schedule deals with new
works and major improvements to existing facilities, for things such as to
increase capacity or to provide a higher level of sewage treatment.
The need for this upgrade work to accommodate
infill development and increased sewage loadings has been identified for some
time and estimated costs for the work have not altered since my last report on
this matter in 2007.
New Rising
In order to confirm the timing requirements
for this project, the Department of Commerce was commissioned to complete a
capacity analysis on the current 500 mm Asbestos cement main which is utilised
by both
Provision has also been made ($25,000 in
2008/09) to take core samples from this 24 year old pipeline, and assess its
condition. Asbestos cement sewer mains,
under some circumstances, have been known to deteriorate rapidly, and the
assessment will aid in Council’s asset management planning.
Effluent Reuse
Provision of $289,000 for this project has
been allowed in Council’s long term financial model, and was reported to
Council in March 2007. It has been earmarked for provision of reclaimed treated
wastewater to the Gowrie Links golf course, and relied upon the installation of
other pipelines to be cost effective.
I can report that should this need to go
ahead as a stand alone project, it is estimated to cost $507,000. There has also been provision made in 2011/12
for expenditure of $472,000 on Stage 2 of effluent reuse. This was to be allocated to works required to
be undertaken by Council to allow the reuse of 1,000 Megalitres per annum,
currently the subject of an Expression of Interest (EOI) process. It will be required to undertake a variety of
works, such as provision of Ultra Violet disinfection of reclaimed water.
An external report commissioned by Water and
Waste, and detailing a number of options for supplying irrigation water to
Gowrie Links has been completed and will be submitted to Council separately. I have been waiting until Council’s financial
obligations with the EOI are clearer, and this may take several months. It is recommended that Stage 1 and 2 effluent
reuse allocations be noted only tonight, pending Council’s final decision on
allocation of the funds to be made at a later date.
Sewer Treatment
Works Augmentation
This major capital works upgrade has been
deferred for one year for commencement, again following preliminary capacity
analysis by the Department of Commerce.
Whilst total cost expected remains $3.4 million, its commencement date
has been changed to 2011/12. The final
capacity analysis study (reported in March 2007) will still be required, when
the building take up rates from current rezoned areas can be better
established.
Asset Renewal Programs
These are mainly continuing programs which
allow for orderly replacement of aged or worn infrastructure. Prioritisation of these programs is based on
either the age of the asset or its breakdown and repair history. Extensive use of CCTV camera inspections of
sewer lines is also used.
Sewer Deep Repairs
Provision for this item has not changed in
timing, or in total budget allocation.
Manhole Renewals
Council has for some years, carried out
routine maintenance of manholes, including their location and minor
modifications such as raising their height to ground level, as part if its
maintenance fund allocations. Only
complete manhole renewals have been provided for in the capital works program,
and these have been dwindling.
There is no real need to continue the budget
vote under capital works and full provision will be made for this in Council’s
maintenance vote for sewer manholes in the future.
Small Main
Replacement/Relining
Funding for this continuing program remains
basically unchanged from previous years.
As a result of recent inspections for manhole
accessibility, the risk to Council of a number of sewer pipelines in the CBD (
The Council approved relining program has
therefore been adjusted to allow for the relining in 2008/09 of all sewer
pipelines fitting the above description.
This will minimise the risk of sewer blockages or even collapse in these
old pipelines and reduce Council’s risk exposure. The full list of sewer pipelines identified

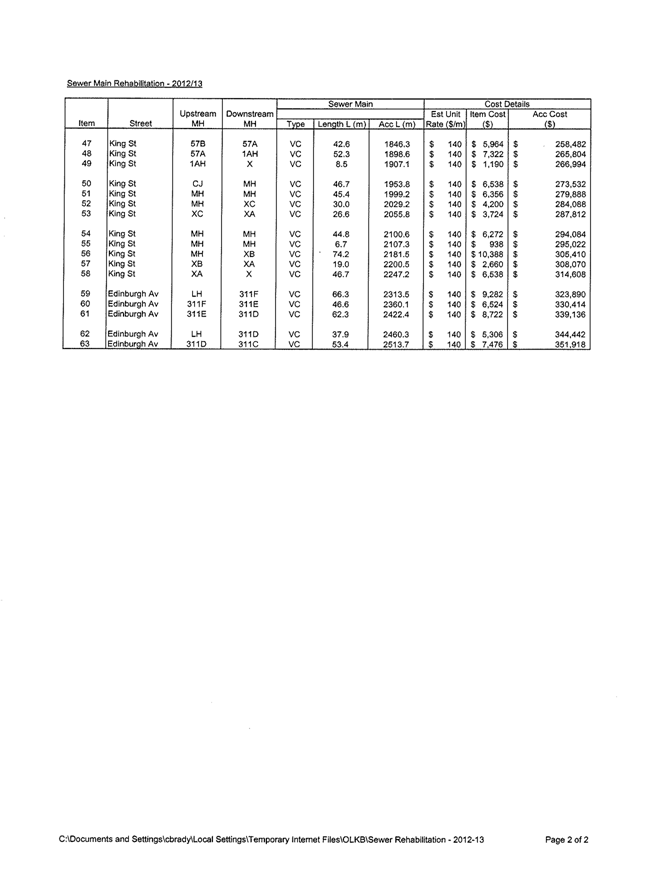

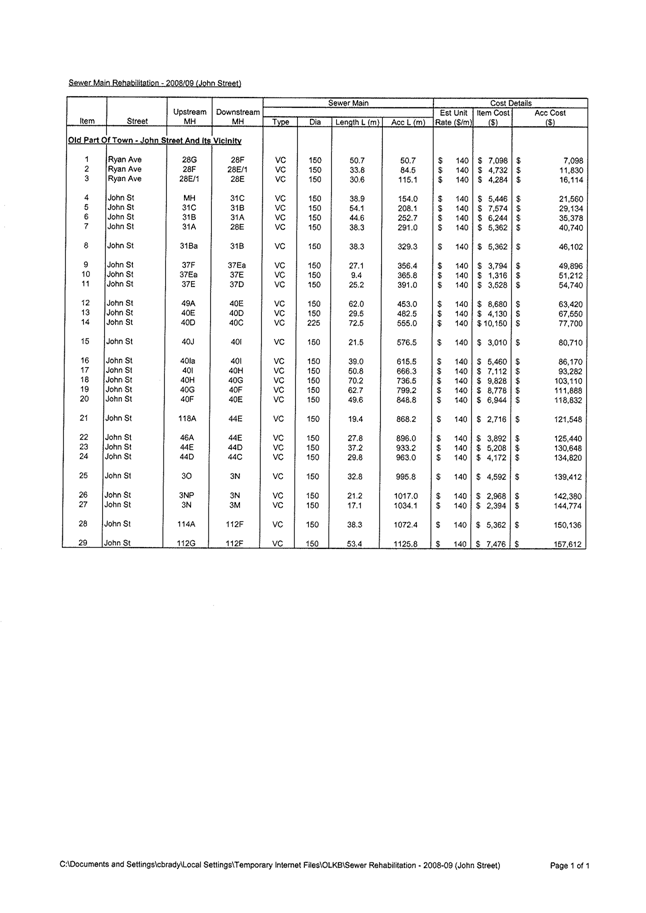

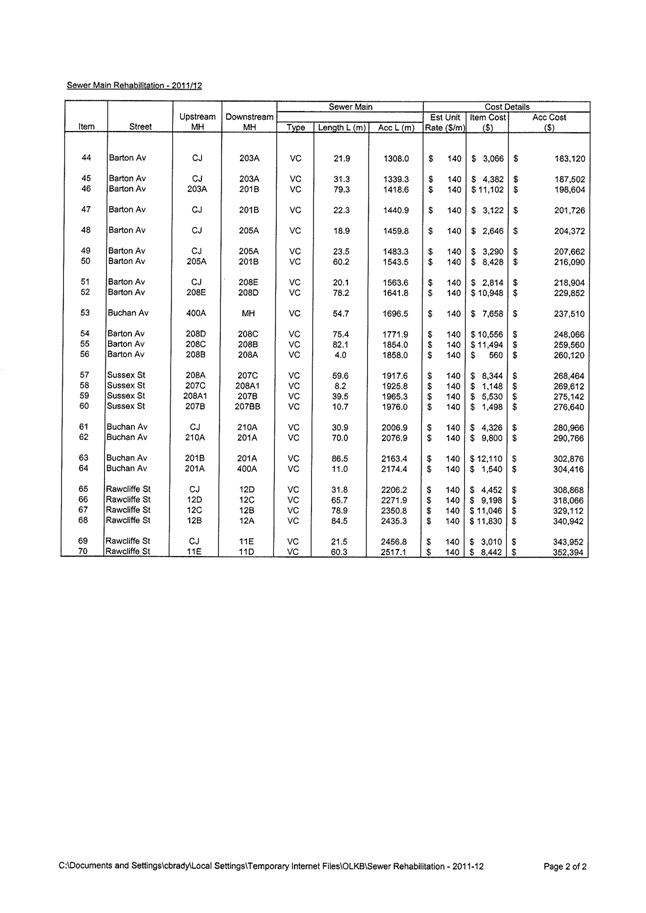

for this relining program is at Attachment 2.
A plan showing the physical location of pipes to be relined in 2008/09
is at Attachment 3.
Management Plan:
This capital works plan has been prepared using forward financial projections from Council’s Sewer Financial Model, Developer Servicing Plans and various technical reports. It is consistent with Council’s current Management Plan.
Council Policy:
This report does not require the formulation of any new policy, and does not impact on existing Council Policy.
Legislation:
Not applicable.
Sustainability:
Social:
Due to the wide range of projects
proposed in the capital works plan, there will be many positive outcomes for
the community. These include hygiene and
secure sewer collection and transport systems, as well as treatment. Some minor impacts during construction will
be experienced by a small number of residents.
The financial outlays are considered appropriate in order to provide the
many benefits to the community.
Environmental:
Some of the projects nominated in the capital works plan will have an impact on the environment, and will require a satisfactory Review of Environmental Factors, before they can proceed.
Financial:
Generally, new projects have been
formulated taking into account whole of life costs. The Major Sewer Plant Augmentation will
require a whole of life cost analysis during the concept and design phase of
the project, and is expected to cost $3.4 million.
Replacements and renewals have
been formulated using maintenance and repair history, asset life and where
possible, condition monitoring.
Whilst income is to be received
from Developer charges over the coming years, there may well be cash flow
problems during the coming five years if growth rates predicted do not
materialise.
Consultation:
It is envisaged that initial consultation with the community will be by way of the Management Plan public exhibition. Many of the projects will require further written advice or advertisement in the media.
Risk Management:
Many of the projects nominated in this report are in the early stages of formulation. Risk Management measures will be refined and developed in the main, closer to their actual construction dates.
Options:
Options for major projects have already been canvassed through previous Management Plans, and Developer Contribution Plans. The Options for Sewer Effluent Stages 1 and 2 Reuse will be developed through a separate report.
Conclusions:
The five year capital works plan identifies $11.6 million of projects, including $2.2 million for new development areas. Whilst we will have an estimated level of internally restricted assets for infrastructure works of $7.6 million at the end of 2007/08, long term modelling for the Sewer Fund completed in 2005 indicated we were likely to need borrowings of up to $3 million to provide both a major sewer plant augmentation and infrastructure for development areas over the five year period. Careful consideration of both the timing of works (delay as long as possible), as well as forward funding by Developers for all or part of the off site sewer infrastructure is required.
RECOMMENDED that the five year
capital works plan (2008/09 to 2012/13) presented in this report be adopted. |
AT-1View |
Sewer
Five Year Forward Capital Works Program |
2 Pages |
AT-2View |
Sewer

Main Rehabilitation |
9 Pages |
AT-3View |

Reline |
1 Page |
Manager Water and Waste Report
No. 3/08 |
|
Sewer Five Year Forward Capital
Works Program |
Sewer Five Year Capital Works
Program |
|
|
Manager Water and Waste Report
No. 3/08 |
|
Sewer Main Rehabilitation |
Sewer Five Year Capital Works
Program |
|
|
Manager Water and Waste Report
No. 3/08 |
|
Reline |
Sewer Five Year Capital Works
Program |
|
|
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Water and Waste Report No. 3/08 |
|
|
2. |
Waste Five
Year Capital Works Program Author: Leisa Parsons |
FILE: 01/0229-5 |
Executive
Summary: The detailed capital works plan submitted for Council’s consideration covers all landfill works required for the next five years as well as provision of a recycling drop off facility at Singleton Landfill. Provision has been removed for the capital works expenditure associated with the transfer station and trucking of waste to Raymond Terrace. |
Background:
The detailed waste capital works program is
at Attachment 1 to this report. In summary,
the total expenditure on landfill related works for the next five years is
expected to be $2.89 million. Whilst
there have been some changes in the scope of work, (described in detail below),
expenditure overall remains in line with Council’s 12 year financial model for
Waste Service Provision.
The leachate pipeline to sewer was originally
intended to be installed in conjunction with the construction of Landfill
Extension Stage 4a in 2007/08. However,
in order to confirm if enough leachate is generated to warrant the direct
connection to the sewer, landfilling in Stage 4a needs to be operational. Also the diameter of the pipeline can only be
determined once we have more accurate information on the leachate quantity
generated. It is proposed therefore to
construct the leachate pipeline in 2009/10, when more accurate design
information can be attained, at an estimated cost of $250,000. In the interim, leachate will continue to be
stored on site and trucked to Council’s sewer plant when required.
In order to ensure reduced construction
costs, due to economies of scale, it is proposed to construct the approved
Landfill Extension Stage 4b and 4c together in 2010/11. The cost of these works have been revised, using
estimates from consultant, Parsons Brinckerhoff and existing contract prices
obtained for the construction of Landfill Extension Stage 4a which is currently
in progress.
It was originally intended for Council to
construct a small vehicle drop off facility and transfer station as part of the
capital works program. It is now
proposed that tenders be called for the design, construction and operation of
the small vehicle drop off facility and transfer station as part of the tender
for the transfer of waste to Port Stephens – Alternative Waste Technology (AWT)
Facility. It is proposed to commence
sending waste to Raymond Terrace in 2009, subject to satisfactory financial
arrangements being reached with Port Stephens Council.
A recycling drop off facility is proposed to
be constructed in 2011/12 at an estimated cost of $154,500 down from the
$206,600 previously reported to Council in March 2007. This revised price was provided by consultant
Quadro
Original projections were that the landfill
(including extension) would be filled in 2013/14. The program and timing of capital works has
been adjusted to take into account the records of recent overall tonnages of
waste received at the landfill, together with a reduction of tonnages
anticipated when domestic waste is transported to Port Stephens in 2009. Whilst landfill life will need to be
monitored on an ongoing basis using actual tonnage figures it is now estimated
that the landfill’s life will extend to at least 2014/15, provided domestic
waste is transferred to an alternate facility, as is proposed.
Some significant increases have been made in
the capital works allowances for final capping of the various landfill
stages. Cost advice from consultant,
Parsons Brinckerhoff has been used in the preparation of the estimates for
final capping, as well as quantities consistent with the EPA General Terms of
Approval for this project. Singleton,
along with other Hunter Valley Council’s operating landfills are involved in a
joint project seeking to prove that smaller depths of final capping can provide
adequate environmental protection for the landfill. Therefore, there is a possibility that final
capping costs may be reduced.
Management Plan:
The items included in the capital works plan are consistent with the goals of Council’s Management Plan, particularly goal number 2475 – Waste Management Improvement Initiatives, goal number 0316 – Revision of Financial Models and goal number 0317 – Implement Alternate Technologies.
Council Policy:
This report does not require the formulation of a new policy, and does not impact on existing Council Policy.
Legislation:
Not applicable.
Sustainability:
Social:
Provision of a well run landfill,
and waste management improvements such as a recycling drop off facility will
provide great benefit to the community at large. The financial outlays are considered
appropriate in order to provide these essential services to the community.
Environmental:
Landfill operation has the
potential to impact on the environment, and in order to minimise this
possibility, safeguards and operational procedures identified in the
Development Consent for the site, and Council’s EPA Licence will be followed.
Financial:
A whole of life costing approach
has been used in the formulation of the capital works program. Any alterations to operational costs are also
identified for waste budgeting purposes, and final rehabilitation and
monitoring of the landfill is included.
All capital works
planned for the Waste Program Area are currently proposed to be funded by means
of cash reserves generated for this purpose.
The total estimated waste cash reserves at 30 June 2008 will be $1.7
million, which allows for full expenditure on Landfill Extension Stage 4a
construction being undertaken in 2007/08.
Consultation:
Whilst there was extensive community consultation regarding the Development Application for the landfill extension, it is anticipated that the capital works plan will be communicated through the public consultation process required as part of Council setting its 2008/09 Management Plan.
Risk Management:
Risk Management measures will be developed, in the main, closer to actual construction times for individual projects nominated in this report, and particularly through Council and Contractor safety management plans.
Options:
Options for the landfill have already been canvassed and are fixed.
Conclusions:
Detailed waste capital works items for the next five years have been identified. Continued care will be required to ensure adequate revenue is available to meet expenditure commitments for capital works over the coming years.
RECOMMENDED that the five year
Waste Capital Works Plan presented in this report be noted, and the capital
works proposed for 2008/09 be approved. |
AT-1View |
Waste Five Year Forward Capital Works Program |
2 Pages |
Manager Water and Waste Report
No. 3/08 |
|
Waste Five Year Forward Capital
Works Program |
Waste Five Year Capital Works
Program |
|
|
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Water and Waste Report No. 3/08 |
|
|
3. |
Water and
Sewer Reports - 01/01/2008 - 31/01/2008 Author: Ben Sim |
FILE: 01/0153 |
Detail: |
a. Singleton Water Supply
|
01/01/08 – 31/01/08 |
2007 Figures |
Total throughput from dam was |
218 ML |
289 ML |
Consumption |
|
|
Town |
185 ML |
246 ML |
Army |
4 ML |
11 ML |
Abattoir |
7 ML |
9 ML |
Mount Thorley/Broke |
8 ML |
6 ML |
Standpipe (water to Industry & Rural) |
14 ML |
17 ML |

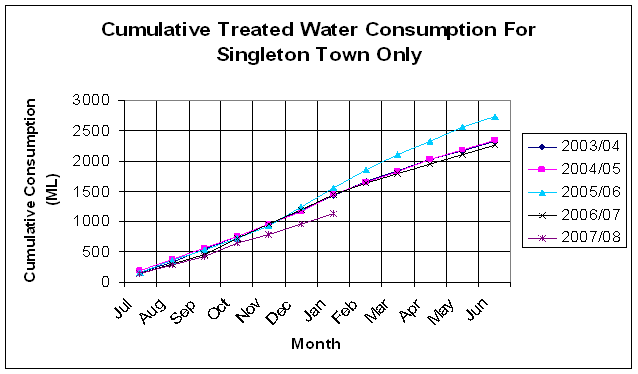

The trend in treated
The graph shows that during the last five years, this years cumulative treated water consumption for the month of November has remained the lowest.
Average
Daily Water Consumption for
As shown
on the above table, the average daily
Dam Percent Full
From the
NSW Water Information website, Glennies Creek Dam was 44% full on 31 January
2008. Thus in the month of January 2008,
the water storage volume in the dam has increased by 5%.
New Services
Six new
services were installed this month.
Service Repairs
19
service repairs were carried out this month, including two complete renewals.
Main Breaks
Three
main breaks were repaired this month:
·
·
·
Meters M & R
30 water meters were replaced this month.
Valves and Hydrants M & R
A program has commenced this month; for the
checking, cleaning and painting of valves and hydrants around the town.
Valves were installed/repaired/replaced this
month at the following two locations:
· New
·
Hydrants were repaired/replaced this month at
the following locations:
· New
Mains Replacement/Relocation
Approximately 20 metres of 50mm diameter
galvanised pipe across the first causeway along
The galvanised pipework at Judan Road Pump
Station was replaced this month, since showing signs of corrosion.
Glennies Creek Booster Pump Station
Construction of the booster pumping station
was continued this month and near completion. Works remaining consist of
electrical equipment installation and commissioning.
b.
|
01/01/08 – 31/01/08 |
2007 Figures |
2006 Figures |
2005 Figures |
2004 Figures |
The total amount of water pumped to the mines in January was |
103 ML |
372 ML |
362 ML |
103 ML |
165 ML |
The trend in raw water consumption at
The graph shows that this years raw water consumption for the month of January remains the second lowest (just a touch higher than the lowest) as compared to the same period in the previous four years.
New Mains
The new 150 mm diameter PVC water main
along
c. Jerrys Plains Water Supply
|
01/01/08 – 31/01/08 |
2007 Figures |
Consumption |
1.49 ML |
2.72 ML |
The trend in water consumption at Jerrys Plains is shown on the following graph.
As compared to the same period in the previous four years, the graph shows that this years water consumption (up to and including the month of January), is the second lowest with the 2006/07 consumption being the highest.
d. Sewerage System Report
|
01/01/08 – 31/01/08 |
2007 Figures |
Sewerage Treatment Works - Flow Volume |
101 ML |
91 ML |
Effluent Reuse
Total estimated effluent reuse for this financial year is 244 Megalitres, after being adjusted for full water losses.
Sewer Main M & R
12 sewer chokes or problems were attended to this month:
· 10 Brittliffe Close (cleared main)
·
·
· 26 Cunningham Parade (cleared main)
· 4 Elliot Close (cleared main)
·
·
·
·
· 18 The Grove (sewer dig-up repair)
·
· Albion Hotel (sewer dig-up repair, relocate
sewer vent pipe)
New Sewer Junctions
No new
sewer junction was cut in this month.
Manhole M & R
Two
manholes were repaired or attended to this month:
·
· Eggleton Close (locate manhole)
Sewerage Pump Station M & R
Five
Sewerage Pump Stations were attended to this month:
· Bourke Street Sewerage Pump Station (cleaned
rag basket)
· Kelso Street Sewerage Pump Station (cleaned
rag basket)
· Army Sewerage Pump Station (cleaned rag
basket)
· Boonal Street Sewerage Pump Station (cleaned
level probe)
· Crown Street Sewerage Pump Station (replaced
lifting chain with stainless steel chain)
Sewerage Treatment Plant M & R
No
additional work was carried out at the Sewerage Treatment Plant this month.
Low Pressure Sewerage System (a majority at
Maison Dieu Industrial Estate)
Sewer POD
Connection
No sewer
POD was connected to the system this month.
Thus, the
total number of sewer PODs connected to the Low Pressure Sewerage system
remains at 85 and the total for this financial year is still four.
e. Training/Safety/Conferences/Exhibitions
No
training course was attended by any Water & Waste staff this month.
|
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|

Manager
Water and Waste Report No. 3/08 |
|
|
4. |
Non-Residential
Sewer and Liquid Trade Waste Pricing Author: Brian Carter |
FILE: 01/0220-2 |
Executive
Summary: This report provides an update of Council’s compliance with the State Government requirements for NSW Local Water Utilities (LWUs) to fully adopt proscribed sewer and liquid trade waste pricing guidelines for all reticulated sewer customers. A complying pricing scheme has been in place for Singleton residential sewer customers for some years, and this report proposes a compliant scheme to be put in place for non-residential sewer customers from the start of the 2008/09 Financial Year. The approved scheme will be applied to all sewer customers classified as BS (business) and NR (non-rateable) in Council’s rating system. The scheme will have a major financial affect on many sewer customers and provides for case by case concessions as a Community Service Obligation (CSO). A process of consultation is currently underway with all affected customers in preparation for the introduction of the scheme from 1 July 2008 through the Management Plan process. The consultation process is expected to be complete by April 2008 for further Management Plan reporting to Council, should it be required. |
Background:
Introduction
Singleton Council is an independent Local
Water Utility (LWU). Although not a
mandatory NSW Government requirement, Singleton Council has undertaken to
progressively adopt the Water Supply,
Sewerage and Trade Waste Pricing Guidelines issued by the NSW Department of
Land and Water Conservation in December 2002.
The pricing guidelines and LWU performance was overseen by the NSW
Department of Energy Utilities and Sustainability (DEUS) which issued a policy
document entitled Best-Practice
Management of Water Supply and Sewerage Guidelines in May 2004, requiring
that LWUs adopt the December 2002 pricing guidelines.
Currently, the NSW Department of Water and
Energy (DWE) oversees the Best-Practice
Management of Water Supply and Sewerage Guidelines. DWE has recently issued Terms of
Reference and a Discussion Paper for its “Inquiry into secure and sustainable
urban water supply and sewerage services for non metropolitan NSW” (January
2008). The Inquiry will be examining the
cost efficiencies of LWUs and their ability to meet required service standards
within compliant pricing schemes. The
Discussion Paper is critical of LWU compliance with the guidelines,
particularly in terms of sewer pricing.
Non compliance with the guidelines provides the NSW Government with more
reason to suggest alternative servicing and management models.

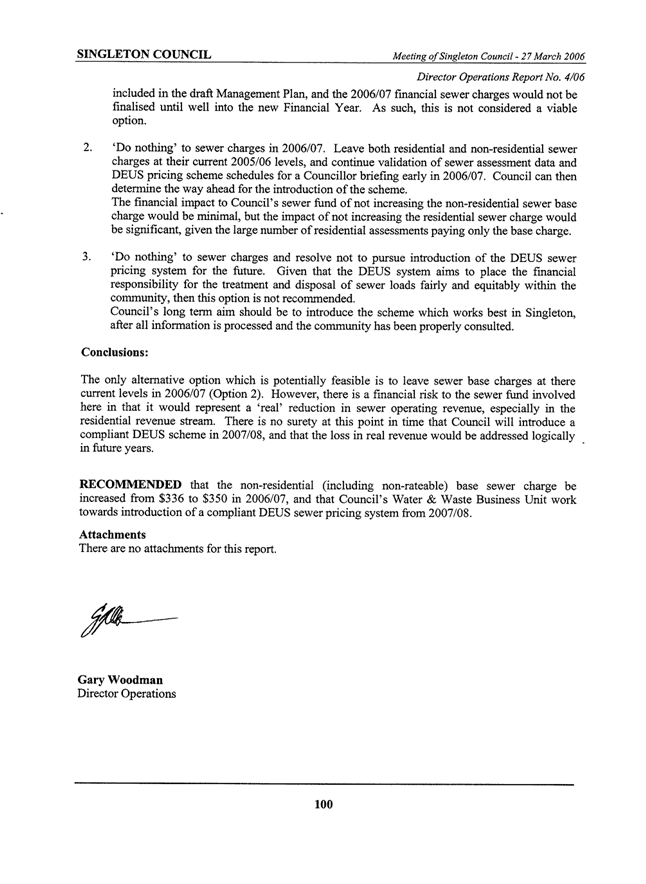

At its 27 March 2006 Ordinary Meeting,
Singleton Council received a report on Non-Residential Sewer Pricing (Director
Operations Report 04/06) and resolved to work towards introduction of a
compliant sewer pricing scheme in the 2007/08 financial year (Resolution
107/06). A copy of the report is
provided at Attachment 1. The
scheme was further developed and financial implications assessed, but the
current Management Plan noted that Council would delay its introduction until
2008/09. There have been no changes
proposed to the underlying methodology of the pricing scheme to that proposed
in the March 2006 report, apart from its extension to encompass liquid trade
waste charges. This report provides an
overview of the proposed liquid trade waste charging mechanism.
Currently the base levy per non-residential
sewer assessment is $362.00 which is equivalent to the current uniform residential
sewer charge. An increase of 3% (CPI) in
the residential sewer charge will be sought through the Management Planning
process, to $373.00 per assessment in 2008/09.
Assessments, including Churches and Government agencies, with more than
two toilets are charged for the additional toilets as follows:
- WC $161.75 per unit
- Urinals $88.40 per unit

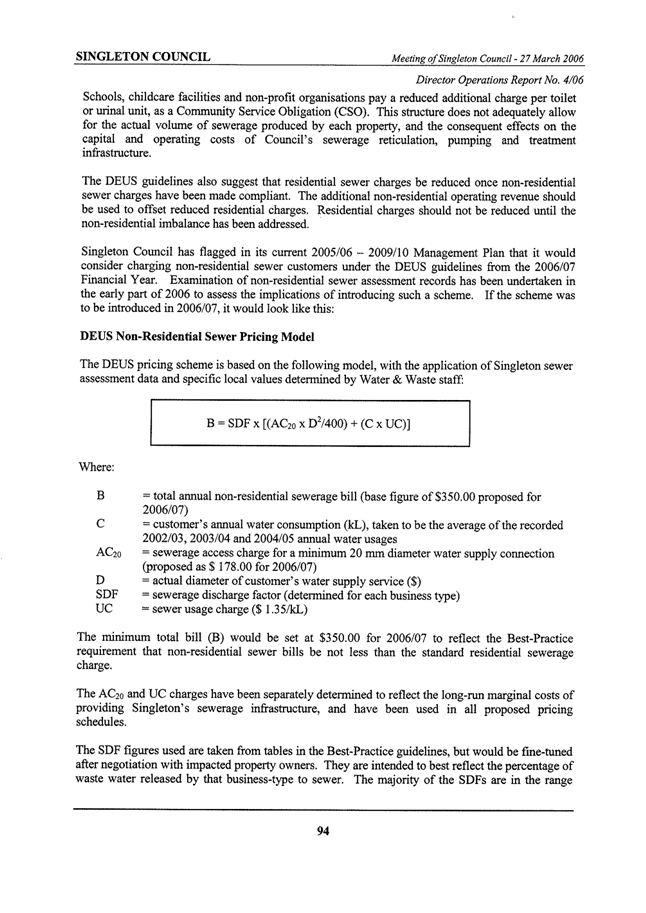

Council provides relief to schools and child
care facilities, as well as for non profit organisations. Their charges are as follows:
- WC $44.80 per unit
- Urinals $32.35 per unit
This method of fixing non-residential sewer
prices is not permitted in a “guidelines compliant” pricing scheme. The current method of charging for licensed
liquid trade waste discharges to sewer is by a fixed annual charge of
$255.80. This will change to a two part
charge (access charge plus usage charge), similar to the guideline requirements
for sewer charges.
A recap of the best-practice sewer pricing
scheme is as follows, updated from that proposed in March 2006:
B = SDF x [(AC20 x D2/400) + (C x UC)]
Where:
B = total annual non-residential sewerage bill (base figure of $373.00 proposed for 2008/09)
C = customers annual water consumption (kL) (2008/09)
AC20 = sewerage access charge for a minimum 20 mm diameter water supply connection (proposed as $184.00 for 2008/09)
D = actual diameter of customer’s water supply service (mm)
SDF = sewerage discharge factor (determined for each business type)
UC = sewer usage charge (best-practice guideline figure is $1.35/kL for 2008/09)
The minimum total bill (B) would be set at $373.00 for 2008/09 ($362.00 plus CPI) to reflect the Best-Practice requirement that non-residential sewer bills be not less than the standard residential sewerage charge. Those assessments where the annual sewer charges calculate less than the base figure of $373.00 would pay this minimum charge.
There is provision in the best-practice guidelines for Council to provide a community service obligation (CSO) to non-rateable properties. The guidelines recommend that such CSOs be applied as a reduction to the sewer access charge, but not to usage charges. The current financial model which forecasts these charges and Council income for 2008/09 does not include a CSO, but the current discussions with eligible property owners will permit CSOs to be negotiated and reported to Council through the coming Management Planning process.
Liquid Trade Waste Charges
As detailed in Attachment 1, March 2006 report, the DEUS model requires that all non-residential sewer charges include an access charge and a usage charge. The access charge is a function of the diameter of each assessment’s water service, and the usage charge is based on both the actual metered water usage and the nature of the property use.
There are currently 422 non-residential sewer assessments in the BS and NR rating categories. Over 100 of these also hold licenses with Council to dispose of liquid trade waste to sewer. Most of these licenses require pre-treatment in approved equipment prior to discharging the waste to sewer. These assessments will be liable to pay additional trade waste access and usage charges in accordance with the guidelines, as the trade waste discharges impose added reticulation, pumping and treatment requirements on Council’s sewer infrastructure.
The best-practice trade waste pricing scheme is similar to the sewer pricing model, except that the annual charge is fixed rather than being related to the size of the water meter:
TW = A + I + (C x UCTW x TWDF)
Where:
TW = total annual trade waste fees and charges ($)
A = annual trade waste fee (proposed as $76.00 for 2008/09, based on the $60.00 guideline figure plus 6 years of CPI increases)
I = re-inspection fee (not mandatory, but such a fee is already set in the current Management Plan at $84.95 – this would be subject to a CPI increase for 2008/09)
C = customers annual water consumption (kL)
TWDF = trade waste discharge factor (determined for each business type – if applicable)
UCTW = trade waste usage charge (best-practice guideline figure is in the order of $1.43/kL)
The minimum trade waste bill (TW) would effectively be $76.00 for 2008/09, for those assessments with licensed pre-treatment facilities which are not subject to a TWDF. For such assessments there will be a large reduction in trade waste charges from the current standard $255.80 to $76.00 in 2008/09. For those subject to TWDFs, with high water usages, there will be a significant increase. Council should note, in particular, that four of the 50 non-rateable assessments will be subject to a large increase in trade waste charges due to their large approved discharges of trade waste to sewer. CSOs will need to be considered for these assessments in particular.
All non-residential sewer assessments with a licensed trade waste discharge will be subject to both the sewer charge (B) and the trade waste charge (TW).
Financial
Implications of Introducing the DEUS Model with Full Compliance
Council’s databases of water metering, property usage and trade waste licence agreements have been updated in recent months, and the relevant sewer and trade waste discharge factors have been attributed. A financial model has been produced detailing the financial implications of the proposed pricing for each assessment.
In summary, the introduction of the full model in 2008/09 would realise an additional $230,423 in sewer operating revenue, representing an overall increase of 69% in revenue from non-residential sewer and trade waste charges. The distribution of current and additional revenue would be as follows:
Non-Residential Sewer
and Trade Waste Charges |
Non-Rateable (NR) |
Business (BS) |
Total (NR + BS) |
No. of Sewer Assessments |
50 |
372 |
422 |
Existing 2007/08 (with $362 sewer base) |
54,086 |
279,920 |
334,006 |
Best-Practice 2008/09 (with $373 sewer base, UCS = $1.35/kL, UCTW = $1.43/kL ) |
96,522 |
467,365 |
563,887 |
Gross Increase |
42,436 |
187,445 |
229,881 |
% Increase |
106% |
62% |
69% |
Table 1 – Distribution of Sewer income from Best-Practice Pricing Structure
A substantial number of sewer assessment charges would increase dramatically as a result of this pricing scheme. Although many of the assessments would continue to pay the base sewer charge due to their low water usage, Table 2 illustrates that 60% of all non-residential sewer assessments would have their sewer and trade waste charges increased by more than 10%.
Table 2 – Broad Financial Impact of
Recommended Guidelines
Rating Category |
Total No. of Properties |
Number of Properties to pay up to +10% extra |
Number of Properties to pay over 10% extra |
% of Properties to pay over 10% extra |
1. Business |
372 |
162 |
210 |
56% |
2. Non-rateable |
50 |
7 |
43 |
86% |
Total |
422 |
169 |
253 |
60% |
Likely Impacts on Selected Business Types
The Best-Practice pricing structure aims to fairly spread the financial load where the potential and actual sewer loads are indicated. It does not seek to penalise individual business groups, or properties which may have greater capacity to pay.
At the extremes, there are around 60 assessments that will benefit financially by up to 70% from the new pricing structure (whilst preserving the $373.00 residential sewer base charge), and 24 assessments which will have their charges increased by over 300% (including seven of the non-rateable assessments).
The greatest general impacts appear to be in the following business groupings:
· Hotels and Clubs
· Restaurants, Fast Food establishments and Cafes
· Vehicle Maintenance, Engineering, Agricultural Equipment and Car yards.
The reasons for their high exposure to increased charges are largely due to high water usage, pre-treatment of trade waste from food preparation, and high applicable sewer and trade waste discharge factors. If any business types are likely to collectively seek to reduce their exposure to the new pricing structure, it is likely to be these business groups.
Should Council wish to reduce the exposure of any particular business group or non-rateable grouping, it would need to determine which part of the pricing model was to be altered. For the model to be compliant, it would need to be altered for all assessments.
As mentioned earlier, the best-practice recommendation is to reduce the annual fixed access component of the charges rather than the usage component. However, the model is not highly sensitive to access charges. A nominal reduction in the access charges does not significantly alter the impact of the pricing model on any group of assessments. On the other hand, the model is highly sensitive to usage charges. The overall financial impact on the great majority of assessments could be greatly reduced by reducing the sewer usage charge (UCS) and trade waste usage charge (UCTW) across the board, subject of course to future Management Plan review if it is found necessary.
Financial Impacts of Reducing Usage Charges below Best-Practice Guidelines
A number of iterations have been performed to determine a more reasonable manner of introducing the DEUS model without significant financial impact on non-residential assessments, but ensuring a steady growth in overall sewer and trade waste income to Council. The $1.35/kL sewer usage charge would bring about an overall increase in sewer charges alone of 51% per annum, and the $1.43/kl trade waste charge would bring about an overall increase in trade waste charges of 304%. Lowering the sewer usage charge from $1.35/kL to $0.85/kL and the trade waste usage charge substantially from $1.43/kL to $0.40/kL across both BS and NR rating categories would achieve the following financial result to Council in 2008/09:
Non-Residential
Sewer & Trade Waste Charges |
Non-Rateable (NR) |
Business
(BS) |
Total (NR
+ BS) |
No. of Sewer
Assessments |
50 |
372 |
422 |
Existing 2007/08
(with $362 sewer
base) |
$ 54,086 |
$ 279,920 |
$ 334,006 |
2008/09 charge
(and % increase) with $373 sewer
base, UCS=$0.85/kL,
UCTW=$0.40 |
Sewer 63,523 (23%) TW 7,668 (200%) Total 71,191 (32%) |
Sewer
290,295 (12%) TW
25,544 (18%) Total
315,839 (13%) |
Sewer 353,818 (14%) TW 33,212 (37%) Total 387,030(16%) |
Gross
Increase over
2007/08 |
$ 17,105 |
$ 35,919 |
$ 53,024 |
% Total Charges
Increase over
2007/08
|
32% |
13% |
16% |
Table 3 – Distribution of Sewer Income from modified Best-Practice Pricing Structure
Council should note from Table 3 that the reduction in usage charges would reduce overall non-residential sewer and trade waste income in 2008/09 from 69% to 16%. Additional sewer income would be 14% and additional trade waste income (despite the extremely large reduction from $1.43/kL to $0.40/kL) would be 37% prior to any CSOs or negotiated concessions.
At this point it should be noted that a sewer usage charge of $1.00/kL would result in a 25% overall increase in non-residential sewer charges in 2008/09 and a 26% increase in sewer and trade waste charges combined. The effect of introducing this sewer usage charge immediately within a compliant pricing scheme is still excessive, but should be considered for phasing in 2009/10. The lower sewer usage charge of $0.85/kL has been used for the proposed 2008/09 introduction.
Even with a large reduction in usage
charges, the non-rateable assessments as a group would be more affected in
terms of both sewer and trade waste price increases than the business
assessments. Most of the increase in
charges within the non-rateable category would be taken by
In comparison with Table 2, the broad financial impact of reducing the usage charges is illustrated by Table 4. Whilst the increases still have a greater affect on non-rateable assessments than business, the proportion of assessments in both categories which would experience price rises in 2008/09 of greater than 10% would be greatly decreased (from 60% to 27% overall). The magnitude of the individual increases over 10% would also be significantly reduced across the board.
Table 4 – Broad Financial Impact by lowering Usage Charges to UCS=$0.85/kL, UCTW=$0.40.kL
Rating Category |
Total No. of Properties |
Number of Properties to pay up to +10% extra |
Number of Properties to pay over 10% extra |
% of Properties to pay over 10% extra |
1. Business |
372 |
290 |
82 |
22% |
2. Non-rateable |
50 |
16 |
34 |
68% |
Total |
422 |
316 |
116 |
27% |
In summary, introduction of the best-practice pricing system in 2008/09 with lower than recommended usage charges ($0.85/kL for sewer and $0.40/kL for trade waste) would reduce the additional sewer income to Council from $229,881 to $53,024 but would substantially reduce the financial impact on non-residential sewer assessments. Council could then consider further phasing in of the best-practice recommended prices in future management plans.
Current Consultations
A letter is currently being circulated to property owners in the BS and NR rating categories which are likely to be the worst affected, advising them generally of the proposed sewer and trade waste pricing scheme for introduction from 1 July 2008. Specific usage charges and discharge factors have not been provided at this point. Individual on site discussions are scheduled to commence in late February and could continue through to April. Discussions with property owners and business operators regarding their business operations and likely new charges for 2008/09 may result in some negotiated changes to discharge factors, however most are likely to remain unaffected.
Feedback from these consultations will be reported to Council prior to its determination of the Draft Management Plan for 2008/09 to 2012/13.
The Way Ahead
Council’s approval will be sought for the introduction of a complying best-practice sewer and trade waste pricing scheme in 2008/09, with a base charge for all non-residential sewer assessments of $373.00, in line with the proposed CPI increase in the base charge for residential sewer assessments. Council’s approval will also be sought to finalise any CSOs and concessions which it believes may be appropriate, once consultations with the affected owners and business operators have been completed and reported to Council in April or May 2008.
Management Plan:
Council’s Management Plan undertakes to introduce full non-residential compliance in 2008/09 and suggested that application of a compliant model would likely provide an additional $167,000 in sewer revenue.
Application of the full model utilising the recommended sewer and trade waste usage charges and a $373.00 base non-residential sewer charge discussed in this and the March 2006 report would provide additional gross sewer operating revenue in the vicinity of $230,000 (69%) per year. Introduction of reduced usage charges in 2008/09 ($0.85/kL for sewer and $0.40/kL for trade waste) would reduce the additional income to around $53,000 (16% additional) before CSOs. An increased sewer usage charge of $1.00/kL should be considered for 2009/10, which would increase the additional income to around $86,000 (26%) on current levels.
Council Policy:
Council’s current pricing policy for non-residential sewer charges does not take actual or potential sewer loads from businesses and other Government and non-profit organisations into account. As a result there is a substantial under assessment of sewer charges, particularly in the business sector.
Council’s current sewer pricing policy acknowledges Community Service Obligations (CSOs) for many rateable and non-rateable assessments. CSOs could be similarly applied to a new user-pays sewer pricing scheme preferably in the form of reduced Sewer Access Charges (ACs) as recommended in the DEUS Guidelines.
Legislation:
The NSW Government is required to demonstrate compliance with National Competition Policy (NCP). LWUs have been encouraged since 1995 to introduce best-practice management for water supply and sewerage businesses. Conformance to the State Government’s policy and guidelines documents is not strictly mandatory for LWUs. However, failure to conform to the requirements would attract possible financial penalties to Council in future Government grants.
The current DWE ‘Inquiry into secure and sustainable urban water supply and sewerage services for non-metropolitan NSW’ will be examining the compliance of LWUs to best-practice sewer and trade waste guidelines, and their abilities to provide high standards of infrastructure and service in a cost efficient manner. The user pays pricing scheme model proposed for introduction by Council in 2008/09 complies with the best-practice guidelines in form and structure.
Sustainability:
Social:
The
broad community impact of the pricing scheme in 2008/09 is difficult to
foresee. Even with reduced usage charges
27% of the 422 affected non-residential (including non-rateable) sewer
assessments would be subject to an increase of more than 10% in sewer and trade
waste charges, and 12% of assessments will be subject to increases of over
100%. The worst affected sectors are
hotels, clubs, restaurants, fast food establishments, cafes, motor vehicle
trades and retail, engineering businesses,
Without the introduction of such a scheme which introduces a user pays component, there would need to be future rises in the base residential sewer charge to offset the lost sewer revenue. This would arguably produce a larger social impact than the introduction of the proposed non-residential pricing scheme. The short term impact is cushioned by the large reduction in usage charges proposed for introduction in 2008/09 and the negotiation of CSOs for case by case hardship reductions, but these usage charges would need to be increased in future years to comply more fully with the best-practice guidelines and to ensure that residential sewer income does not continue to subsidise non-residential income.
Environmental:
The State Government’s best-practice policy and sewer pricing guidelines argue that the pricing model will lead to gradual reductions in water consumption and consequently lower sewer loads. Overall treated effluent volume discharged to the Doughboy Hollow should therefore also be gradually reduced with any reduction in sewer loads.
Financial:
The financial impacts on both the 422 non-residential assessments and Council’s sewer fund have been illustrated throughout this report. The increase in sewer revenue of around $53,000 in 2008/09 is based on the financial model which takes into account heavily reduced sewer and trade waste usage charges.
Council should note that the capital and operating costs of its sewer infrastructure are increasing faster than CPI. The steady expansion of the sewer network commensurate with Singleton’s urban growth, while largely financed by developer capital contributions, places a larger responsibility on Council to control and care for the infrastructure for the benefit of all residents and business operators. A fair and equitable distribution of the costs is brought about by the introduction of this pricing scheme.
Some further increase in usage charges would be warranted, to ensure the sewer funds continuing viability.
Consultation:
There has not yet been any consultation with the broader community regarding introduction of the State Governments Best-Practice pricing scheme. Councillors have been introduced to the best-practice policy and guidelines over the past two years. Consultation with the affected 422 non-residential property owners and business operators has commenced and should be completed by April, 2008. At this point no consultation has been programmed with business and community organisation forums, although such organisations may seek such an approach in the coming months. It is also envisaged that Council’s website and newsletters will run a broad synopsis of the scheme for general community education during May and June 2008.
Risk Management:
Not applicable.
Options:
Option 1 ‘Do nothing’ – freeze sewer charges and resolve not to pursue introduction of the DEUS sewer pricing system for the future. Given that the DEUS system aims to place the financial responsibility for the treatment and disposal of sewer loads fairly and equitably within the community, then this option is not recommended. Council’s long term aim should be to introduce the user pays scheme which works best in Singleton, after all information is processed and the community has been properly consulted.
Option 2 Postponement - This option is not recommended, as Council needs to be in a position to comply with best-practice guidelines, and has already commenced consultations with customers.
Option 3 Full Compliance, with concessions - introduce the DEUS system in 2008/09 through the Management Plan and public exhibition process, with Council approved CSOs. The non-residential base sewer charge would be set at the residential base charge level ($373.00 for 2008/09). Sewer access and annual trade waste charges would be targeted for possible CSOs for selected non-rateable assessments. Usage charges for sewer and trade waste would be set at $1.35/kL and $1.43/kL in full compliance with the guidelines. A charging system with full, immediate effect is not considered a realistic or an acceptable option to pursue from a practical point of view.
Option 4 Phased Introduction - The DEUS guidelines note that where large increases in assessment charges result from the introduction of a complying pricing scheme, that a phase in period of two or three years is appropriate for those assessments. In effect, Council can comply with State Government requirements by implementing the best-practice compliant guidelines, whilst levying lower usage charges as has been described in the body of this report.
Conclusions:
Full compliance with the NSW Government’s best-practice sewer and trade waste pricing requirements in 2008/09 is highly advisable. However, there would be significant short and long term hardship within both the business sector and non-rateable community by this hardline approach. The proposed alternative option is to introduce a compliant scheme with reduced sewer and trade waste usage charges, including CSOs where warranted. In this way the social and broader economic effect on the Singleton community can be reduced in a responsible manner.
1. A non-residential sewer and trade waste pricing scheme be introduced in 2008/09 to comply with the NSW Government’s best-practice guidelines, including the following features: a. A sewer usage charge of $0.85/kL and trade waste usage charge of $0.40/kL for 2008/09, subject to annual review by Council; b. A sewer access charge (AC20) of $184.00; c. A non-residential sewer base charge of $373.00 (equivalent to the proposed residential sewer base charge for 2008/09); d. A $76.00 uniform annual trade waste charge for licenced trade waste discharges; e. CSOs for selected non-rateable sewer assessments. 2. A further report be
prepared for Council in April, 2008 summarising the consultations with
non-residential sewer customers and the proposed method of calculating the
CSOs for eligible customers. |
AT-1View |
Director Operations Report 04/06 |
8 Pages |
Manager Water and Waste Report
No. 3/08 |
|
Director Operations Report
04/06 |
Non-Residential Sewer and
Liquid Trade Waste Pricing |
|
|
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Water and Waste Report No. 3/08 |
|
|
5. |
Water Five
Year Capital Works Program Author: Brian Carter |
FILE: 01/0328 |
Executive
Summary: The capital works program attached to this report identifies water projects requiring construction over the next five years. It has been possible, since my March 2007 report on these matters, to more accurately identify the timing of works required to service the new development areas of Singleton. Several projects have had their estimated costs increased, in line with costs expected with the current tight market conditions for large civil contract works. There has been no allowance made for interconnection works between Singleton and Hunter Water Corporation. This item will need to be considered separately by Council when all relevant information is to hand. |
Background:
Brief explanatory notes, previous history and
other relevant information for specific projects identified in the detailed
schedule at Attachment 1 appear below.
New Works – Growth Related
This section of the schedule deals with work
that has been identified in Councils Water Developer Charges Plan as necessary
infrastructure, the costs of which are to be recovered from Developer
Charges. While the costs of this work
has been accurately identified, it is still possible that nominated years of
construction may need to be adjusted, dependant upon the speed and location of
new development works. Should works need
to be brought forward for construction, there will need to be consideration of
the requirement for “forward funding” by Developers. The method and general need for this has been
reported in the past.
Retreat Rural
Residential Subdivision
There have been four lots either approved for
rezoning, or about to be considered for rezoning by Council, generally in the
area nearby to the
This will increase by approximately 173 lots
in total, the size of the Retreat, and will trigger the construction of a new
200 mm diameter amplification main, to be built in
Bridgman Ridge/Hunter Green Residential
Subdivision
This
subdivision requires the construction of a 375 mm diameter main, to feed
ultimate subdivision demands through a new Reservoir.
It is now considered likely that this main
can be built in two stages. The first
will connect major mains in
This development area will also require the
progressive construction of a 250 mm diameter main, running some distance east
from Wattle Ponds Road. Commencement of
this work is still expected in 2011/12.
Similarly the construction of two major
valves, which will operate automatically, remains set for 2009/10 (Pressure
Control) and 2011/12 (Reservoir control valve).
Pinnacle Estate
Provision for the progressive construction of
a 200 mm diameter main remains unchanged.
The 250 mm main nominated in March 2007 for progressive construction has
been largely completed to allow the current development stage in the Pinnacle
to go ahead.
A small additional section of 250 mm main may
be required in future to extend to
Maison Dieu Industrial Estate
Provision
has been made for connection to an existing pressure boosting system located
next to McDougalls Hill Reservoir.
Gowrie Links
Provision for progressive construction of
required water mains continues, although work is not expected to be required
until 2009/10.
A booster pump station, water mains and an
elevated water reservoir have been allowed for, but this would require planning
provision before a commitment to construct the infrastructure should be made by
Council.
New Works – Improving Service Levels
This section of the schedule deals with new
works and major improvements to existing facilities, for such things as to
increase capacity or to provide a higher level of water treatment.
Obanvale Balance
Tank and Glennies Creek Dam Pump Station
Councillors would be aware that the pump
station was built this year, as a response to declining dam levels. As was reported in March last year, construction
of the balance tank and final capacity upgrading of the pump station (for
population increases), was to be deferred.
At present, these two projects, costing
$406,000 and $200,000 respectively, have been given a nominal construction date
of 2012/13, but this will require further refinement closer to that date, when
population increases can be more accurately established.
Other items in this section of the schedule
relate to new main construction or other improvements which have been
identified in previous capital works plans.
The dates for construction and estimated costs have not been altered.
Asset Renewals Programs
There are a number of continuing programs
which allow for orderly replacement of aged or worn infrastructure. Prioritisation for these programs is based on
either the age of the asset or its breakdown and repair history. Often both factors are taken into account in
prioritising works.
Over the last several years, there has been a
requirement to undertake construction of infrastructure for a number of
developments, and also major augmentations such as the Broke Water Supply and
Pressure Sewer for Maison Dieu Area.
It has become apparent that basic asset
maintenance work, such as meter replacements, progressive service replacement
for galvanised pipes, stop valve and hydrant repairs and replacements, has not
received the attention it requires.
In an effort to catch up on these, I have
deferred a number of water main replacement items which I believe can wait 12
months longer. Hence, the only specific
water main renewal I have kept in the schedule for 2008/09 is for the
replacement of an undersized Asbestos Cement water main, 250 mm in diameter and
150 metres in length. This main was
built in 1973, and it remains in reasonable condition. However, it lies next to the
As the
ultimate sized water main required here is likely to be 375 mm in diameter, it
would be an excellent time to replace this main with one of that diameter. The cost of the work is estimated to be
$55,000.
It is
possible, like other years, that up to several small sections of mains already
on our long term replacement list may suddenly increase their failure
rate. Should this occur, I have left an
unallocated amount of $25,000 in 2008/09 in order to allow for their
replacement.
All other
asset renewal programs in the schedule have been reported to Council in
previous budget years, and are continuing with no significant change. I can provide additional information on these
programs should it be required.
New Building and Plant Purchases
Mini Excavator – 2.5
Tonne Capacity
Water and Waste have traditionally hired most
of the plant and equipment it requires.
The range of equipment we hire is varied and extensive, however, there
has been one common item which has been hired on an increasingly regular
basis. We have been dry-hiring mini
excavators for several years. Whilst
they are an essential part of our work, they are often only required for a
small part of the day, hence they are operated by several of our utilities
operators, who are multi skilled.
In
2007/08, dry-hire of mini excavators is expected to cost Council $62,000, and
this is expected to continue into the future.
Investigation indicates that we could purchase a 2.5 tonne excavator and
trailer for $65,000 or less. Further,
running costs and depreciation are expected to be in the vicinity of $20,000 to
$25,000 per annum.
Provision
has therefore been made for the purchase of such a unit in 2008/09.
Water Depot – Pipes and Fittings Shed
Water and
Waste has a pipe and fittings shed at its water depot of unknown age. It is constructed of hardwood and corrugated
iron. White ant infestations have
occurred several times in the last five years, and control measures have not
been effective. Once of the roof trusses
has weakened dangerously and is permanently supported by a prop. It is time this shed was replaced, and
provision of $55,000 has been made to do so in 2008/09.
Management Plan:
This capital works plan has been prepared using forward financial projections from Councils Water Financial Model, Developer Servicing Plans and various technical reports. It is consistent with Councils current Management Plan. Several additional items, namely Retreat Water Main, purchase of mini excavator and replacement of Water Fittings Shed have been identified. Their cost can be funded by a combination of savings, reallocation for asset renewals and Water Developer Charges.
Council Policy:
This report does not require the formulation of any new policy, and does not impact on existing Council Policy.
Legislation:
Not applicable.
Sustainability:
Social:
Due
to the wide range of projects proposed in the capital works plan, there will be
many positive outcomes for the community.
These include provision of new water supply areas and provision of a
higher level of service to many. Some
minor impacts during construction will be experienced by a small number of
residents. The minor inconveniences to
some are considered appropriate in order to provide the many benefits to the
community.
Environmental:
Some
of the project nominated in the capital works plan will have an impact on the
environment, and will require a satisfactory Review of Environmental Factors,
or Environmental Impact Statement, before they can proceed.
Financial:
Councils Water Fund
holds cash reserves adequate to meet the funding requirements of this capital
works plan. Fees and charges have been
set to ensure long term sustainability of the water fund.
Consultation:
It is envisaged that initial consultation with the community will be by way of Management Plan public exhibition. Many of the projects will require further written advice/or advertisement in the media.
Risk Management:
Many of the projects nominated in this report are in the early stages of formulation. Risk Management measures will be refined and developed in the main, closer to their actual construction dates.
Options:
Options for major projects have already been canvassed with Council and the community.
Conclusions:
The five year forward capital works plan presented in this report identifies $7 million of projects. Many of the projects are required to cater for new development, also adequate provision for asset renewals has been made. Councils Water Reserves stand at over $16 million, and no loans will be required for any of the work identified in the schedule.
RECOMMENDED that the five year Water Capital Works Plan presented in this report be adopted. Brian Carter Manager
Water & Waste Director
Operations |
AT-1View |
Water Five Year Forward Capital Works Program |
2 Pages |
Manager Water and Waste Report
No. 3/08 |
|
Water Five Year Forward Capital
Works Program |
Water Five Year Capital Works
Program |
|
|
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Design and Contracts No. 2/08 |
|
|
1. |
Author: Sue Brinkworth |
FILE: 04/0054 |
Executive
Summary: An

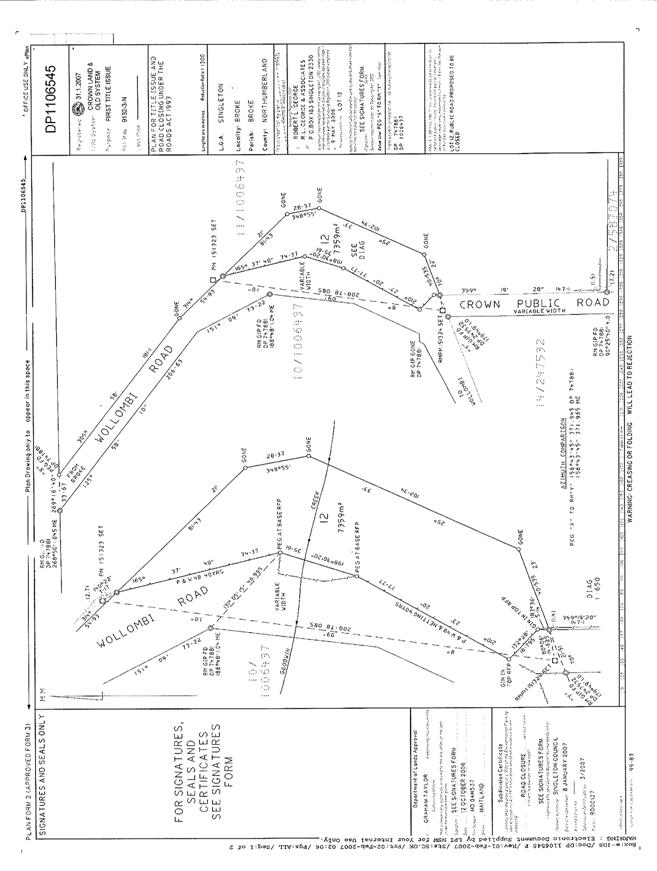

application was received from Ms P Goss and Mr B Armstrong for the closure of
part of In
accordance with the Local Government Act 1993, the land (lot 12 DP 1106545)
may now be sold to the applicant (adjoining owner). The applicant has offered to purchase the
closed road for the sum of $2,614.80, bear the cost of application fees
associated with the road closure, survey and plan registration costs as well
as council’s legal fees. It is
estimated that the cost to the applicant exceeds $9,000.00. Council obtained a valuation report valuing
the land at $7,359.00. |
Management Plan:
Not Applicable
Council Policy:
Not Applicable
Legislation:
Local Government Act 1993 allows the sale of land classified as “operational”.
Sustainability:
Social:
The sale impacts positively on the
community as the proceeds from the sale of the closed public road are set aside
for Council’s road network.
Environmental:
There is no impact on the environment
as a result of the sale of the closed public road.
Financial:
There is a positive impact on the
Council and the Community as a result of the closure and sale of unutilized
public road. In accordance with s43 of
the Roads Act 1993, the proceeds of
the sale of closed public road may only be used for acquiring land for public
roads or for carrying out road work on public roads.
Consultation:
The proposal to close the public road and
sell the closed road to the applicant was advertised in the Singleton Argus and
adjoining owners notified. No objections
were received. Council subsequently
resolved to proceed with the application.
Risk Management:
Council significantly minimizes its risk with
the closure and sale of unutilized public roads. Maintenance of the land is no longer required
and the revenue from the sale may be used to maintain existing public roads.
Options:
Council may consider the offer from Armstrong Goss to acquire the closed road Lot 12 DP 1106545 for the sum of $2,614.80 including bearing the application costs, survey and plan registration costs and Council’s legal costs and resolve to either accept or reject the offer.
Conclusions:
The
valuation of the land proposed to be closed is $7,359.00. The cost to the applicant for the closure and
purchase of the closed road exceeds $9,000.00, therefore the offer by Armstrong
Goss to acquire the closed road Lot 12 DP 1106545 is considered reasonable.
RECOMMENDED that Council accept the offer from
Armstrong Goss for the purchase of Lot 12 DP 1106545 for the sum of $2,614.80
including bearing the application costs, survey and plan registration costs
and Council’s legal costs. |
AT-1View |
Copy of
Plan and DP 110 6545 |
|
Manager Design and Contracts
No. 2/08 |
|
Copy of Plan and DP 110 6545 |
|
|
|
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Design and Contracts No. 2/08 |
|
|
2. |
Design &
Contracts Program Area - Jobs in Progress Author: Christopher Martin |
FILE: 08/0073 |
Executive
Summary: The following works have been completed, are in progress or are programmed to be commenced by the Design and Contracts Program Area. |
(a) CURRENT
SURVEY, INVESTIGATION & DESIGN MATTERS
PROJECT |
DESCRIPTION OF THE
PROJECT |
STATUS |
LAND DEVELOPMENT |
|
|
Retreat
Stage 10 |
Subdivision plans for DA160/2004. CC plans preparation to comply with DA conditions. Indigenous heritage assessment – Flora & fauna assessment. DEC - S90 - (D C&DS) Plans submitted for CC Approval 9/8/07. CC Approval 29/8/07. Works Commenced. Deposited Linen Plan lodged Plan No. 1120621. Linen released. Final landscaping & Subdivision Engineer inspection required. |
Approved 100% 100% 100% 100% 100% 20% |
Pinnacle
Stage 6 |
DA plans submitted DA732/2005. Indigenous heritage assessment – S90 approval – report to go back to DEC (D C&DS). Statement of Environmental Effects – submitted to P&DS. Additional studies/designs required: - Traffic Study; - Noise Study; and - Engineering plans for CC including water, sewer and detention basin designs completed, reviewed by Planning & Development Services. Plans currently being amended by Consultant Designer for submission to Council for CC by Monday 25 June 2007. CC approval received 9/08/07. Works Commenced. |
100% 100% 100% 100% 100% 100% 100% Near completion. |
Mt Thorley Re-subdivision ( |
Detail survey. Indigenous heritage assessment – S90 approval. Salvage work on approval – (D C&DS). Flora & Fauna investigation. Draft S88B preparation for contract – to be amended to include DA consent conditions. DA plans submitted (DA137/2006). CC Approval 22/6/07. CC Plans issued for construction. Subdivision Development under construction. Linen submitted 21/02/08 |
100% 100% 100% 100% 100% 100% In Progress |
BRIDGES |
|
|
|
Vertical and Horizontal Alignments completed. Road approach design required. |
100% TBA |
|
Vertical & Horizontal design complete. Road approach design required. |
100% TBA |
|
Survey and horizontal alignment Completed. Road approach design required. |
100% TBA |
|
Survey and Preliminary Design Complete. Road approach design required. |
100% TBA |
Stringy
|
Survey Required. Preliminary Design required. |
100% Programed |
ROADS & TRAFFIC |
|
|
SES Car park, Singleton |
Survey Preliminary complete. Redesign requested and in progress. Completed |
100% 100% On Hold |
|
Survey for realignment of 90 degree bend to
improve road safety at Neal’s property. Client requires horizontal alignment review. |
80% |
|
Survey Complete Designs required: · Set-out Required · Set-out
complete · Boonal Street – Completed. Set-out
Required |
100% 100% TBA 100% 100% 100% TBA |
|
Survey and design required. Survey Completed. Design in Progress |
100% 10% |
Glendonbrook RFS, |
Survey, design and DA required to be
lodged. Survey Complete. Design |
100% In
Progress |
DRAINAGE |
|
|
|
Detail Survey – Extra Detail Required to address increased scope of works. Check of Previous design by Consultant. Redesign of Geotechnical investigation for Council land for filling. Negotiations with Landowners. Council undertaking preliminary design |
80% 60% 100% 50% Underway In Progress |
PARKS & FACILITIES |
|
|
|
Drainage batter regrading survey required |
To be Programmed |
(b) ROADS AND
CONTRACTS MATTERS
Job |
Description of Job |
Status |
Tender
Administration |
T2008.001
– Asset Valuation Services |
Tender
documents prepared |
|
T2008.002
– Construction of Bridge over Barney’s Creek (replacement of |
Tender
documents prepared |
|
T2008.003
– Supply & Delivery of 2 x 9t Tipper and 1 x 2t Double Cab Utility |
Tender
documents prepared |
|
T2008.004
– Construction of bridge - Stringy Bark Creek |
Tender
documents prepared |
|
T2008.005
–Trade & Miscellaneous Services |
Tender
documents currently being prepared |
Contract
Administration |
C2006.015
– |
Final
Completion due |
C2006.020
– Singleton CBD streetscape. |
Practical
completion due |
|
C2007.005
– Contract for the construction of Mt Thorley Industrial Subdivision. |
Practical
completion due |
|
C2007.008
– Retreat Stage 10. |
Contract
In progress |
|
C2007.009
– Pinnacle 6. |
Contract
In progress |
|
C2007.010
– Electrical Reticulation Mt Thorley. |
Contract
In progress |
|
C2007.018
– Electrical Reticulation Pinnacle Stage 6 |
Contract
In progress |
|
C2007.010
– Electrical Reticulation Mt Thorley. |
Contract
In progress |
|
Road Matters |
|
|
|
Road widening and bridge construction over Rixs
Creek – road opening/closing (Resolution 31/06). |
Re-notification have been sent |
|
Separate pieces of land from |
Surveyor will advise Council of status of plans |
|
Road opening and compulsory acquisition of crown
land. |
MATTER
CLOSED - No acquisition required |
|
Road closure (Treminar Winery). |
Report to Council has been sent (3/3/08) |
Stage 4 Streetscape |
Land acquisition at Railway Station. |
Railcorp has advised that the matter is being
investigated, awaiting advice |
Cranky |
Road widening (acquisition) and opening (Dick). |
Telstra Plant will be located and marked this
week. Fencing will commence next
week. A quote has been received from
the developer’s surveyor, but appears too expensive. Quotes will need to be called for survey
etc. once we have completed the fencing.
|
|
Road widening (Pankhurst) (Resolution 320/06). |
Plan has been Registered |
|
Causeway location, road opening and closing
(Resolution 243/07). Causeway through
Smiths and newly created road in Jones |
Waiting for plans |
|
Causeway location through Smith’s – road
opening/closing (Resolution 243/07). |
Waiting for plans |
|
Anomaly north of |
Waiting for plans |
|
Compulsory acquisition of Lot 1 DP 1092168 from S
& M Jones. |
Letter sent to Stephen Jones |
Wambo
Mining |
Wambo
Mining Application – road closure at Warkworth. |
Barabara
Ryl from Dept of Lands following up. |
White
Mining |
White
Mining Application – road closure of part of |
Awaiting
adjoining owner consent. |
Pikes
Gully road, |
Part
of |
Barabara
Ryl from Dept of Lands following up. |
PPK
- part of |
PPK
– part of |
Waiting
on finalisation of Plan of Subdivision |
Pikes
Gully / Mitchell Line Roads |
Pikes
Gully/Mitchell Line Roads – road closure due to mining activity (Coal &
Allied). |
Following
up with Jeff Rock (LPI) for registration and sale |
|
|
Road
closure and opening. Consent received
to advertise part road closure |
|
Road
deviation – road closure and opening. |
Letter
sent to Clayton Utz stating old deed is obsolete due to the Road Act and the
Dept of Lands is the approving authority, however Council would not object to
any application for road closure |
Singleton
RSC |
Laneways
between York and Castlereagh Streets – road closure and opening (Resolution
242/07). |
RSC
reviewing their plan - |
|
Boundary
redefinition (Resolution 173/07). |
Waiting
on subdivision of property next door where plan will then be done for road
opening and road closure |
|
Opening
and closing. |
ON
HOLD - pending negotiations with adjoining owner on his proposed
subdivision. Investigate legal issue
of need to compensate previous owner |
|
Opening
and closing. |
Surveyor
engaged to prepare land of road opening in conjunction with |
|
Road
opening over a crown road, road closure (Resolution 195/06). |
Ltr
Received from DLG - they require additional information before consent can be
given. Ltr Sent to DLG (waiting a
response) |
|
Road
widening, Lot 1 DP 410645 (McTaggart). |
Email
sent to Alan Scott - amend your plan showing the Road Widening on |
Wambo
Mining |
Road
closure and use (response to Ross Hawkes). |
Meeting
with land owner is currently being scheduled |
|
Road
Purchase Licence Agreement and Reporting/Relationship. |
Rezoning
with Consultants, Council to wait on report from Consultants. H H cant get client to sign because its not
in their best interest. |
|
Land
acquisition and road opening/closure (Patton). |
Concept
plan for design is to be completed.
Work to be extended for an extra curve which is to be designed
in-house, total 7 curves |
|
Land
acquisition and road opening ( |
Surveyor
to be engaged for Plan of subdivision (opening and closing). Concept plan for design is to be
completed. Work to be extended for an
extra curve which is to be designed in-house, total 7 curves |
|
Land
acquisition and road opening (Department of Defence). |
Negotiate
with Department of Defence |
|
(Double
crossing) – land acquisition and road opening (Bailey). |
Negotiate
with Landowner and arrange acquisition |
|
Land
acquisition and road opening (Neal). |
Review
design, check with works, and commence acquisition and road opening. |
|
Land
acquisition and road opening (Boyce). |
Awaiting
response from Joy before report to Council |
Old
|
Land
acquisition and road opening (Forrester). |
Preliminary
Design completed. Inspection with
works required. Including road
opening, survey, concept design |
Hambledon
Hill road |
Land
acquisition and road opening and closure (O’Hara and Andrews). |
Negotiate
and obtain Permit to enter with O'Hara & Andrews. |
|
Land
acquisition (road widening). |
Road Widening - Notification Letter to
residents sent out. Waiting response from residents |
Stony
|
Road
opening (Glennies Creek Mine). |
Follow
up February 2008 |
Middle
|
Road
closure for mining (Rix’s Creek, Glennies Creek and Camberwell). |
Arrange
sale of land to the Mine. Valuation
and contract of |
Gravel Pit, |
Under Utilised and Surplus Public Land - Roads: Gravel Pit, |
Meeting
scheduled for Monday 25 Feb to discuss status |
Gravel Quarry, |
Under Utilised and Surplus Public Land - Roads: Gravel
Quarry, |
Meeting
scheduled for Monday 25 Feb to discuss status |
Road
off |
Under Utilised and Surplus Public Land - Roads: Road off Old
North Road and Hermitage Road, 1D Reference 257, Lot 1 DP 823737
(Fitzsimmons). |
Meeting
scheduled for Monday 25 Feb to discuss status |
Closed
road near |
Under Utilised and Surplus Public Land - Roads: Closed road
near Hermitage Road, Pokolbin, ID Reference 281, 283, 284, Lots 1,2,3 DP
843117. |
Meeting
scheduled for Monday 25 Feb to discuss status |
Vacant
land near |
Under Utilised and Surplus Public Land - Roads:
Vacant land near Hermitage Road, Pokolbin, ID Reference 286, 287, 288, Lots
3,4,5 DP 843118. |
Meeting
scheduled for Monday 25 Feb to discuss status |
Vacant
land, |
Under Utilised and Surplus Public Land - Roads: Vacant land,
Wollombi Road, Paynes Crossing, ID Reference 312, Lot 279 DP 855697. |
Meeting
scheduled for Monday 25 Feb to discuss status |
Vacant
land, corner of |
Under Utilised and Surplus Public Land - Roads: Vacant land,
corner of Old North Road and Hermitage Road, Pokolbin, ID Reference 313, Lot
42 DP 858233 (Fitzsimmons). (linked to 1.54.2) |
Meeting
scheduled for Monday 25 Feb to discuss status |
Residue
vacant land, |
Under Utilised and |
Meeting
scheduled for Monday 25 Feb to discuss status |
Closed
road, |
Under Utilised and Surplus Public Land - Roads: Closed road,
New England Highway, Camberwell, ID Reference 328, 329, Lots 1 and 3 DP
873260. (Relates to 1.53) |
Meeting
scheduled for Monday 25 Feb to discuss status |
Road
widening, |
Under Utilised and |
Meeting
scheduled for Monday 25 Feb to discuss status |
|
Road
Deviation |
Pegasus
is working on the plan |
Tender Administration |
T2008.001
– Asset Valuation Services |
Tender
documents prepared |
|
T2008.002
– Construction of Bridge over Barney’s Creek (replacement of |
Tender
documents prepared |
|
T2008.003
– Supply & Delivery of 2 x 9t Tipper and 1 x 2t Double Cab Utility |
Tender
documents prepared |
|
T2008.004
– Construction of bridge - Stringy Bark Creek |
Tender
documents prepared |
|
T2008.005
– Trade & Miscellaneous Services |
Tender
documents currently being prepared |
Other
Matters |
Road status searches and general enquiries |
Ongoing |
Utility Notifications |
Ongoing |
FOR
COUNCIL’S INFORMATION Chris Martin Manager Design and Contracts Director
Operations |
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Works Report No. 2/08 |
|
|
1. |
Works Program
Area Maintenance and Construction Author: Brendan Behringer |
FILE: 02/0281 |
Detail: The
following works have been completed, are in progress or are programmed to be
commenced by the Works Program Area. |
a) Regional Roads Improvement Program
Road |
Location |
Nature of Work |
Status |
|
2.28 to 3.87km from Cessnock boundary ( |
Rehabilitation
of existing 1590m section of road involving pavement widening, strengthening
and sealing. |
10%
complete |
|
3.65 to 5.30km from Broke |
Rehabilitation
of existing 1650m section of road involving pavement widening, strengthening
and resealing. |
30%
complete |
Queen
Street (RR128) |
0.60 – 1.00km from |
Rehabilitation
of existing 400m section involving pavement strengthening. |
10%
complete |
(b) Auslink Strategic Regional Program
|
0.00 to 2.20km from |
Rehabilitation
of existing 2200m section involving pavement widening, strengthening and
resealing |
30%
complete Stage 1
– First 1000m |
(c)
Road |
Location |
Nature of Work |
Status |
Glendonbrook Road
(RR128) |
Boyces Bridge over Webbers Creek |
Construction
of new concrete bridge to replace existing timber bridge. |
Bridge 50% complete Boundary fencing complete |
(d) Local Roads Improvement Program
Road |
Location |
Nature of Work |
Status |
|
9.60 to
10.8km from |
Rehabilitation of existing 1200m section of road involving pavement widening, strengthening and resealing. |
To commence |
(e) Supplementary Roads to Recovery
Road |
Location |
Nature of Work |
Status |
Middle |
|
Replacement of timber structure with pipe culverts. |
10% complete (design complete) |
(f) Footpath Construction Program
Road |
Location |
Nature of Work |
Status |
Boundary Street |
|
Construction of concrete footpath. |
To commence |
(g) Other Works
Road |
Location |
Nature of Work |
Status |
|
|
Construction of unsealed section of road on correct road reserve alignment. |
80% complete |
(h) Flood Damage Repairs
Nature of Work |
Status |
Damage claims and permanent repairs. Estimates have been prepared for all roads with some already submitted and approved by RTA. Further geotechnical and engineering advice being sought to finalise some claims. |
Permanent restoration works 70% complete |
(i) General Maintenance
Carried out on State Roads, Regional Roads, Rural Local Roads and Urban Local Roads where required, including the following:
Maintenance |
|
Sealed maintenance |
Bridgman,
Stony Creek, Hebden, Wallaby Scrub, Milbrodale, Hermitage, |
Shoulder maintenance |
Stanhope, Charlton and Wollombi Roads. |
Roadside Maintenance |
McMullins, |
Unsealed Maintenance |
|
Reseals |
Surface Preparation Rural - complete Resealing Rural - complete Surface Preparation Urban - 25% complete Resealing Urban to commence in March |
|
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Works Report No. 2/08 |
|
|
2. |
Bitumen
Resealing Program Author: Brendan
Behringer |
FILE: 02/0281 |
Detail: Council
is programming to commence its urban bitumen resealing program in March,
2008. |
The bitumen and aggregate surface acts as the wearing surface, reducing the rate of pavement wear and maintenance costs by reducing surface moisture reaching the pavement. It also improves the riding qualities of the pavement as well as providing a safe, economical and durable all weather surface.
ROAD |
LOCATION |
|
Town Streets |
|
|
|
George to |
|
|
Queen St to |
|
|
|
|
Camberwell Streets |
|
|
Alpha Street |
0.00 to 0.29km from |
|
Alpha Street |
0.00 to 0.12km from |
|
Alpha Street |
0.00 to 0.12km from |
|
|
0.00 to 0.33km from |
|
|
0.00 to 0.12km from |
|
|
0.00 to 0.25km from |
|
Dunn Close |
0.00 to 0.07km from |
|
|
0.00 to 0.15km from |
|
|
0.00 to 0.23km from |
|
|
0.00 to 0.09km from |
|
|
0.09 to 0.96km from |
|
|
0.00 to 0.22km from |
|
|
0.00 to 0.44km from |
|
|
0.00 to 0.23km from |
|
|
0.00 to 0.93km from |
|
|
|
|
|
|
|
|
SH9 to |
|
|
|
|
Hume Close |
off |
|
|
|
|
Mt Thorley Industrial Estate |
|
|
|
||
Woodlands |
|
|
|
off Maskey rd |
|
Whybrow |
Piercefield to Maskey |
|
Maskey |
Hedley to Whybrow |
|
|
Piercefield to
Woodlands |
|
|
Piercefield to
Woodlands |
The roads to be resealed were selected from:
· Historical data, with the aim of resealing all roads at least every ten years,
· Field inspections to identify those roads most in need of a reseal, and
· Those roads that were reconstructed in 2006/07 to provide their second coat.
Pre-treatment of the roads to be resealed has commenced and is approximately 25% complete. This pre-treatment work involves hand patching, heavy patching and edge repairs and is an essential part of the resurfacing program to ensure maximum wearing surface performance.
|
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Works Report No. 2/08 |
|
|
3. |
Paved
Footpath Construction Program Author: Greg McTaggart |
FILE: 01/0602 |
Executive
Summary: Paved
footpaths play a vital role in our urban community. They provide a link for
pedestrians, including the disabled, from residential areas to amenities such
as commercial
centres, schools, recreational facilities, and community gathering points
etc. The purpose of this report is to review and update the current adopted
Paved Footpath Construction Program. |
Background:
Allocation
The budget for this program in the
2007/08 financial year is sufficient to complete one project only and is funded
from Council revenue and a contribution of $400 from the single adjoining
landholder.
Without confirmation of the level
of funding, it is proposed that as with previous years this report only
establish a priority list for the footpath construction program and that the
proposed projects be carried out in this priority order to the extent that the
allocated funds permit.
Existing Priority
List
Table 1 below depicts the footpath
construction priority list that was adopted in principle by this Committee on 5
March, 2007.
Table 1. Proposed Footpath Construction
Priority List 2007/08 |
|||||
Road |
Section |
Facilities Accessed |
m² |
Total Project Cost |
Score |
Queen St |
|
School, church, club,
x-ing facilities, cemetery. |
192 |
$ 17,280 |
50 |
Queen St |
|
School, church, club,
sporting fields, car park, x-ing facilities. |
168 |
$ 15,120 |
50 |
|
Bridgman – Dunolly, sth
side |
Shops,
Caravan park, Sports Field, x-ing facilities. |
420 |
$ 37,800 |
41 |
|
Alroy Oval – 180m west |
Shops, School,
Pre-school, field, Community Centre. |
216 |
$ 19,440 |
34 |
|
|
Shops, School,
Pre-school, field, Community Centre. |
216 |
$ 19,440 |
34 |
Totals |
1212 |
$109,080 |
|
Revision of Priority List:
Completed Projects
Funding levels in 2007/08 will result in the top project (
New Projects
As with previous years the possible locations for new sections of footpaths are identified by observation of wear paths. Identification of wear is a good indication of the need for a footpath and the level of wear is generally indicative of the level of use that a footway receives. This process did not reveal any new sections of footpath that require paving nor did we receive any requests for footpath paving in the past twelve months.
Development
of New Priority List:
Priority Matrix
In order to determine the order of priority of construction of footpath projects the matrix used by Council in previous years continues to be used. The matrix cross-references the level of use of the footway with the types of facilities that it will access and is shown below:
Footpath Priority Matrix |
||||
Level of Use |
Type of Facility Accessed |
|||
Priority Score |
||||
Business |
Schools |
Community |
Crossing Facilities |
|
High |
12 |
11 |
10 |
9 |
Medium |
8 |
7 |
6 |
5 |
Low |
4 |
3 |
2 |
1 |
Project Cost Review
In the past, estimated costs have only applied to the construction of the footpath and have not taken into account utility adjustments or construction of pedestrian ramps at road intersections and pedestrian crossings. These additional costs have been absorbed by the footpath maintenance vote. As this vote is needed for maintenance of footpaths it is appropriate that it be used for its intended use and not for new construction. Cost estimates in the revised program for 2008/09 have therefore been adjusted to reflect the full and true costs of footpath construction.
Proposed New Priority List
Table 2 below is the revised priority list for new footpath
construction. It excludes the
Table 2. Proposed Footpath Construction
Priority List 2008/09 |
|||||
Road |
Section |
Facilities Accessed |
m² |
Total Project Cost |
Score |
Queen St |
|
School, church, club,
sporting fields, car park, x-ing facilities. |
168 |
$ 20,160 |
50 |
|
Bridgman – Dunolly, sth
side |
Shops,
Caravan park, Sports Field, x-ing facilities. |
420 |
$ 50,400 |
41 |
|
Alroy Oval – 180m west |
Shops, School,
Pre-school, field, Community Centre. |
216 |
$ 25,920 |
34 |
|
|
Shops, School,
Pre-school, field, Community Centre. |
216 |
$ 25,920 |
34 |
Totals |
1020 |
$122,400 |
|
Management Plan:
Overall the objective
of the Works Program Area is “To provide efficient and effective management
of resources in order to maintain all transport infrastructure in a safe
condition and in a manner that minimises life–cycle costs.”
The Strategic Aims
of the Works Program Area that relate to footpath construction are to improve
access for non motorised traffic and to minimise Council’s exposure to
litigation.
Council Policy:
Policy on footpath construction is contained within Council’s adopted
“Footpaths/Cycleways Management Strategy”. The relevant parts of this policy
are as follows:
Council has a duty of care to satisfactorily construct…all
Footpaths/Cycleways on Council owned land to enhance the safety of all users.
It is also imperative that Council put in place planning measures to ensure
that the current and future pedestrian needs of our community are adequately
catered for and to direct the limited funds to the areas of most need. To
provide a Footpath/Cycleway network that as far as fiscally possible meets the
current and future needs of the community…New footpaths are generally only
provided in areas where kerbing and guttering exists and there is an existing
significant level of pedestrian use. 50% of the cost of construction of
footpaths is borne by the adjacent landowner up to a maximum contribution of
$400…”
Legislation:
The relevant parts
of Section 217 of the Roads Act – 1993 reads as follows:
(1) The
owner of land adjoining a public road is liable to contribute to the cost
incurred by a roads authority in constructing or paving any kerb, gutter or
footway along the side of the public road adjacent to the land.
(2) The
amount of the contribution is to be such amount (not more than half of the
cost) as the roads authority may determine.
(3) The
owner of land the subject of such a determination becomes liable to pay the
amount determined on receiving notice of that amount.
Sustainability:
Social:
Footpaths have many social
benefits, which include the following:
Access:
Footpaths provide easier access
for pedestrians (especially people with disabilities)
to reach their
destination.
Safety:
Footpaths enhance the safety of
pedestrians by providing a more even, smoother
surface to use.
Recreation:
Footpaths give the community a
facility to exercise on through activities such
walking and/or jogging.
Footpaths are also often the link between roads and/or
residences and parks,
playgrounds and other recreational facilities.
Direction:
Generally, pedestrians tend to
take the most direct route to their destination. This is
often done without thought about
the safety of where they are crossing a road.
Footpaths provide guidance,
especially for the young to the safest route such as
guiding them to road crossing
facilities.
Environmental:
The erosion of footways caused by
heavy pedestrian traffic in urban areas can only
be described as a blot on the
aesthetic quality of an area. The construction of a
footpath is a significant
positive to the aesthetics of an area as it removes the worn
track, puts a stop to erosion and
protects the adjacent turf by keeping pedestrians on
the concrete.
Financial:
The estimated cost of the
proposed program is $122,400, however as no firm budget
has been set for these works it
is difficult to say how long the program will take to
complete and how much
expenditure will be undertaken in 2007/2008.
Risk Management:
Council’s overall risk management policy for roads and associated
infrastructure is as follows:
“Singleton Council will
endeavour to exercise its duty of care in relation to dedicated Council Public
Roads, by taking all reasonable steps to enhance the
safety of road users, with due regard being given to the nature of the
defect, the level of risk, the use of the road, funding constraints, competing
priorities and minimum standards.”
1. The proposed footpath construction priority list as shown in the Table below be adopted in principle to define Council’s priority order.
2. After the level of funding for footpath construction is established, works be carried out in accordance with the above priority list until funding is exhausted. 3. Contributions
from adjoining landholders under Section 217 of the Roads Act 1993 for the construction of new footpaths be
restricted to a maximum of $400 per
property. |
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Works Report No. 2/08 |
|
|
4. |
Kerb and
Gutter Construction Program Author: Greg McTaggart |
FILE: 99/0057-3 |
Executive
Summary: Kerb and Gutter is an important component
of the urban road infrastructure which serves many functions. It is proposed
in this report to only establish a priority list for the construction of new
kerb and gutter. When the level of funding is established the proposed
projects will be carried out in this priority order until allocated funds are
exhausted. |
Background:
Allocation
In 2007/08 the budget allocation
for this program was sufficient to complete the top project on the priority
list. The sources of funding for this project were allocated from general
revenue and supplemented by the adjoining land owner’s contribution.
Existing Priority
List
Table 1 below outlines the Kerb
and Gutter Construction Program that was adopted in principle by this Committee
on 5 March, 2007.
Table 1. Proposed Kerb and Gutter Construction
Priority List 2007/08 |
||||
Street |
Location |
Length (m) |
Estimated Cost |
Priority Score |
Boundary St |
West and West side Short
– Patrick |
110 |
$
8,580 |
10 |
|
Both
sides, Doyle – |
206 |
$
15,656 |
7 |
Boonal
St |
East
Side, |
184 |
$
13,984 |
7 |
Boonal St |
West side, Sth of Golf
Course to |
120 |
$
9,120 |
7 |
|
K&G
at The Terraces to Sth access to |
650 |
$
49,400 |
7 |
Total |
$ 96,740 |
|
The Need for Kerb and Gutter
Kerb and Gutter links the road
surface with the underlying stormwater drainage system, reduces residents’
exposure to localised flooding, aids in the retention of storm water, enhances
the aesthetic appeal of an area, retards the deterioration process of a roads
surface and pavement, can eliminate the pooling of water and subsequent erosion
of unsealed shoulders. It also serves the purpose of separating the road from
the footpath to control parking and to protect pedestrians. Conversely, it
tends to concentrate water flow and if there is no formal drainage for
stormwater to get away, it can cause problems by collecting and discharging it
on to a property at a single point.
In line with the above, sections
of road that do not have kerb and gutter, can be broken up into four categories
as follows:
i) missing
sections that link existing kerb and gutter,
ii) sections that front properties with a high percentage of hard
surface and where it leads to a piped drainage system,
iii) sections that front properties with a high percentage of
grassed open space, and
iv) sections in areas where there are no piped drainage systems.
Those in categories i) and ii) are
obviously the most important and should be high priorities. Accordingly all,
except two sections, are currently listed on the Approved Kerb and Gutter
Construction Priority List. The two sections not currently included on the
priority list are: -
The
A list of remaining urban streets
that are missing kerb and gutter that fit into categories iii) and iv) have
been identified and are listed below: -
Street |
Location |
Comments |
m |
Whole
St |
Next to high % of grassed open space. No piped
drainage system. |
92 |
|
|
Sth/Wst side, Kent –
Market |
Next to high
% of grassed open space. |
122 |
Boonal St |
West side, Queen St –
sth of Golf Course. |
Next to high
% of grassed open space. No piped
drainage system. |
503 |
Boundary St |
East side, Tennis courts
– Golf Club |
Next to high
% of grassed open space. |
110 |
|
Both sides, |
Next to high
% of grassed open space. No piped drainage system. |
548 |
|
West side, |
Next to high
% of grassed open space. No piped
drainage system. |
340 |
|
Fronting the Showground |
Next to high
% of grassed open space. No piped
drainage system. |
285 |
Crown St |
Both sides Sth
Carrington. Est side, Victoria–Carrington |
Next to high
% of grassed open space. No piped
drainage system. |
390 |
|
Bth sides Phillip –
Bridgman. Sth/Est side Phillip – 7774 |
Next to high
% of grassed open space. No piped drainage system. |
521 |
|
Bridgman – End |
Next to high
% of grassed open space. No piped drainage system. |
400 |
|
Both sides, Carrington –
Dead End |
Next to high
% of grassed open space. No piped
drainage system. |
550 |
|
Nth side, Boonal –
Carroll |
Next to high
% of grassed open space. No piped
drainage system. |
264 |
|
Both sides at |
Next to high
% of grassed open space. |
700 |
|
Nth/East side, Bridgman
– Bank |
Next to high
% of grassed open space. No piped drainage system. |
227 |
|
Dead end, west of
Bridgman |
Next to high
% of grassed open space. No piped drainage system. |
225 |
Queen St |
Sth side, at Golf Course
& Boonal – Raworth |
Next to high
% of grassed open space. No piped
drainage system. |
600 |
|
Both sides, Kelso –
Church |
Next to high
% of grassed open space. No piped
drainage system. |
530 |
All of these sections of missing
kerb and gutter are adjacent to areas with a high percentage of grassed open
space where most have no piped drainage systems to connect to. It is therefore
questionable as to whether they will need kerb and gutter for drainage purposes
while ever these circumstances remain.
Priority System:
For the information of Councillors it is
relevant that the priority system used over a number of years to develop kerb
and gutter priority lists, including the current list, be reiterated. The
factors taken into consideration for prioritisation of new projects are shown
below:
Factor |
Explanation |
Localised
Flooding Relief |
This aspect takes into
account whether the proposed kerb and gutter will reduce exposure to
localised flooding of residential properties and the road. |
Retardation
of Road Deterioration |
This issue considers the
condition of the road and/or shoulder and the ability of the proposed work to
reduce this deterioration. |
Connection
to Existing Infrastructure |
Gives weight
to those projects which complete a piece of existing infrastructure, i.e.
joining two pieces of existing kerb and gutter or linking to stormwater
drainage. |
Road
Widening |
This takes
into consideration projects that will widen the road to Council’s standards. |
Using these factors the matrix below is used
to prioritise the new projects:
Kerb and Gutter Prioritisation Matrix |
||
Factor |
Feature |
Score |
Localised
Flooding Relief |
Reduces Flooding affecting residential
properties and road |
3 |
Reduces Flooding affecting residential
properties or road |
2 |
|
Does not reduce flooding. |
1 |
|
Protection
of Road |
Protects road pavement |
3 |
Protects road shoulder |
2 |
|
Protects wearing surface |
1 |
|
Connection
to Existing Infrastructure |
Connects >2 pieces of existing
infrastructure |
3 |
Connects 2 pieces of existing
infrastructure |
2 |
|
Connects <2 pieces of existing
infrastructure |
1 |
|
Road
Widening |
Widens Road by 2m or more |
3 |
Widens Road by 1< 2m |
2 |
|
Widens Road by < 1m |
1 |
Review of Current Program:
All sections listed on the priority list have
a priority score of 7. And whilst all sections score points for protection of
the road shoulder, the affects of the volume of traffic on
It is therefore logical that installation of
the missing section of kerb and gutter on the section of
Requests Received for new Kerb and Gutter:
Since our last
review, one request has been received for the installation of kerb and gutter
and that was for
Projects Completed
in 2007/2008:
The first project on the approved priority
list,
Proposed Program 2008/09:
As mentioned previously, all of the missing
sections of kerb and gutter have been identified and all of the critical
sections have been included in the priority list. The benefits of moving part
of the Ryan Avenue kerb and gutter project to the highest priority has been
discussed and has resulted in the 2008/09 proposed priority list as shown in table 2 below:
Table 2. Proposed Kerb and Gutter Construction
Priority List 2008/09 |
||||
Street |
Location |
Length (m) |
Estimated Cost |
Priority Score |
|
K&G
at Sun Dial to |
350 |
$
28,000 |
7 |
|
|
300 |
$
24,000 |
|
|
Both
sides, Doyle – |
206 |
$
16,480 |
7 |
Boonal Street |
East
Side, |
184 |
$
14,720 |
7 |
Boonal Street |
West side, Sth of Golf
Course to |
120 |
$
9,600 |
7 |
Total |
$ 92,800 |
|
Management Plan:
Overall the
objective of the Works Program Area is “To provide efficient and effective
management of resources in order to maintain all transport infrastructure in a
safe condition and in a manner that minimises life – cycle costs.”
The strategic aims
of the Works Program Area that relate to new kerb and gutter construction are
to:
· Reduce the impact that storm events have on
residential amenity.
· Minimise Council general revenue expenditure on
transport infrastructure whilst optimising the benefits to the community.
Legislation:
The relevant parts
of Section 217 of the Roads Act – 1993 reads as follows:
(1) The
owner of land adjoining a public road is liable to contribute to the cost
incurred by a roads authority in constructing or paving any kerb, gutter or
footway along the side of the public road adjacent to the land.
(2) The
amount of the contribution is to be such amount (not more than half of the
cost) as the roads authority may determine.
(3) The
owner of land the subject of such a determination becomes liable to pay the
amount determined on receiving notice of that amount.
Sustainability:
Social:
Kerb and Gutter reduces residents’
exposure to localised flooding and separates the road from the footpath which
can aid in the control of parking and protection of pedestrians.
Environmental:
From the perspective of the environment
kerb and gutter links the road surface with the underlying stormwater drainage
system which can help channel rubbish and debris into collection or filtering
facilities such as Gross Pollutant Traps and wetlands/reedbeds. It also
enhances the aesthetic appeal of an area.
Financial:
Council can recover half the cost
of kerb and gutter construction in line with Section 217 of the Roads Act 1993.
However, we find that when we construct new kerb and gutter there is a varying
width of road pavement to construct to link the gutter to the existing edge of
the bitumen. To be fair the recoverable cost does not include the cost of
shoulder reconstruction. It only includes half the cost of the new kerb and
gutter and reinstatement of the footway behind the kerb. Using this formula a
contribution of $40 per metre will be imposed on the adjoining land owner.
The estimated cost of the proposed program is
$92,800, but as no firm budget has been set for these works it is difficult to
say how long the program will take to complete or how much work will be
undertaken in 2008/09.
Despite the initial cost of kerb
and gutter, it can incur savings in other areas such as:
· a reduction in the required amount
of underground drainage,
· the slowing down of the
deterioration of a roads pavement by helping negate the infiltration of water
into the pavement, and
· the elimination of erosion of
unsealed shoulders.
Risk Management:
Council’s overall risk management policy for
roads and associated infrastructure is as follows:
“Singleton Council will
endeavour to exercise its duty of care in relation to dedicated Council Public
Roads, by taking all reasonable steps to enhance the
safety of road users, with due regard being given to the nature of the
defect, the level of risk, the use of the road, funding constraints, competing
priorities and minimum standards.”
Conclusion:
The construction of Kerb and Gutter in appropriate locations is an
efficient and effective method of minimising life–cycle costs for other road
infrastructure. It minimises Council general revenue
expenditure on transport infrastructure whilst optimising the benefits to the
community.
1. The proposed kerb and gutter construction priority list as
shown in the Table below be adopted in principle to define Council’s priority
order.
2. After the level of funding for the kerb and gutter
construction is established, works be carried out in accordance with the
above priority list until funding is exhausted. 3. The 50% Contributions from adjoining landholders under
Section 217 of the Roads Act 1993 for the construction of new kerb and gutter
not include the cost of construction of the road shoulder. |
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Works Report No. 2/08 |
|
|
5. |
Minutes of
Local Development Committee Meeting 19 February 2008 Author: Michael Launders |
FILE: 00/0002-2 |
Detail: The Minutes of the Singleton Local
Development Committee meeting held 19 February 2008 are detailed as Attachment 1. |
|
AT-1View |
Minutes LDC 19.02.08 |
4 Pages |
Manager Works Report No. 2/08 |
|
Minutes LDC 19.02.08 |
Minutes of Local Development
Committee Meeting 19 February 2008 |
|
|
MINUTES
OF THE LOCAL DEVELOPMENT COMMITTEE MEETING HELD IN THE COUNCIL COMMITTEE ROOM
ON THE 19TH FEBRUARY 2008 COMMENCING AT 10.36 A.M.
PRESENT
RTA: Mr. I. Jenkins. (Road
Safety and Traffic Officer)
Police: Sergeant R. Akerman, (Traffic
Officer,
Council: Cr. S. Moore, Mr. G. McTaggart
(Manager Works) Mr. D. Simon ( Town Planner), Mr. S. Mack (Trainee Engineer), M/s A. Power (
Visitor: Mr. S. Pocock of
Compass Planning
APOLOGY: Mr. G. Woodman (Director Operations)
MINUTES Resolved that the
Minutes of the Local Development Committee Meeting, held on the 23rd August
2008 as circularized be received and adopted.
(Akerman
/ Jenkins)
1. BUSINESS ARISING
FROM MINUTES OF PREVIOUS MEETING
1.1 PROPOSED BUS DEPOT DA 343 / 2007
The RTA representative asked a question as to the progress
of DA 343 / 2007 which was the sole item on the agenda at the previous meeting.
He was advised that construction of this project had begun.
2. DEVELOPMENT PROPOSALS REFERRED
BY DEVELOPMENT SERVICES
2.1 PROPOSED VISITOR INFORMATION CENTRE FILE:
DA. 5 / 2008
Proposal: To develop a Visitor Information
Centre (VIC) in the existing
Applicant: Singleton Council.
Singleton Council is proposing to remove an existing building in
· Public toilets
· Picnic furniture including gas
barbeques.
· A children’s playground complete
with modern play equipment.
· A hard surfaced cycle riding
track for children using cycles, scooters, roller blades etc.
· City Guide Map board.
The park is also the venue for special events such as:
· Sunday markets
· Lions Club Driver Reviver.
· The Rotary Christmas event for
children.
· Police speed and drink driving
testing programmes.
Off Street Parking
Both EJE’s Statement of Environmental Effects and Parsons
Brinckerhoff’s Traffic Impact Statement use the Maitland VIC as an example to
assess car parking needs. However this comparison is not 100% valid as it does
not take into consideration the existing usage of the
“Table 1” below:
Table 1 Off |
||||
Date |
Time |
Vehicles |
Weather |
Note |
Wed 23.1.2008 |
10.11 |
11 |
Fine, sunny |
School hols |
|
10.50 |
15 |
|
|
|
11.21 |
15 |
|
|
|
13.14 |
14 |
|
4 vehicles had caravans |
|
14.20 |
17 |
|
1 vehicles had a caravan |
|
15.49 |
14 |
|
|
|
16.46 |
11 |
|
1 vehicles had a caravan |
|
|
|
|
|
Thur 24.1.2008 |
8.30 |
5 |
Fine, sunny |
1 vehicles had a caravan |
|
8.44 |
7 |
|
1 vehicles had a caravan |
|
9.24 |
4 |
|
1 vehicles had a caravan |
|
10.31 |
11 |
|
2 vehicles had caravans. |
The Maitland VIC site does not have the range of activities and
facilities that already exist at
On Street Parking
The proposal as presented in EJE’s Statement of Environmental
Effects proposes that coach parking be on street at the following locations:
· Western side of
· Eastern side of
It is also proposed that overflow parking will be on street.
In relation to on-street parking in
Solid Waste
No mention has been made in relation to solid waste storage and
disposal apart from a wheelie bin alcove shown for two bins on drawing “AO1”.
If the centre proposed is to use commercial waste bins initially or at a later
date they will have to be located where they can be accessed by large rigid
trucks. Such trucks could pose a hazard if they have to reverse in an area that
is already popular to children.
A definitive statement should be made on how the solid waste
created by the proposed VIC is to be stored and collected.
Site Access
It should be noted that Parson Brinckerhoff’s access assessment
was based on the two existing access points to the
correspondence, dated, 8th August 2007, recommended a
single access point only, with the second access point to be disposed of.
The RTA also sought measures that would ensure that the flow of
south bound vehicles on the highway would not be obstructed by vehicles turning
right into
Local Development Committee RECOMMENDS that, the application be referred back to the
applicant of the proposed Visitor
Information Centre in
:
1. Off
–street parking
(i) Be
reassessed to take into consideration the existing levels of parking that occur
in the existing off-street car park in
(ii) Provision
being made for long vehicle (vehicle with caravan attached) and service,
vehicles.
2. Parking
restrictions in the turning bulb so that long vehicles or vehicle combinations
can turn without having to reverse.
3. Storage
and removal of solid waste from the proposed development.
4. Possible
loss of on-street parking on the eastern side of Maitland Road across the
frontage of numbers “34”,”36” and the service station.
5. Possible angle parking
in
6. The undesirable use of
Meeting closed at 11.30 am
M
LAUNDERS
TRAFFIC
COORDINATOR
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Works Report No. 2/08 |
|
|
6. |
Minutes of
Local Traffic Committee Meeting - 19 February 2008 Author: Michael Launders |
FILE: 00/0002-2 |
Detail: The Minutes of the Singleton Local Traffic Committee meeting held 19 February 2008 are detailed as Attachment 1. |
|
AT-1View |
Minutes LTC 19.02.08 |
9 Pages |
Manager Works Report No. 2/08 |
|
Minutes LTC 19.02.08 |
Minutes of Local Traffic
Committee Meeting - 19 February 2008 |
|
|
MINUTES
OF THE LOCAL TRAFFIC COMMITTEE MEETING HELD IN THE COUNCIL COMMITTEE ROOM ON 19TH FEBRUARY 2008 COMMENCING AT 9.30 A.M.
PRESENT
RTA: Mr. I Jenkins. (Road Safety and
Traffic Officer)
Police: Sergeant R. Akerman,
(Traffic Officer, Hunter Valley Local Area Command.) only, for the period from
Item “2.1” to the conclusion of the meeting.
Local Member: Member for Upper
Hunter represented by Mr. R. Winter.
Council: Cr. S. Moore, Mr. G.
McTaggart (Manager Works), Mr. S. Mackie (Trainee Engineer) and Mr. M. Launders
(Traffic Coordinator).
APOLOGY: Mr. G. Woodman (Director Operations)
MINUTES:
Resolved, that the Minutes of the
Local Traffic Committee Meeting, held on the 19th December 2008 as circularized be
received and adopted.
(Moore / Jenkins)
Relevant extracts of the Minutes
of Councils Operations Committee meetings held on the 4th February 2008 were noted.
1. BUSINESS ARISING
FROM MINUTES OF PREVIOUS MEETING
No matters were raised
2. FORMAL AGENDA
2.1 PAST
COMMITTEE MEMBER
FILE: OR.MTG
Issue: The passing away of Mr. Gordon
Wright a former member of the Committee.
The Committee was informed of the
death of a former Committee member Mr. Gordon Wright of
Gordon represented the Member for
Cessnock between the 18th November 1999 and the 19th May
2005. Gordon carried out his Committee
duties in an efficient and pleasant, relaxed manner and was a delight to serve
with.
Gordon, aged 58, passed away at the
Out of respect for Gordon’s service
two minutes silence was observed and the Committee resolved to pass its
condolences to Gordon’s wife Rhonda.
For INFORMATION only
3. INFORMAL AGENDA ITEMS (For Determination by
the RTA)
Issue: Request
for No Stopping parking restrictions on the south side of
Source: Membership
of Singleton S.E.S. via Cr. Moore
On the 4th
September 2006 this issue was put to the Operations Committee of Council which
resolved that the matter be referred back to the Local Traffic Committee for
consideration of imposition of a No Parking Zone on the southern side of Queen
Street near the SES facility from 1 car park east of the S.E.S building
entrance to the New England Highway off ramp. (min 329/06)
The above Operations Committee conflicted
with the Local Traffic Committees recommendation which recommended “that to
assist S.E.S. plant in accessing the Queen Street carriageway from its base at
No 9-11 Queen Street “No Parking” parking restrictions of one motor vehicle
length be imposed on each side of the vehicle access point to No 9 -11 Queen
Street.”
Since the
issue was put back to the Local Traffic Committee the following relevant events
have occurred:
· A flood
emergency in June 2007.
· Patrons
of events in the Civic Centre during December 2007 parked in the off-street car
park of the S.E.S. complex.
During
the flood emergency over the holiday weekend in June 2007 the S.E.S. became
active resulting in heavy on-street parking on the southern side of
The hard
surface in the S.E.S. grounds has the capacity to park five vehicles in places
that would not obstruct the six vehicle doors in the S.E.S. buildings. The
parking in the S.E.S. car park in December 2007 resulted in a complaint being
lodged by leadership of the local S.E.S.
This
issue in relation to the on-street parking relates to seven on-street parking
spaces at the location illustrated in the following diagram:
To expel
casual parking from the S.E.S. off-street car park will place the demand
elsewhere. It will not reduce the amount of motorists seeking parking. For this
reason the amount of on-street parking should only be reduced where it is
absolutely necessary. In this particular case the on-street parking should only
be restricted in the two parking spots that occur on the east side and the one
that occurs on the west side of the S.E.S. vehicle access.
Local
Traffic Committee RECOMMENDS that:
1. To
facilitate access to the S.E.S. complex at No 9 – 11 Queen Street, “No Parking”
parking restrictions be imposed on the
southern side of Queen Street for five metres west of and ten metres east of
the vehicle access point of the complex.
2. To prevent
parties not involved in S.E.S. activities parking in the S.E.S. complexes
off-street car park at
(Akerman / Jenkins )
FILE: RD 00127
Issue: Request to explore lowering the
existing 100 km/h speed limit to 80 km/h from Broke to Paynes Crossing as a
means of reducing the speeds of weekend motor cycles on the road.
Source: Cr. G. Sharrock, via Councillors Request Form No 1232, of 12.11.2007.
Cr. Sharrock made the following request in writing:
“80km/h
speed limits on
Several
residents of
I would
like the option of 80km/h speed limits to be examined by the traffic advisory
committee.”
Around April 2007 the RTA reduced the 100km / h speed
limit on
The subject section of
It should be noted that the name
The subject length of
|
|
Feature |
Data
Relative To Feature |
Length |
17.2 km |
Carriageway
Pavement |
6.0 –
6.5 m wide bitumen sealed pavement. |
Carriageway
Alignment · Horiz. · Vert. |
· 32
horizontal curves with the speed advisory ratings as per the following table.
· Relative flat, with some vertical
curves. |
Traffic
Facilities |
· “60” km/h speed limit for the
first 0.15 km south of · “100” km/h
speed limit between 0.15 km to 17.00 km south of Singleton Street, Broke · “80”
km/h speed from 17.00 km south of · Appropriate
curve and speed advisory signs. |
Traffic
Volume |
299
vehicles per day at 9 km south of Broke. |
Occupation
Features |
· 47 rural address numbers most
with at least one dwelling. . · 69
paddock gates that front the road reservation. |
Responsible
Road Authority |
RTA.
(RR 127) |
Accident
Incidents |
Eight
on state records for the period 1/1/2001 to 31/12/2006 See details in
APPENDIX 1. |
Horizontal |
|||
|
|
|
|
Speed
Advisory in Km/h |
Quantity |
Speed
Advisory in Km/h |
Quantity |
100+ |
3 |
55 |
0 |
95 |
4 |
45 |
1 |
85 |
5 |
35 |
0 |
75 |
14 |
25 |
0 |
65 |
5 |
|
|
Official accident records for the subject road were
examined for the period 1.01.2001 to 31.12.2006, eight accidents incidents were
found and a summary is included in the following table:
Summary Accident |
|
Number |
8 |
Year / Quantity |
2006 / 2, 2005 / 1, 2004 / 1, 2003 / 3, 2002 / 1,
2001 / 0. |
Accident Type - Quantity |
All single vehicle accidents where a vehicle: · Left
the carriageway and struck an object – 7 · Struck
an object on the carriageway - 1 |
Vehicle Type - Quantity |
Four wheel drive – 1 Motorcycle – 3 Light Truck – 3 Car – 1 |
Casualties |
Injured – 7 Killed - 1 |
The majority (seven) of accident incidents involved
vehicles running off the carriageway of the road and striking a road side
object.
Highway Patrol police attached to the Upper Hunter
Area Command welcomed the introduction of the 80 km /h speed zone on
In comparing plan views of
By direct comparison with
When making comparisons between
· 2008
calendar year upgrade of 8.15 km to 11.0 km including the new
· 2009
/2010 fiscal year upgrade of 13.8 km to 15.05 km.
Local
Traffic Committee RECOMMENDS that,
the reduction of the existing 100 km/h speed limit on Wollombi Road be
reconsidered, if necessary, after the proposed improvement works scheduled up
to and including the 2009 / 2010 fiscal year are completed.
(Moore / Akerman)
3. FALBROOK ROAD FILE:
RD 00105
Issue: Request for consideration to be
given to providing a speed limit on
Sources: Mr J.T. Reid,
On the 17th December 2007 Mr
J.T. Reid approached Councils Customer Service section and filed a verbal
complaint about
· Cars
travelling along the road to a mine site are driving extremely fast.
· There is
no speed limit on the road.
· He is
unable to ride his horse on the road anymore.
· A number
of accidents have happened along the road to mine employees speeding and falling
asleep whilst driving after long shifts.
· He
suggested the road should have a speed limit
In general
|
|
Feature |
Data Relative To Feature |
Length |
7.1 Km. |
Carriageway Pavement |
Bitumen
sealed pavement in the order of 4 - 5m wide |
Carriageway
Alignment · Horiz. · Vert. |
· Around
15 horizontal curves · A small
number of crest and sag curves |
Traffic controls |
· “100”
km/h default speed limit. |
Traffic Volume |
See following table |
Occupation Features |
· One
road junction ( · 16
rural addresses most with occupied dwellings. · 13
paddock gates that front the road reservation. One of which appears to give
access to a mine exploration site. |
Responsible Road Authority |
Singleton Council |
Accident Incidents |
One on state records for the period 1/1/2001 to
31/12/2006. See following table for details. |
Field data complied from site inspection on
17/1/2008 |
Traffic |
||
Month
/Year |
Location
Distance from |
Vehicles
Per Day |
June 2001 |
0.230 |
132 |
|
|
|
Jan –Feb 2008 |
6.825 |
77 |
Accident |
|
Date / Time |
14.07.02 / 9.05 hrs |
Location |
1.46 km nth of |
Weather / Surface / Vehicle / Driver |
ocast / dry / motorcycle / M 39 |
Direction of travel |
Nth in |
Speed / Severity |
? / injury |
Involved / Killed / Injured |
1/0/1 |
Rum code / Other vehicle |
85 off rt . lft
bend => obj / phone pillar |
From the research carried out only
one accident incident appeared on official state records. The traffic volumes
recorded indicate that there is not a lot of through traffic on
In relation to the speed limit for
Local
Traffic Committee RECOMMENDS that, the default speed limit remains
on
(Winter /
Akerman)
Meeting closed at 10.35 am
M
LAUNDERS
TRAFFIC
COORDINATOR
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Works Report No. 2/08 |
|
|
7. |
2008/2009
Local Roads Improvement Program Author: Greg McTaggart |
FILE: 01/0228 |
Executive
Summary: The Local Roads Improvement Program
contains projects involving the upgrading of sealed rural and urban roads and
the sealing of unsealed rural roads. The purpose of this report is to
determine the roads most in need of upgrading and to prepare a five year
rolling program for the works. |
Background:
Funding Levels:
Financial Assistance Grant (FAG)
The Financial Assistance Grant for
roads in 2007/08 was $782,271. It expected that this level of funding will be
at least maintained over the next five years. Hence, an allocation of $782,271
has been adopted as the FAG allocation for each year of the proposed five year
program.
Auslink Roads to Recovery Program
The
Auslink Roads to Recovery allocation for 2008/09 will be $468,355. This four
year program will end in June 2009 and no commitment has been made by the new
Federal Government to extend the program beyond 2008/09. Therefore, for the
purposes of this report $468,355 will be adopted as the Auslink
Roads to Recovery allocation for 2008/09 and no funding from this source will
be assumed in 2009/10 or beyond.
Capital Works Coin Program
As the level of funding available
from this source is currently unavailable, it was considered fitting not to
take Council revenue into account at this stage.
Section 94 Funds
When a road in this
program has Section 94 funds available, these funds will be used to supplement
the cost of the project. If extra Section 94 funds become available then this
source of funds will be used in preference to other funding or to extend the
works if required.
In the 2006/07 and 2007/08 budgets, Council resolved to set aside
$200,000 from the Local Roads Improvement Program for replacement of timber
bridges on local roads.
As funds will be available through
the Auslink Roads to Recovery
Program in 2008/09 it provides a good opportunity to continue setting aside the
same level of funds for the replacement of timber bridges. Without the Auslink
Roads to Recovery Program beyond 2008/09 the overall level of funding will be
reduced and there is little scope to deduct any funds in 2009/10. Fortunately
however, there is no current requirement for funds for the sealing of unsealed
roads in 2010/11 and beyond which provides the opportunity to divert some of
those funds to the Timber Bridge Replacement Program without having any
significant affect on the level of funding for urban or rural sealed roads. For
the purposes of this report, an allocation of $200,000 will apply to the
2008/09 budget and $115,000 to each of the 2010/11, 2011/12 and 2012/13 budgets
for the Timber Bridge Replacement Program.
Total Estimated Funds
It is expected that the total
funding for 2008/09 will be in the order of $1,250,626, plus Council revenue
from the “Coin Exercise” and any additional Section 94 contributions. In
2009/10 this will drop to $782,271 plus Council revenue from the “Coin
Exercise” and any additional Section 94 contributions.
Hence, programs have been prepared
for roads using an allocations of $1,050,626 in 2008/09, $782,271 in 2009/10
and $667,271 in 2010/11 through to 2012/13.
Alterations to Estimated Funds
Should there be any increase in
the above estimations of funding, projects will be extended if possible or the
program will move onto the next highest priority. Similarly, should there be
any decrease in the above estimations, projects will be reduced if possible or
if there are insufficient funds, the lowest priority project will be moved to
the following year. Any alterations in this regard will be reported through the
quarterly review process.
Increase in Costs
Costs have risen by
about 7% on average across the program. Apart from the normal CPI adjustment,
the main reasons for price increases are increasing costs of OH&S, fuel and
bitumen price increases and the high demand for plant and labour hire in the
earthmoving and construction industry. Hence, the allocations and costs in
these programs have been adjusted accordingly.
Allocation of Funds
Allocating funds for
improvements to various roads has always been based on “need” and in the past
our assessment of sharing the funds has proved to be well accepted by the
community. It is pleasing to note that the more heavily trafficked unsealed
roads that have been the source of most of our complaints in the past are now
minimal in length. In fact there are only four kilometres of unsealed road on
three different roads that, in accordance with Council’s policy, currently
require funding. With this in mind the break up of funding has been reviewed
again this year to cater for what is believed to be an appropriate split between
the different categories. The allocations for 2007/08 and the proposed
allocations for each year of the five year rolling programs are shown below:
Program |
2007/08 |
2008/09 |
2009/10 |
2010/11 |
2011/12 |
2012/13 |
2nd
seal on previous year projects Sealing
of unsealed roads Reconstruction
of urban streets Reconstruction of rural sealed rds |
$ 105,026 $ 260,000 $ 275,000 $ 374,000 |
$ 110,271 $ 295,000 $ 275,000 $ 370,355 |
$ 110,271 $ 115,000 $ 200,000 $ 357,000 |
$ 110,271 $ - $ 200,000 $ 357,000 |
$ 110,271 $
- $ 200,000 $ 357,000 |
$ 110,271 $ - $ 200,000 $ 357,000 |
Total |
1,014,026 |
1,050,626 |
782,271 |
667,271 |
667,271 |
667,271 |
Works Programs:
Second
Coat Seal on Previous Year Projects
All rehabilitation, reconstruction and new seal projects require a two coat
seal. Our practice of applying a single coat initially and deferring the second
coat to the next year makes sense and is proving to be successful. The purpose
of leaving the second coat until the following year is to allow traffic on the
section of road to bring to light any minor defects that may develop. These defects can then be rectified before
the second coat is applied. This process, as opposed to applying a double coat
initially, provides a much better job and allows a higher application rate of
bitumen, which provides for better water proofing. It also squeezes in an extra
year before the ten year cyclic reseal is due.
Sealing
of Unsealed Roads
Table 1 below shows the Sealing of
Unsealed Roads Program, approved on 5 March, 2007.
Table. 1 Approved Sealing of Unsealed Roads Program 2007/08 –
2009/10 |
|||||
Road |
Section
|
Estimated Cost |
Developer
Funds |
Cost
to Council |
Vpd |
2007/ 2008 |
|||||
|
4.9 –
5.7km from RR 128 |
$
75,000 |
- |
$ 75,000 |
110 |
|
2.4 –
3.55k from |
$
95,000 |
- |
$ 95,000 |
85 |
Cranky |
00 –
1.63km from |
- |
($ 90,000) |
$
90,000 |
79 |
Total
2007/ 2008 |
$ 170,000 |
($ 90,000) |
$ 260,000 |
|
|
2008/ 2009 |
|||||
|
3.4 –
4.4km from H9 |
$ 100,000 |
- |
$ 100,000 |
81 |
Cranky |
3.8–
4.25km from |
$
60,000 |
- |
$
60,000 |
79 |
|
00 –
1.2km from |
$ 118,000 |
$18,000 |
$ 100,000 |
75 |
Total
2008/2009 |
$ 260,000 |
- |
$ 260,000 |
|
|
2009/ 2010 |
|||||
|
4.4 –
5.5km from H9 |
$ 100,000 |
- |
$ 100,000 |
81 |
|
1.2 –
1.45km from |
$
25,000 |
- |
$
25,000 |
75 |
Total
2009/10 |
$ 125,000 |
- |
$ 125,000 |
|
Review of Program
As outlined in the Roads
Management Strategy only unsealed roads that carry seventy-five vehicles per
day (vpd) are considered for sealing under this program. Each year it is
necessary to review the previously presented program and to introduce any roads
that are now carrying more than seventy-five vehicles per day. During this
review it was kept in mind that there is a need to share the funding in order
to spread the benefit to as many recipients as possible. Hence, only a section
of each road that meets the criteria is upgraded in any one year until
completion.
The review indicated that there
are no new roads to be added to the list of those that now carry 75 or more
vehicles per day.
In past years Council has
considered two other roads that carry 75 vpd, but have excluded them from
funding as they are subject to upgrading through development. Those sections of
road are
In order to complete this program
as soon as possible and to gain some economies of scale, it is logical to
combine the two stages of
In summary, a revised program has been prepared and is shown in Table 2 as follows:
Table. 2 Proposed Sealing of Unsealed Roads Program 2008/09 –
2012/13 |
|||||
Road |
Section
|
Estimated Cost |
Developer
Funds |
Cost
to Council |
Vpd |
2008 / 2009 |
|||||
|
3.4 –
4.4km from H9 |
$
107,000 |
- |
$ 107,000 |
81 |
Cranky |
3.8–
4.25km from |
$
63,000 |
- |
$
63,000 |
79 |
|
00 –
1.8km from |
$ 148,000 |
$
23,000 |
$ 125,000 |
|
Total
2008/2009 |
$ 318,000 |
$ 23,000 |
$ 295,000 |
|
|
|
|||||
2009/ 2010 |
|||||
|
4.4 –
5.5km from H9 |
$
115,000 |
- |
$ 115,000 |
81 |
Total 2009/2010 |
$ 115,000 |
- |
$ 115,000 |
|
Some Councillors will recall many rural Councils in the early 1990’s reverting sealed roads back to gravel because they had reached a point of no return. Fortunately that did not happen at Singleton, however there was a long period where reconstruction of sealed roads required more funds than were being supplied which meant, irrespective of traffic volumes, no unsealed roads were being sealed. It wasn’t until 1997/98 that this program commenced and at that time there was an abundance of unsealed roads carrying more than 75vpd. Since that year Council has sealed almost sixty kilometres of unsealed road and it is very pleasing to now see the light at the end of the tunnel and to have this program up to date by 2009/10.
Reconstruction/Rehabilitation of
Urban Sealed Roads
Table 3 below shows the Urban
Roads Reconstruction/Rehabilitation Program that was approved on 5 March, 2007.
Table. 3 Proposed Urban Roads
Reconstruction/Rehabilitation Program 2007/08 – 2009/10 |
||||
Road Name |
Area |
Section |
Estimated Cost |
Priority Score |
2007 / 2008 |
||||
Boundary Street |
Singleton |
Queen to |
$
84,000 |
0.75 |
|
Singleton |
Dept Education Property at |
$
128,000 |
0.72 |
|
Heights |
|
$ 63,000 |
0.59 |
Total
2007 / 2008 |
$
275,000 |
|
||
2008 / 2009 |
||||
|
Singleton |
|
$275,000 |
0.46 |
Total 2008 / 2009 |
$ 275,000 |
|
||
2009 / 2010 |
||||
|
Singleton |
|
$ 135,000 |
0.83 |
Total 2009 / 2010 |
$ 135,000 |
|
Review
of Program
Council has undertaken a review of the urban road network and identified the following sections of road in need of pavement rehabilitation / reconstruction works.
·
·
·
All assessments for these works are carried out using the Council adopted methodology for prioritising projects which gives consideration to cost, traffic loadings, roughness, rutting, cracking, geometric and width deficiencies and is explained in the Roads Management Strategy. An example is detailed below.
Road Name: |
|
|||
Section: |
|
|||
Area of Works (sq.m) |
1700 |
|||
Total Estimated Cost |
$ 75,000.00 |
|||
Estimated Cost, excluding
Drainage |
$ 50,000.00 |
|||
Cost per square metre (without
drainage) |
29.41 |
|||
Criteria |
Scale |
Selection |
Points |
|
AADT |
<100 |
|
0 |
|
100<250 |
|
0 |
||
250<500 |
|
0 |
||
500<1000 |
|
0 |
||
1000<2500 |
ü |
4 |
||
Heavy Vehicles |
<25 |
ü |
0 |
|
25<50 |
|
0 |
||
50<100 |
|
0 |
||
100 to 200 |
|
0 |
||
Roughness |
<110 |
|
0 |
|
110<150 |
|
0 |
||
150 to 190 |
|
0 |
||
>200 |
ü |
7 |
||
Rutting |
0, S1, S2 |
|
0 |
|
S3, M1, M2 |
ü |
3 |
||
M3, X1, X2, X3 |
|
0 |
||
Cracking |
0, S1, S2 |
|
0 |
|
S3, M1, M2 |
|
0 |
||
M3, X1, X2, X3 |
ü |
6 |
||
Rectifies Geometry Deficiency |
No |
ü |
0 |
|
Improves Vertical or Horizontal Geometry |
|
0 |
||
Improves Vertical & Horizontal Geometry |
|
0 |
||
Rectifies Formation Width Deficiency |
<1m |
ü |
0 |
|
1<2m |
|
0 |
||
2 to 3m |
|
0 |
||
>3m |
|
0 |
||
Total Score |
20 |
|||
Benefit / Cost Ratio |
0.68 |
|||
An existing priority in need of review is the widening of
The much needed improvements on
Another area that is in urgent need of renewal is the asphalt wearing surfaces on a number of streets within the Hunterview Estate. These wearing surfaces have reached the end of their lives and are allowing penetration of water, which causes the road to lose its shape and decrease the quality of ride. They are now at the stage where they not only need resurfacing but also need shape correction. The most effective and economical method of repair on these roads is to use asphalt.
In reality, asphalt resurfacing is a maintenance activity and should
be funded from that source. However, as insufficient funds are allocated to
carry out our cyclic bituminous resealing in accordance with the ten-year
industry standard, we need to look elsewhere for funding for asphalt
resurfacing. If we do not start resheeting these roads soon, they will join a
long list of projects within this program and ultimately need complete
reconstruction at double the price. Hence the reason for looking for funds from
this source. The roads include Acacia Circuit and all those roads to its south
between
Asphalt is much more expensive to replace than a flush seal and the reason for this is first, 10mm asphalt is applied in minimum layer thicknesses of 30mm and secondly, as the height of the wearing surface is restricted by the height of the gutter, there is a need to mill out the existing material. The cost to supply and lay asphalt is around six times the cost of a 10mm flush seal. The advantage of asphalt is that it reduces tyre noise considerably. The disadvantage is the high life cycle cost and the difficulty to gain acceptance from residents if it was proposed to change the wearing surface to a flush seal.
After taking the above projects into account, a revised program has been prepared for Council’s consideration. Table 4 below shows the revised Urban Roads Reconstruction/Rehabilitation Program with the inclusion of the additional roads.
Table. 4 Proposed Urban Roads
Reconstruction/Rehabilitation Program 2008/09 – 2012/13 |
||||
Road Name |
Area |
Section |
Estimated Cost |
Priority Score |
2008 / 2009 |
||||
|
Singleton |
|
$275,000 |
0.46 |
Total 2008 / 2009 |
$ 275,000 |
|
||
|
||||
2009 / 2010 |
||||
|
Singleton |
|
$200,000 |
0.46 |
Total 2009 / 2010 |
$ 200,000 |
|
||
|
||||
2010 / 2011 |
||||
|
Singleton |
|
$ 135,000 |
0.83 |
Urban Streets |
Hunterview |
Asphalt Correction & Resurfacing |
$
65,000 |
1.18 |
Total
2010 / 2011 |
$
200,000 |
|
||
|
||||
2011 / 2012 |
||||
|
Singleton |
|
$ 75,000 |
0.68 |
Combo Lane |
Singleton |
00 – 220m north of |
$ 60,000 |
0.63 |
Urban Streets |
Hunterview |
Asphalt Correction & Resurfacing |
$
65,000 |
0.83 |
Total
2011 / 2012 |
$
200,000 |
|
||
|
||||
2012 / 2013 |
||||
|
Singleton |
50 – 470 m west of H9 |
$ 135,000 |
0.70 |
Urban Streets |
Hunterview |
Asphalt Correction & Resurfacing |
$
65,000 |
0.83 |
Total
2012 / 2013 |
$
200,000 |
|
It is important to note that it is
difficult to estimate the exact costs of these
projects without design plans. Quantities for this work have been estimated,
using experience and local knowledge, hence the costs can only be considered as
“order of cost” estimates. Any
variations will be reported through the quarterly review process as work
progresses.
Reconstruction/Rehabilitation
of Rural Sealed Roads
Table 5 below shows the Rural
Sealed Roads Reconstruction/Rehabilitation Program that was approved by Council
on 5 March, 2007.
Table 5. Proposed Rural Roads Reconstruction/Rehabilitation
Program 2007/08 – 2009/10 |
|||||
Road
Name |
Location |
Estimated Cost |
Section 94 |
Council Cost |
Priority |
2007/2008
|
|||||
|
8.2 –
9.5km from RR7767 |
$
109,000 |
- |
$
109,000 |
1.81 |
|
9.6 –
10.8km from Big Post |
$
100,000 |
- |
$
100,000 |
1.45 |
|
2.12 –
3.0km from RR128 |
$ 75,000 |
- |
$ 75,000 |
1.44 |
|
4.7 –
5.2km from SH 9 |
$ 45,000 |
- |
$ 45,000 |
1.66 |
|
1.7 –
2.2km from SH 27 |
$ 45,000 |
- |
$ 45,000 |
1.42 |
Total
2007/2008 |
$ 374,000 |
- |
$ 374,000 |
|
|
2008/2009
|
|||||
|
5.0 –
5.85km from |
$
80,000 |
- |
$
80,000 |
1.95 |
|
11.25 –
12.0km from SH9 |
$
75,000 |
- |
$
75,000 |
1.71 |
Stanhope Road |
9.0 –
9.7km from |
$
83,000 |
- |
$
83,000 |
1.68 |
|
3.0 –
3.5km from |
$ 66,000 |
- |
$ 66,000 |
1.58 |
|
1.75 –
2.5km from |
$
70,000 |
- |
$
70,000 |
1.39 |
Total 2008/2009 |
$ 374,000 |
- |
$ 374,000 |
|
|
2009/2010 |
|||||
|
10.4 –
11km from RR7767 |
$
80,000 |
- |
$
80,000 |
1.72 |
|
0.0 –
0.9km from SH 9 |
$ 120,000 |
- |
$ 120,000 |
1.32 |
Total
2009/2010 |
$ 180,000
|
- |
$ 180,000 |
|
Review of Program
An annual review of all of Council’s sealed rural roads has been
carried out in order to assess their condition and need for upgrading. The
assessment initially involved a visual inspection of the roads to generally
rate their condition and to identify sections with deficiencies. Once all of
the sections appraised as being in fair or less than fair condition were
determined they were assessed using Council’s adopted methodology for
prioritising projects. This process considers similar deficiencies to those
described previously for urban roads. Again, the methodology is explained in the Roads Management
Strategy.
A review of the
2009/10 program, adopted in principle for the 2007/08 budget found the section
programmed for rehabilitation on
As the need for funds
for sealing unsealed roads will have diminished by 2009/10 and there is no
allowance for bridge replacement in that year, it will free up funds to be
available for rehabilitation of sealed roads. Hence, two new projects have been
added to the 2009/10 program. They are on
The projects for the
additional three years were programmed according to the above mentioned
methodology. Councillors should also note that even though the methodology
ranks the projects in order of priority there is a conscious effort to share
the available funding around the local government area, unless the urgency of
the works dictates otherwise.
Accordingly, the necessary adjustments have been made to the proposed program.
Table 6, below
proposes a revised program of sections of rural roads to be rehabilitated or
reconstructed from 2008/09 to 2012/13.
Table 6. Proposed Rural Roads Reconstruction/Rehabilitation
Program 2008/09 – 2012/13 |
||||||
Road
Name |
Location |
Estimated Cost |
Section 94 |
Council Cost |
Priority |
|
2008/2009 |
||||||
|
5.0 –
5.7km from |
$
72,000 |
$ 2,000 |
$ 70,000 |
1.68 |
|
|
11.25 –
12.0km from H9 |
$ 82,000 |
- |
$ 82,000 |
1.43 |
|
Stanhope Road |
9.0
–9.7km from |
$
77,000 |
- |
$ 77,000 |
1.57 |
|
|
3.0 –
3.5km from |
$ 80,000 |
$ 8,645 |
$ 71,355 |
1.07 |
|
|
1.75 –
2.5km from |
$
70,000 |
- |
$ 70,000 |
1.12 |
|
Total 2008/2009 |
$
381,000 |
$ 10,645 |
$ 370,355 |
|
||
2009/2010 |
||||||
|
13.8 –
15.05km from RR7767 |
$ 130,000 |
|
$ 130,000 |
1.44 |
|
|
00 –
0,9km from H9 |
$ 110,000 |
|
$ 110,000 |
1.37 |
|
|
4.45 –
4.65km & |
$ 47,000 |
- |
$
47,000 |
1.39 |
|
|
2.44 –
3.1km from H27 |
$ 70,000 |
|
$
70,000 |
1.36 |
|
Total 2009/2010 |
$
357,000 |
- |
$ 357,000 |
|
||
2010/2011 |
||||||
|
8.9 –
9.9km from |
$
90,000 |
- |
$
90,000 |
1.68 |
|
Stanhope Road |
6.1 –
7.2km from |
$ 115,000 |
- |
$ 115,000 |
1.53 |
|
|
3.0 –
4.3km from RR128 |
$
125,000 |
- |
$ 125,000 |
1.38 |
|
|
0.75 –
1.0km from |
$ 27,000 |
|
$ 27,000 |
1.56 |
|
Total
2010/2011 |
$ 357,000 |
- |
$ 357,000 |
|
||
|
||||||
2011/2012 |
||||||
|
2.3 –
2.75 & 3.62 – 3.94km from |
$ 137,000 |
- |
$
137,000 |
1.03 |
|
|
2.35 –
3.3km from H9 |
$ 105,000 |
- |
$
105,000 |
1.71 |
|
|
0.1-
1.25km from |
$
115,000 |
|
$ 115,000 |
1.68 |
|
Total
2011/2012 |
$ 357,000 |
- |
$ 357,000 |
|
||
2012/2013 |
||||||
|
5.7 –
6.2km from |
$
80,000 |
- |
$
80,000 |
1.05 |
|
Stanhope Road |
4.1 –
4.6km from |
$
70,000 |
- |
$
70,000 |
1.26 |
|
|
4.3 –
5.6km from RR128 |
$
125,000 |
- |
$ 125,000 |
1.38 |
|
|
1.25 –
2.05km from |
$
82,000 |
|
$ 82,000 |
1.68 |
|
Total
2012/2013 |
$ 357,000 |
- |
$ 357,000 |
|
||
As with the proposed
urban projects, without design plans it is difficult to estimate costs for
these projects. The given estimates can therefore only be considered as “order
of cost” estimates. Once again, any need to vary this program will be reported
as work progresses.
Although the program
covers a five year period and there will be further deterioration of our road
network in that time, we have made excellent progress on improving our roads.
This program brings us to the closest we have been to providing the whole of
the sealed road lengths of our network to a standard where the condition of all
roads is better than fair. This is the best condition our roads have been in,
in at least, the last twenty five years.
Management Plan:
The overall
objective of the Works Program Area is:
“To provide
efficient and effective management of resources in order to maintain all
transport infrastructure in a safe condition and in a manner that minimises
life cycle costs.”
The Strategic Aims of
the Works Program Area that relate to this report are as follows:
· Sustain or improve the serviceability of the transport Infrastructure.
· Minimise Council general revenue expenditure on transport infrastructure
whilst optimising the benefits to the community.
· Minimise
Council’s exposure to transport infrastructure associated litigation.
Council Policy:
The relevant policies of Council that apply to
this report are: -
1. Council’s Non Maintained Roads Policy (minute 250/96) which outlines:
“That Council only accept existing non maintained roads, upon
application, for future maintenance if they meet the following criteria:
i) The road has been
formed, graveled and drained to Council’s Development Control Plan, Design and
Construction Specifications.
ii) The road serves six or more dwelling houses (or business buildings) that exist at the time of the application.”
2. Council’s adopted “Roads Management Strategy” (minute 95/99) which outlines that:
“It is Singleton Council’s challenge to provide and maintain a road
network that meets the needs of all sectors of the community by the most
cost-effective means. This manual seeks to outline a step by step strategy to
implement a transparent management policy to provide and maintain roads under
the care and responsibility of this Council, which reflect the needs of the community.”
Legislation:
Part 6, Division 1, Section 71 of the Roads Act – 1993 outlines that:
“A roads authority may carry out
road work on any public road for which it is the roads authority and on any
other land under its control.”
The critical word in this section of legislation is “may” as this clearly signifies that a Roads Authority (Council) is not obliged to maintain or carry out any work on a road under its control. There is also no other part of the Act that obliges Council to maintain a road under its care and control.
Sustainability:
Social:
The Community will benefit significantly from the proposed programs. Generally, motorists using the newly sealed or reconstructed roads will benefit from enhanced ride comfort, which also reduces the wear and tear on their vehicle, thereby reducing road user costs.
Environmental:
Sealing of unsealed roads will
help overcome environmental problems, such as dust emission that impacts on
adjacent properties and residences. All of the programs will improve the
amenity or aesthetics of these areas to the benefit of those who live near and
use these roads.
Financial:
The
financial viability of sealing unsealed roads that carry 75 vpd or more is
realised in reduced routine maintenance costs and increased intervals in
periodic maintenance. Rehabilitating deteriorated sealed roads extends the life
of a road and significantly reduces the routine maintenance costs of preserving
the road.
Risk Management:
The governing policy for Risk Management on Council’s Roads and associated infrastructure, is as follows:
“Singleton Council will
endeavour to exercise it’s duty of care in relation to dedicated Council Public
Roads, by taking all reasonable steps to enhance the
safety of road users, with due regard being given to the nature of the
defect, the level of risk, the use of
the road, funding constraints, competing
priorities and minimum standards.”
Conclusions:
Overall, the above programs are considered to:
· Optimise the use of available funds,
· Be cost effective, and
· Spread the benefits of the works to as much of the community as possible, whilst keeping those roads with the greatest need in mind.
It is therefore deemed that the proposed program of works is in line with the relevant policies, aims and objectives of Council.
1) The Sealing of Unsealed Roads Program
for 2008/09 as shown in the table below be adopted and that the proposed
program for the ensuing four years be adopted in principle, to define
Council’s priority order.
2) The Urban Sealed Roads
Reconstruction/Rehabilitation Program for 2008/09 as shown in the following
table be adopted and that the proposed program for the ensuing four years be
adopted in principle, to define Council’s priority order.
3) The Rural Sealed Roads
Reconstruction/Rehabilitation Program for 2008/09 as shown in the table below
be adopted and that the proposed program for the ensuing four years be
adopted in principle to define Council’s priority order.
4) The following projects be
assigned to the Roads to Recovery Program in 2008/09: i) Kirkton
Road – 3.4 – 4.4km from H9 $ 107,000 ii) Westbrook
Road – 5.0 – 5.6km from iii) Bridgman
Road – 11.25 – 12.0km from H9 $ 82,000 iv) Stanhope
Road – 9.0 – 9.7km from v) vi) Total $
468,355 5) $200,000 be set aside in the 2008/09
budget and $115,000 in each of the 2010/11, 2011/12 and 2012/13 budgets from
the Local Roads Improvement Program for the replacement of timber bridges on
local roads. |
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Works Report No. 2/08 |
|
|
8. |
Plant Tenders Author: Brendan Behringer |
FILE: T2008.001 |
Executive
Summary: Tenders closed on 19 February 2008 for the supply of three trucks to replace existing trucks in accordance with Council’s Plant Replacement Program. A report has been prepared for Council’s
Committee of the Whole as the discussion of this matter in open Council would
prejudice the commercial position of the tenderers. |
RECOMMENDED that the tenders received be considered in the Committee of the Whole for the reason stated in Section 10A (2) (d) (i) of the Local Government Act, 1993, as discussions of this matter in open Council would prejudice the commercial position of the tenderers. |
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Manager
Works Report No. 2/08 |
|
|
9. |
Author: Greg McTaggart |
FILE: 01/0228 |
Executive Summary: A concentrated
effort on the replacement of timber bridges with concrete structures has seen
a large reduction in the number of timber bridges within this local
government area in recent years. Ten years ago there were 25 timber bridges
on local roads. With the funding approved and available through various
sources to date, there will be four by the end of 2008. However the remaining
timber structures still provide a major maintenance liability and risk. The
combination of their age, the difficulty of sourcing timber and increased
truck mass limits means all our timber bridges need to be replaced. Some are
structurally deficient and some are under width. Although exceptional progress has been
made, we still need to work on funding replacement of the existing timber bridges
before we start construction of new bridges over streams that are currently
without bridges. |
Background:
Council resolved on 5 March, 2007 that:
1. Council note the following list of timber bridges are in need of funding for replacement:
·
·
· Brookers Bridge on
·
·
·
2. $200,000 be allocated annually to the
replacement of timber bridges, from the FAG allocation.
3.
4. Any funds left over from the replacement
of
5. Should any further funds still remain
these are to be used for investigation and design of replacement structures.
6. The Manager Works utilize all existing and potential sources
of income to progressively replace the timber bridge with concrete structures.
7. The general order of construction to be determined by the
bridge with the highest level of funds contributed from alternative sources.
Review of Program
Since the last review of this
program, sufficient funds have been acquired for the replacement of
Geotechnical investigations at the
In addition to this and as a result of the June 2007
Flood, $202,250 was claimed and approved for replacement of two spans that were
lost from Moses Crossing Bridge. Council’s submission was based on replacement
of the missing spans using the standards of today. Those standards included
concrete encased steel piles, concrete headstocks and a 4.2 metre wide concrete
deck.
Currently,
Another timber bridge that is currently under
Council’s care and control that is in a serious state of disrepair is the three
span structure on
In summary, the remaining timber bridges on local
roads within the Singleton Local Government Area, that have not been allocated
funds for complete replacement are shown below: -
·
· Brookers Bridge on
·
·
.
Proposed Program
Funding Levels – Financial Assistance Grant
In line with the recommendation of
the Local Roads Improvement Program it is proposed that $200,000 be allocated
in the 2008/09 budget and $115,000 in each of the 2010/11, 2011/12 and 2012/13
budgets for the replacement of timber bridges. As funds are very scarce in
2009/10 no recommendation has been made to provide funds from this source for
that year.
Estimated Costs
Since the Supplementary Auslink Roads to Recovery
Program works schedule was formulated to include the replacement of five
bridges, additional costs, over and above those estimated include the provision
of side tracks, demolition of the existing structures, land acquisition,
adjustment to utilities and CPI increases. Nevertheless, two of these bridges
have been completed and I am confident we will manage to complete the three
outstanding bridges within the Auslink Program with the funds available. I am
also confident that the two bridges currently out to tender will be completed
within budget and with the funds available.
It can therefore be concluded that
any new funds allocated in the 2008/09 budget will be available for the four
remaining timber structures.
Management Plan:
The main objective of the Works Program Area is to provide efficient and
effective management of resources in order to maintain all transport
infrastructure in a safe condition and in a manner that minimises life cycle
costs. The proposed outcome of this matter specifically compliments four of the
Strategic Aims of Council’s Management Plan. Those aims are to:
1. Improve the serviceability of the transport infrastructure,
2. Reduce the impact that storm events have on residential
amenity,
3. Minimise Council’s exposure to litigation, and
4. Minimise Council’s general revenue expenditure on transport
infrastructure.
Council Policy:
With regard to “Bridge Priorities on Local Roads” the following Council
policy applies:
1. Council adopt the principle of replacing
existing bridges, with compromised structural integrity, before constructing
new bridges.
2. Double Crossing Bridge remain the highest
priority for new bridge construction and that First Creek Crossing on Long
Gully Road be allocated No. 2 priority for new bridge construction.
Legislation:
In Brodie v Singleton Shire
Council (2001) HCA 29 The High Court overturned well established authority
exempting public authorities from liability arising from omissions in failing
to perform their roles as highway authorities, to repair and maintain roads.
The High Court reversed this position, deciding that whether an
authority owed a duty to take positive steps to maintain and repair roads
should be determined according to ordinary negligence principles.
When the Civil Liability Act 2002
(“the CL Act”) was enacted it partially reinstated the immunity. Instead of
providing immunity from liability, the CL Act (section 42) sets out guidelines
relevant to a determination of whether or not a public authority has breached
its duty of care.
Section 42 of the CL Act prescribes that the following principles apply
in determining whether a public or other authority has breached a duty of care
in proceedings for civil liability:
(a) the functions required to be exercised by
the authority are limited by the financial and other resources that are
reasonably available to the authority for the purpose of exercising those
functions,
(b) the general allocation of those resources
by the authority is not open to challenge,
(c) the functions required to be exercised by
the authority are to be determined by reference to the broad range of its
activities (and not merely by reference to the matter to which the proceedings
relate),
(d) the authority may rely on evidence of its
compliance with the general procedures and applicable standards for the
exercise of its functions as evidence of the proper exercise of its functions
in the matter to which the proceedings relate.
Under section 42, a number of considerations are required to be made
including the broad range of activities undertaken, limitation on financial
resources, and their general allocation.
Sustainability:
Social:
Bridges
are essential to the social well being of a community. The loss of a structure
or the placing of load limits on bridges that are significantly under strength
can result in the need for long detours or in some cases access being totally
cut. The social ramifications of this are obvious. This loss of access or extra
traveling time can have severe flow on effects on the local and in many areas,
the national economy, through extra road user costs and lost productivity.
Environmental:
A Review of
Environmental Factors will be carried out prior to commencement of a bridge
project. This will identify any detrimental environmental issues (if any) and
address ways to negate or reduce these to an acceptable level. The replacement
of timber bridges with concrete structures will also reduce noise considerably
for adjacent residents.
With the closure of
many of our State’s Forests, the availability of timber, one of our most
renewable resources, is becoming more and more difficult to procure.
Unfortunately, many of the well managed hardwood forests have been handed over
to organizations that do not permit logging of any kind and as a result the
logs from which bridge timber is cut, are now in very short supply.
Financial:
Bridges with compromised
structural integrity are continually in need of costly maintenance works to
enable them to provide some level of service to the community. The absence of
funds for the replacement of timber bridges increases Council’s annual
maintenance costs significantly and heightens the life–cycle costs of the
structure.
Risk Management:
Council’s overall risk management policy for roads and associated
infrastructure is as follows:
“Singleton Council will
endeavour to exercise its duty of care in relation to dedicated Council Public
Roads, by taking all reasonable steps to enhance the
safety of road users, with due regard being given to the nature of the
defect, the level of risk, the use of the road, funding constraints, competing
priorities and minimum standards.”
The replacement of outdated timber bridges
with reduced strength should enhance the safety of the traveling public
significantly and assist Council in complying with its risk management policy
and its duty of care.
Options:
In order of condition, Bourkes Crossing is the best,
As funds are available for the
replacement of the two missing spans on Moses Crossing it makes sense to
replace the balance of the bridge to the same standard. With the proposed
funding of $200,000 it will go close to allowing this. That is, if we construct
a single lane bridge at the same level as the existing structure that has
performed so well in the past. Although it goes under water for short periods a
few times a year it provides a good level of service for the low level of
traffic that uses it. The major benefit of the proposed new structure will be
lifting of the existing 15 Tonne Load Limit on the bridge.
The alternative is to utilize part
of the $200,000 on geotechnical investigation and design ($20,000) and put the
balance towards the construction of a new bridge to replace
Conclusions:
In summary, it is reasonable to say that the cost of replacing timber bridges with compromised structural integrity far outweighs the potential extra social, economic, maintenance, litigation and life-cycle costs of not replacing these structures. Because circumstances change, the process of allowing the Manager the flexibility to identify and take advantage of opportunities has proved fruitful in the past and has been appreciated. The necessity of sufficient funding being allocated to this program will speed up our endeavour to replace all timber bridges and allow us to move on to constructing new bridges on streams that currently do not have bridges.
1. Council note the following list of bridges are the last of our timber bridges on Local Roads and are in need of funding for replacement: · · Brookers Bridge on · · 2. Council combine the $202,250 available
for replacement of the spans lost in the June 2007 flood from 3. Should any
further funds still remain then they be used for geotechnical investigation
and design for the replacement of
G. McTaggart Gary
Woodman Manager Works Director Operations |
There are no attachments for this report.
Meeting of Operations Committee - 3 March 2008 |
|
|
|
|
Questions
of Which Notice Has Been Given Report No. 4/08 |
|
|
1. |
Questions of
Which Notice Has Been Given Author: John Waghorn |
FILE: 06/0045 |
Detail: 1. Cr Scott – CRF 1071 Public Phone/Bus Shelter – a ratepayer has requested me to ask
Council if it would approach the appropriate Departments within government to
place: a) A public telephone installed in b) A bus shelter constructed in Response: With regard to b); Investigation will be carried
out as to the possible inclusion of a bus shelter at This project will be looked at with other
competing priorities and the on going maintenance costs given the high level
of vandalism to other bus shelters. 2. Cr Scott – CRF 1081 Response: This matter is being investigated by the Traffic Coordinator and will be considered by the Local Traffic Committee and reported back to Council through the minutes of that meeting. 3. Cr Mac Bain – CRF 1142 Could council investigate
the drainage issue of Response: This section of The shoulder widening works were carried out in preparation of this and Works are waiting for Water and Waste Program Area to install a new Water Main along the Golf Course side before completing the rehabilitation. The new Water Main work is programmed for the next few weeks and whilst it is being installed, improvements to stormwater drainage will be made concurrently. 4. Cr Moore - CRF 1305 Do all Causeways have depth markers in place? If not, could this
be looked at? Response: Most of the formed concrete causeways and particularly those with known flooding issues are sign posted with depth markers and warning signs of the approach to a causeway. The sign posting of causeways is part of an ongoing sign maintenance and installation program and as deficiencies are identified and as funds permit, signs are installed. 5. Cr Moore - CRF 0989 Response: No further funding has been able to be sourced for the unmaintained
section of 6. Cr Moore – CRF 0980 Council Waste Water – report on suggestions by ratepayers as
newspaper article and also use of water by Council on road work particularly
in such a dry time. Response: With regard to use of water by Council on road works -: Councils Works Program Area is highly aware of its responsibilities when it comes to the appropriate use of water for road works particularly in dry times. Additional water carts are sourced (at a significant increase to the overall project cost), and water is hauled to the projects from the town stand pipes. No water is taken from creeks or streams when they have stopped running and staff are constantly making arrangements with land owners or affected residents to minimise any impacts of water usage for roadworks. 7. Cr Moore - CRF 1303 Stanhope Road issues. 850 - 950 approx when is this section
proposed for rehabilitation (grading needed urgently). Also section 600 – 750
approx when is this section proposed for rehabilitation (grading needed
urgently). As part of the Local Roads Improvement Program, these sections of · 9.00 to 9.70km for consideration in 2008/2009 · 6.10 to 7.20km for consideration in 2010/2011 These sections have recently had shoulder grading works carried
out on them. 8. Cr Gallagher - CRF 3/12/07 Request a report on the cost of constructing a footpath along Response: The section of footpath between the 9. Cr Sharrock – CRF 1232 Speed Limits – Response: This matter was considered at the meeting of the Local Traffic Committee on 19 February 2008. The response to this request is contained in the minutes of that meeting under the Manager Works Report No. 2/08. |
FOR
COUNCIL’S INFORMATION |
There are no attachments for this report.
